1   Cheniere Energy Analyst / Investor Day   April 7, 2014

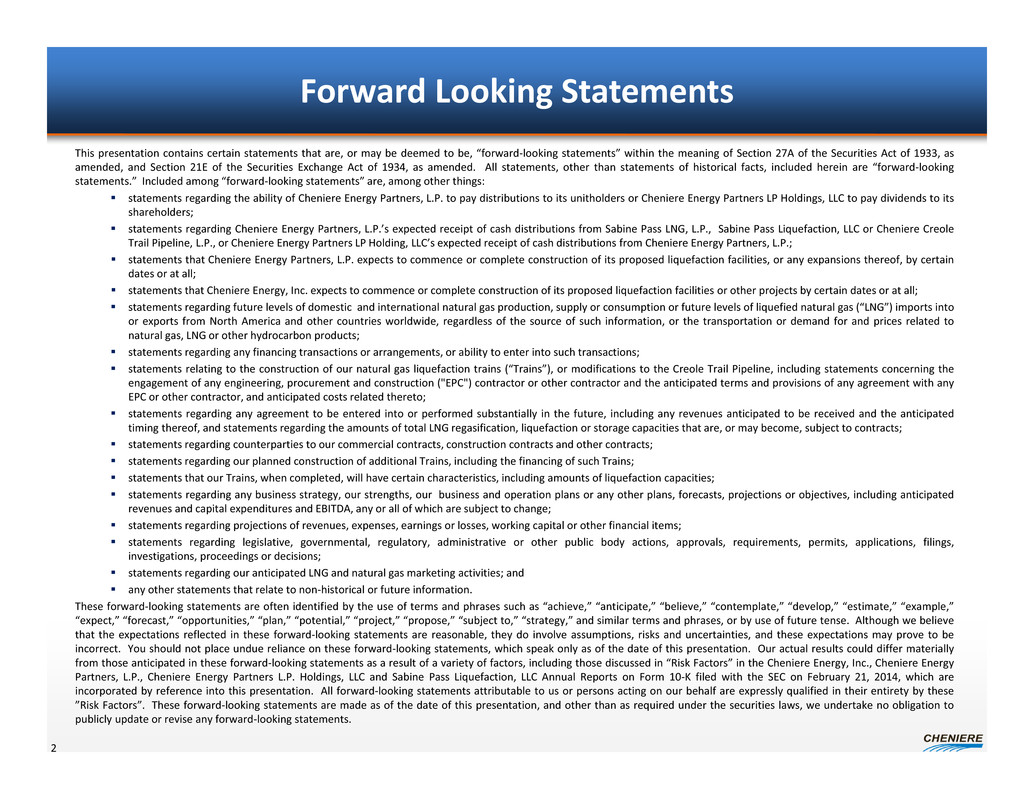

Forward Looking Statements   2   This presentation contains certain statements that are, or may be deemed to be, “forward‐looking statements” within the meaning of Section 27A of the Securities Act of 1933, as   amended, and Section 21E of the Securities Exchange Act of 1934, as amended. All statements, other than statements of historical facts, included herein are “forward‐looking   statements.” Included among “forward‐looking statements” are, among other things:    statements regarding the ability of Cheniere Energy Partners, L.P. to pay distributions to its unitholders or Cheniere Energy Partners LP Holdings, LLC to pay dividends to its   shareholders;    statements regarding Cheniere Energy Partners, L.P.’s expected receipt of cash distributions from Sabine Pass LNG, L.P., Sabine Pass Liquefaction, LLC or Cheniere Creole   Trail Pipeline, L.P., or Cheniere Energy Partners LP Holding, LLC’s expected receipt of cash distributions from Cheniere Energy Partners, L.P.;    statements that Cheniere Energy Partners, L.P. expects to commence or complete construction of its proposed liquefaction facilities, or any expansions thereof, by certain   dates or at all;    statements that Cheniere Energy, Inc. expects to commence or complete construction of its proposed liquefaction facilities or other projects by certain dates or at all;    statements regarding future levels of domestic and international natural gas production, supply or consumption or future levels of liquefied natural gas (“LNG”) imports into   or exports from North America and other countries worldwide, regardless of the source of such information, or the transportation or demand for and prices related to   natural gas, LNG or other hydrocarbon products;    statements regarding any financing transactions or arrangements, or ability to enter into such transactions;    statements relating to the construction of our natural gas liquefaction trains (“Trains”), or modifications to the Creole Trail Pipeline, including statements concerning the   engagement of any engineering, procurement and construction ("EPC") contractor or other contractor and the anticipated terms and provisions of any agreement with any   EPC or other contractor, and anticipated costs related thereto;    statements regarding any agreement to be entered into or performed substantially in the future, including any revenues anticipated to be received and the anticipated   timing thereof, and statements regarding the amounts of total LNG regasification, liquefaction or storage capacities that are, or may become, subject to contracts;    statements regarding counterparties to our commercial contracts, construction contracts and other contracts;    statements regarding our planned construction of additional Trains, including the financing of such Trains;    statements that our Trains, when completed, will have certain characteristics, including amounts of liquefaction capacities;    statements regarding any business strategy, our strengths, our business and operation plans or any other plans, forecasts, projections or objectives, including anticipated   revenues and capital expenditures and EBITDA, any or all of which are subject to change;    statements regarding projections of revenues, expenses, earnings or losses, working capital or other financial items;    statements regarding legislative, governmental, regulatory, administrative or other public body actions, approvals, requirements, permits, applications, filings,   investigations, proceedings or decisions;    statements regarding our anticipated LNG and natural gas marketing activities; and    any other statements that relate to non‐historical or future information.   These forward‐looking statements are often identified by the use of terms and phrases such as “achieve,” “anticipate,” “believe,” “contemplate,” “develop,” “estimate,” “example,”   “expect,” “forecast,” “opportunities,” “plan,” “potential,” “project,” “propose,” “subject to,” “strategy,” and similar terms and phrases, or by use of future tense. Although we believe   that the expectations reflected in these forward‐looking statements are reasonable, they do involve assumptions, risks and uncertainties, and these expectations may prove to be   incorrect. You should not place undue reliance on these forward‐looking statements, which speak only as of the date of this presentation. Our actual results could differ materially   from those anticipated in these forward‐looking statements as a result of a variety of factors, including those discussed in “Risk Factors” in the Cheniere Energy, Inc., Cheniere Energy   Partners, L.P., Cheniere Energy Partners L.P. Holdings, LLC and Sabine Pass Liquefaction, LLC Annual Reports on Form 10‐K filed with the SEC on February 21, 2014, which are   incorporated by reference into this presentation. All forward‐looking statements attributable to us or persons acting on our behalf are expressly qualified in their entirety by these   ”Risk Factors”. These forward‐looking statements are made as of the date of this presentation, and other than as required under the securities laws, we undertake no obligation to   publicly update or revise any forward‐looking statements.

Introduction   Analyst Day / Investor Day   Charif Souki ‐ Chairman, President, and CEO   April 2014

Value of the Cheniere Platform   People   4   Financial Strength   Cash Flows

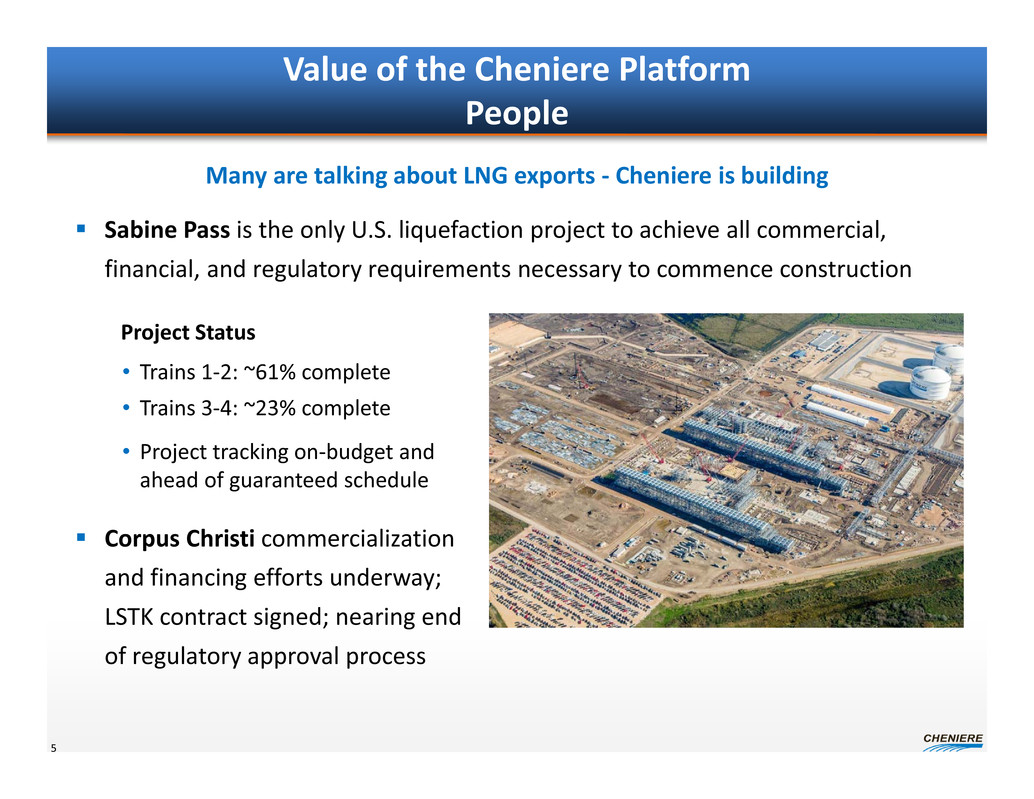

Value of the Cheniere Platform   People    Sabine Pass is the only U.S. liquefaction project to achieve all commercial,    financial, and regulatory requirements necessary to commence construction   Project Status   • Trains 1‐2: ~61% complete   • Trains 3‐4: ~23% complete   • Project tracking on‐budget and    ahead of guaranteed schedule    Corpus Christi commercialization   and financing efforts underway;   LSTK contract signed; nearing end   of regulatory approval process   5   Many are talking about LNG exports ‐ Cheniere is building

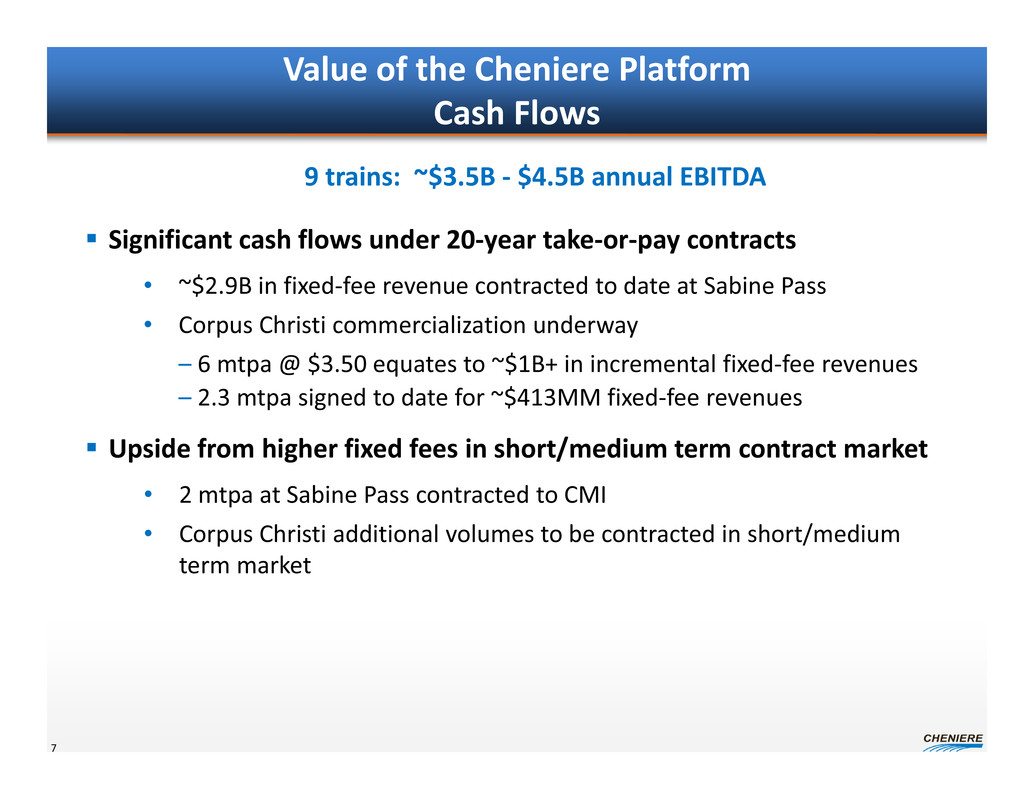

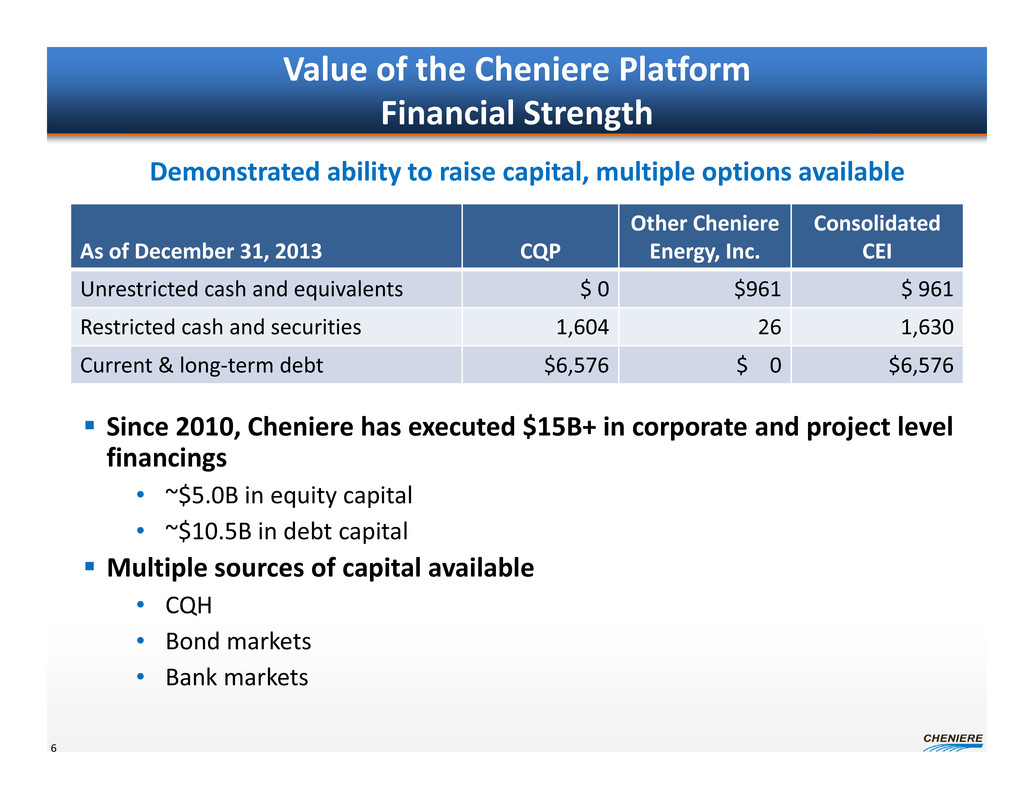

Value of the Cheniere Platform   Financial Strength   6    Since 2010, Cheniere has executed $15B+ in corporate and project level    financings   • ~$5.0B in equity capital   • ~$10.5B in debt capital    Multiple sources of capital available   • CQH   • Bond markets   • Bank markets   Demonstrated ability to raise capital, multiple options available   As of December 31, 2013 CQP   Other Cheniere   Energy, Inc.   Consolidated   CEI   Unrestricted cash and equivalents $ 0 $961 $ 961   Restricted cash and securities 1,604 26 1,630   Current & long‐term debt $6,576 $    0 $6,576

Value of the Cheniere Platform   Cash Flows    Significant cash flows under 20‐year take‐or‐pay contracts   • ~$2.9B in fixed‐fee revenue contracted to date at Sabine Pass   • Corpus Christi commercialization underway    – 6 mtpa @ $3.50 equates to ~$1B+ in incremental fixed‐fee revenues   – 2.3 mtpa signed to date for ~$413MM fixed‐fee revenues    Upside from higher fixed fees in short/medium term contract market   • 2 mtpa at Sabine Pass contracted to CMI   • Corpus Christi additional volumes to be contracted in short/medium    term market   7   9 trains:  ~$3.5B ‐ $4.5B annual EBITDA

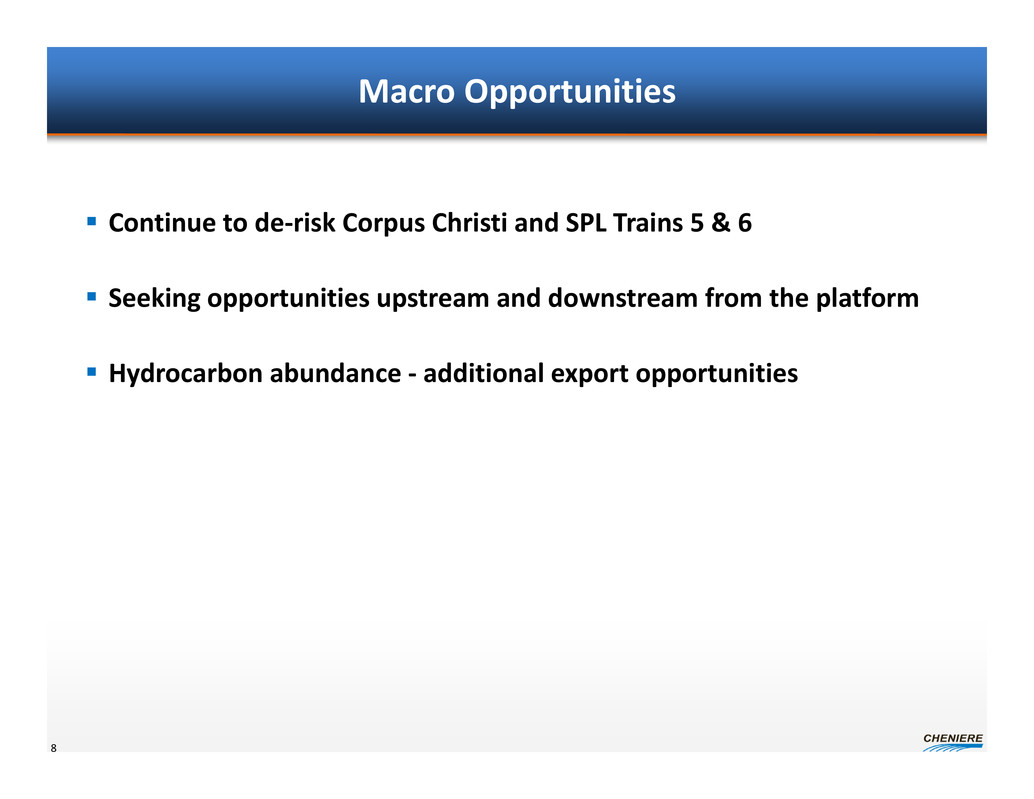

Macro Opportunities    Continue to de‐risk Corpus Christi and SPL Trains 5 & 6    Seeking opportunities upstream and downstream from the platform    Hydrocarbon abundance ‐ additional export opportunities   8

Keith Teague, Executive VP – Assets    April 2014   Sabine Pass Liquefaction Train 1‐4 Construction Update   Analyst / Investor Day

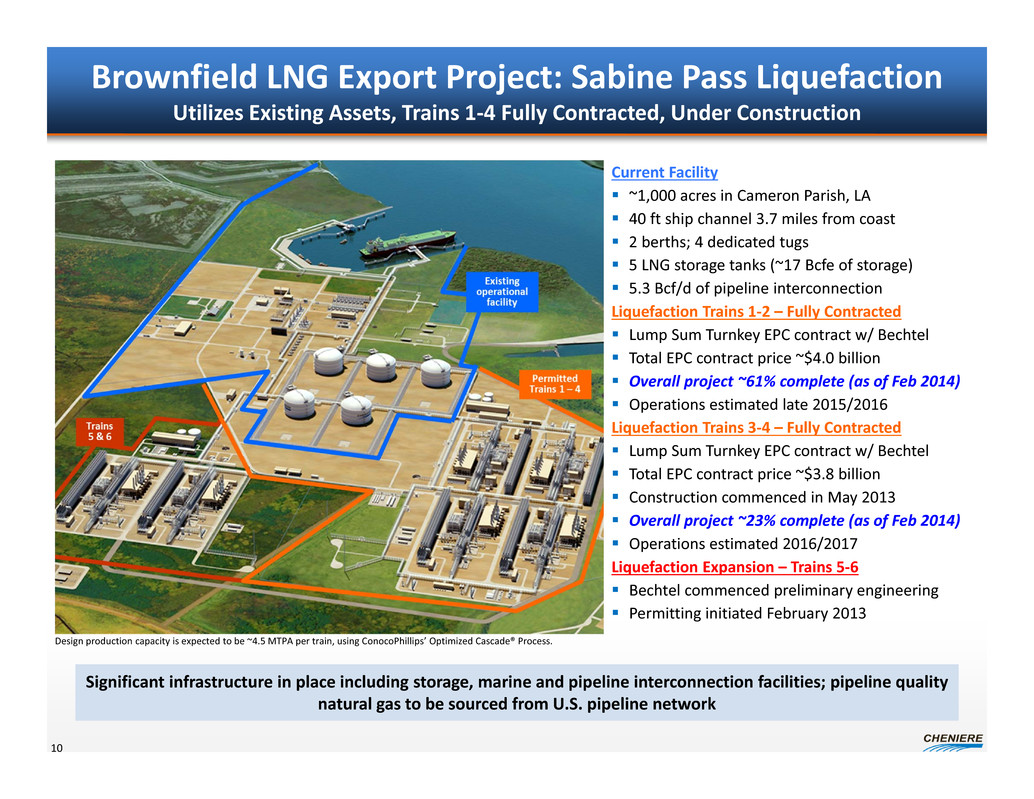

Brownfield LNG Export Project: Sabine Pass Liquefaction   Utilizes Existing Assets, Trains 1‐4 Fully Contracted, Under Construction   Current Facility    ~1,000 acres in Cameron Parish, LA     40 ft ship channel 3.7 miles from coast     2 berths; 4 dedicated tugs    5 LNG storage tanks (~17 Bcfe of storage)     5.3 Bcf/d of pipeline interconnection   Liquefaction Trains 1‐2 – Fully Contracted    Lump Sum Turnkey EPC contract w/ Bechtel    Total EPC contract price ~$4.0 billion    Overall project ~61% complete (as of Feb 2014)    Operations estimated late 2015/2016   Liquefaction Trains 3‐4 – Fully Contracted    Lump Sum Turnkey EPC contract w/ Bechtel    Total EPC contract price ~$3.8 billion    Construction commenced in May 2013    Overall project ~23% complete (as of Feb 2014)    Operations estimated 2016/2017   Liquefaction Expansion – Trains 5‐6    Bechtel commenced preliminary engineering    Permitting initiated February 2013   10   Design production capacity is expected to be ~4.5 MTPA per train, using ConocoPhillips’ Optimized Cascade® Process.   Significant infrastructure in place including storage, marine and pipeline interconnection facilities; pipeline quality    natural gas to be sourced from U.S. pipeline network

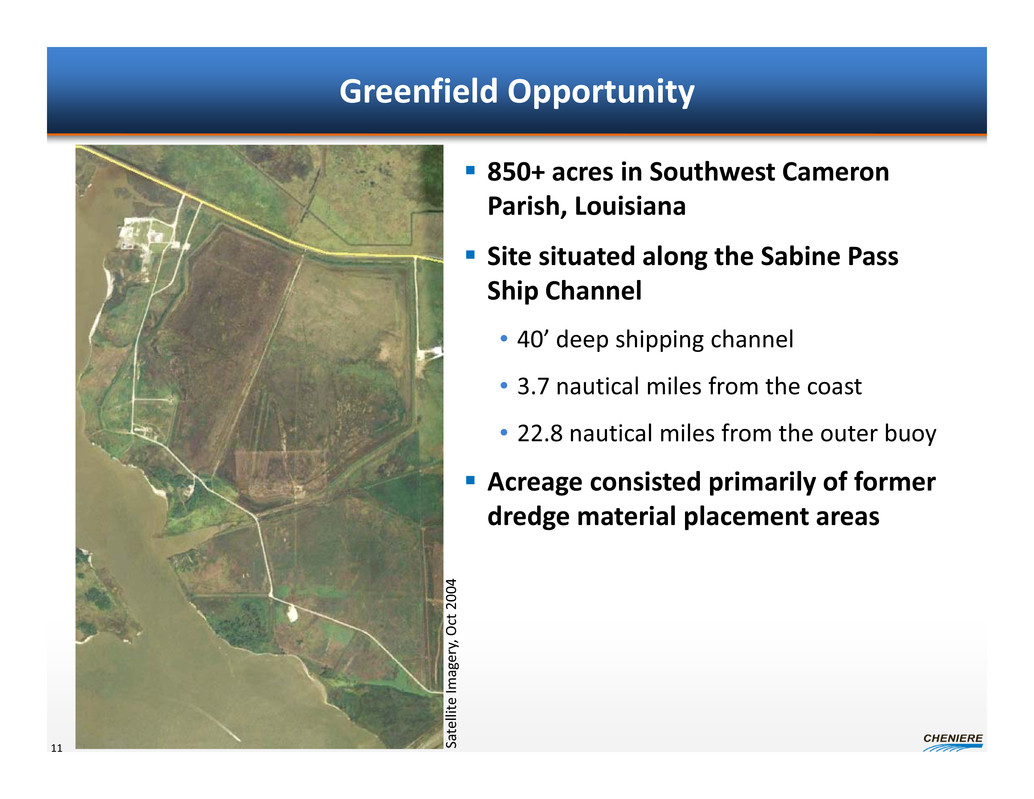

Greenfield Opportunity    850+ acres in Southwest Cameron    Parish, Louisiana    Site situated along the Sabine Pass    Ship Channel   • 40’ deep shipping channel   • 3.7 nautical miles from the coast   • 22.8 nautical miles from the outer buoy    Acreage consisted primarily of former    dredge material placement areas   S   a   t   e   l   l   i   t   e       I   m   a   g   e   r   y   ,       Oc   t       2   0   0   4   11

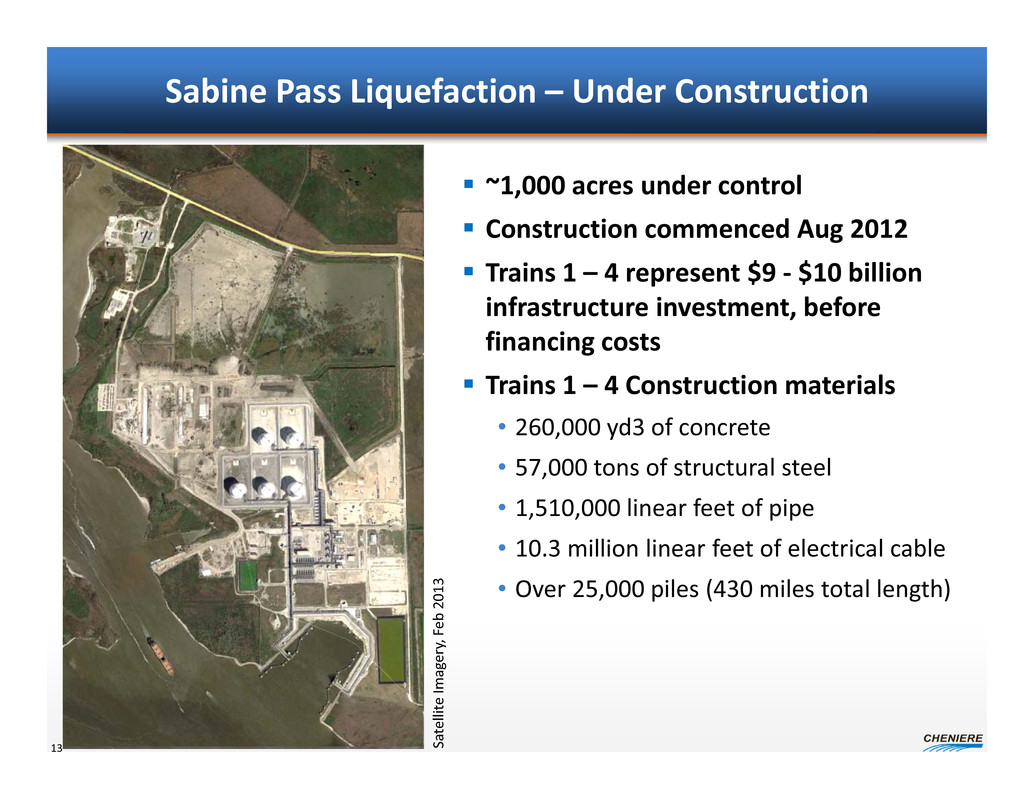

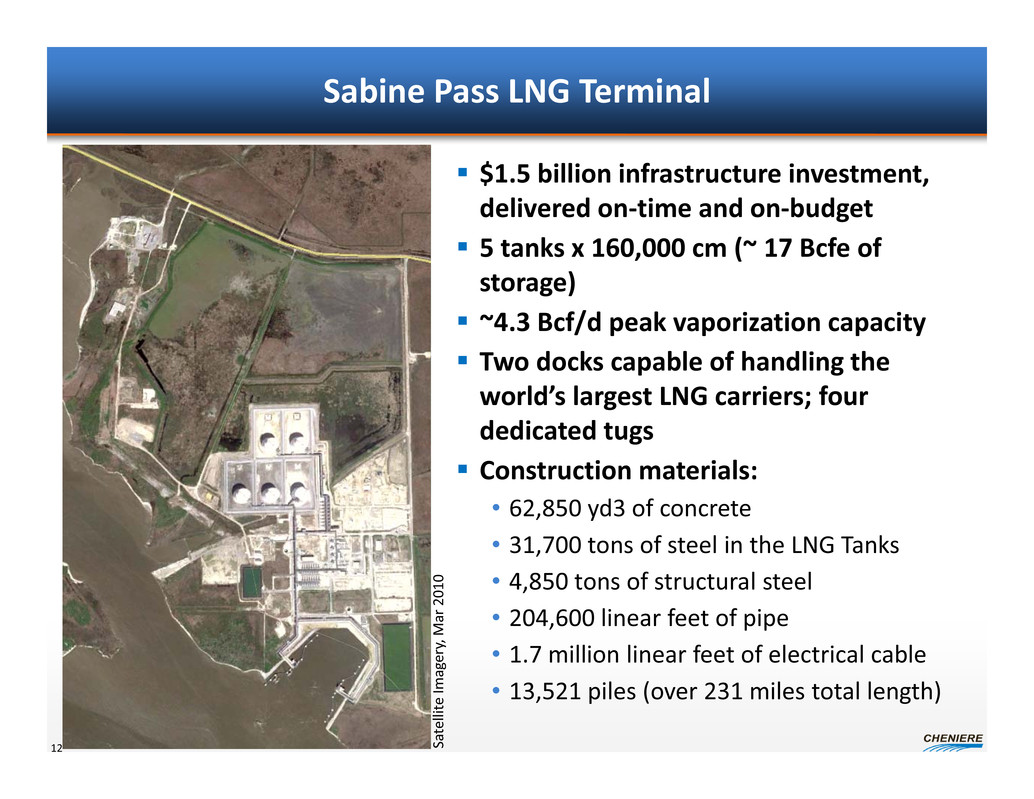

Sabine Pass LNG Terminal    $1.5 billion infrastructure investment,    delivered on‐time and on‐budget    5 tanks x 160,000 cm (~ 17 Bcfe of    storage)     ~4.3 Bcf/d peak vaporization capacity    Two docks capable of handling the    world’s largest LNG carriers; four    dedicated tugs    Construction materials:   • 62,850 yd3 of concrete   • 31,700 tons of steel in the LNG Tanks   • 4,850 tons of structural steel   • 204,600 linear feet of pipe    • 1.7 million linear feet of electrical cable   • 13,521 piles (over 231 miles total length)   S   a   t   e   l   l   i   t   e       I   m   a   g   e   r   y   ,       M   a   r       2   0   1   0   12

S   a   t   e   l   l   i   t   e       I   m   a   g   e   r   y   ,       F   e   b       2   0   1   3   Sabine Pass Liquefaction – Under Construction    ~1,000 acres under control    Construction commenced Aug 2012    Trains 1 – 4 represent $9 ‐ $10 billion    infrastructure investment, before    financing costs     Trains 1 – 4 Construction materials   • 260,000 yd3 of concrete   • 57,000 tons of structural steel   • 1,510,000 linear feet of pipe    • 10.3 million linear feet of electrical cable   • Over 25,000 piles (430 miles total length)   13

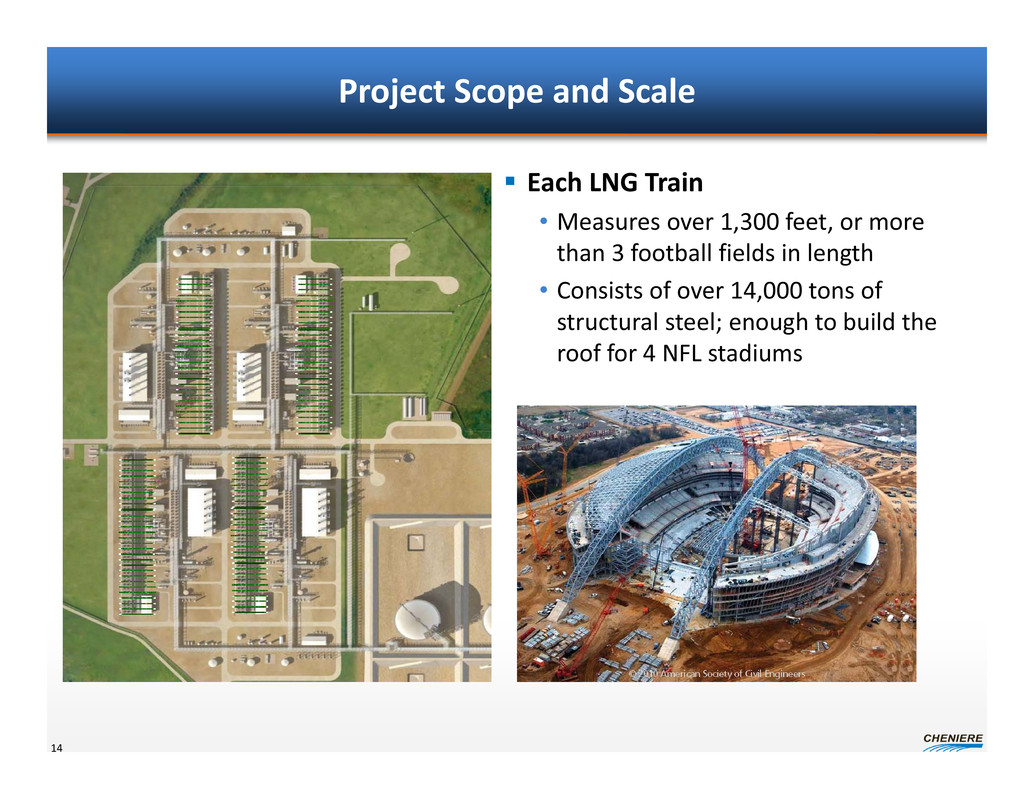

Project Scope and Scale    Each LNG Train    • Measures over 1,300 feet, or more    than 3 football fields in length   • Consists of over 14,000 tons of    structural steel; enough to build the    roof for 4 NFL stadiums   14

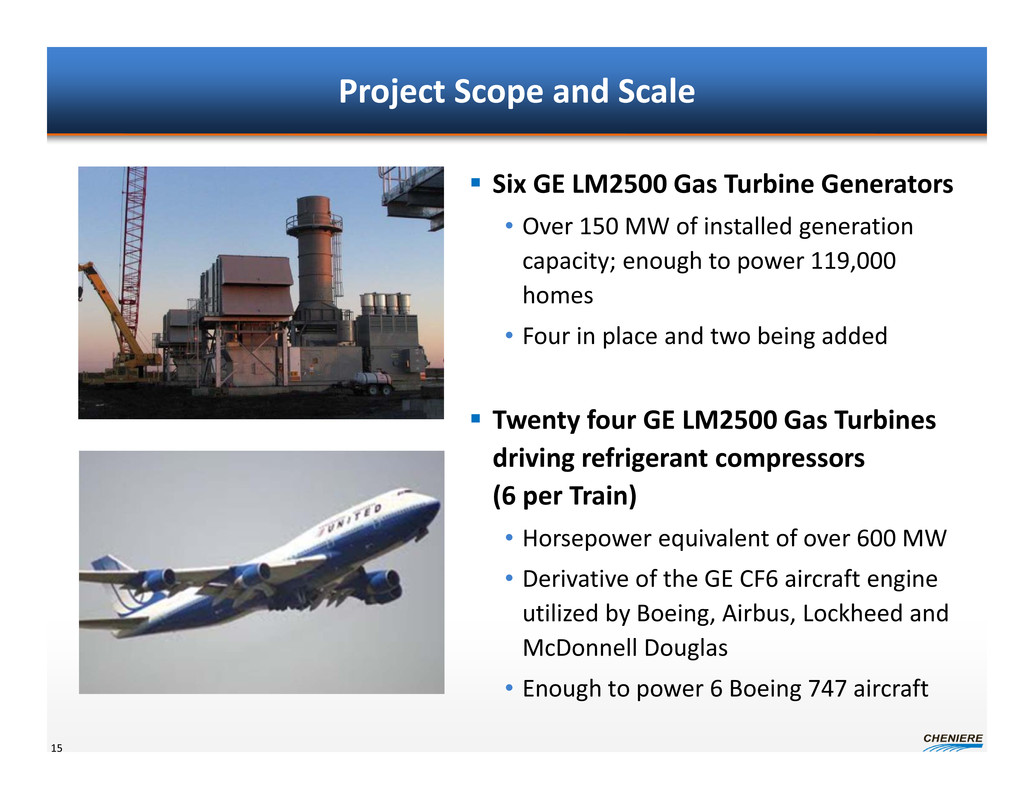

Project Scope and Scale    Six GE LM2500 Gas Turbine Generators   • Over 150 MW of installed generation    capacity; enough to power 119,000    homes   • Four in place and two being added    Twenty four GE LM2500 Gas Turbines    driving refrigerant compressors    (6 per Train)   • Horsepower equivalent of over 600 MW    • Derivative of the GE CF6 aircraft engine    utilized by Boeing, Airbus, Lockheed and    McDonnell Douglas   • Enough to power 6 Boeing 747 aircraft   15

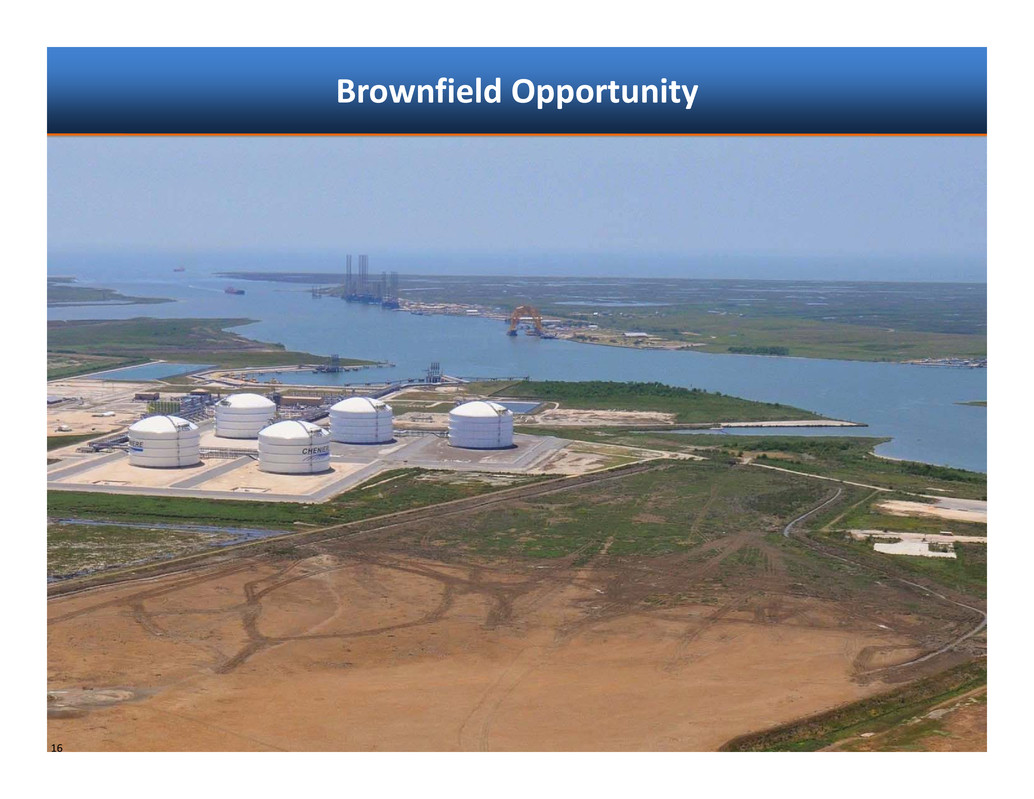

Brownfield Opportunity   16

Brownfield LNG Export Project   17

Project Scope and Scale    Four LNG Trains occupy a footprint    sufficient for six MLB stadiums    Project acreage:    • Footprint of approximately 22    acres per Train   • 60 acre footprint for    interconnecting pipe racks and    other facilities   • 245 acres for material staging,    laydown and employee parking   18

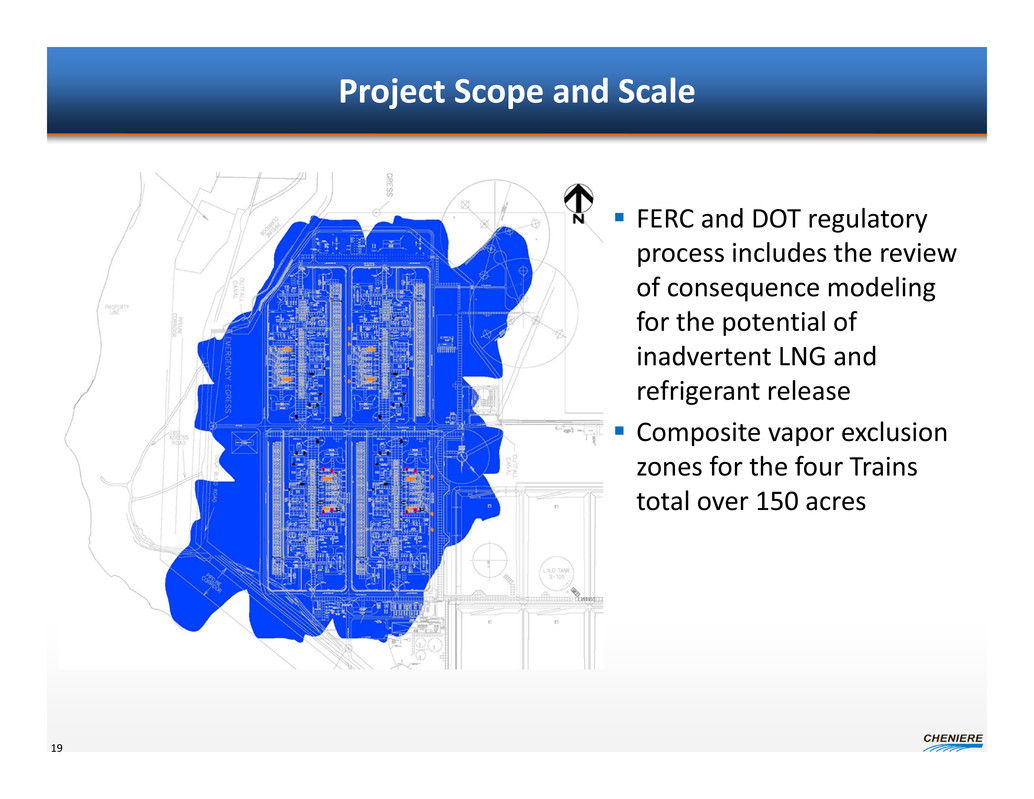

Project Scope and Scale    FERC and DOT regulatory    process includes the review    of consequence modeling    for the potential of    inadvertent LNG and    refrigerant release    Composite vapor exclusion    zones for the four Trains    total over 150 acres   19

Project Scope and Scale    FERC and DOT regulatory    process includes the review    of consequence modeling for    the potential of ignition and    resulting fire associated with    an inadvertent LNG and    refrigerant release    Composite thermal radiation    zones for the four Trains    total over 460 acres   20

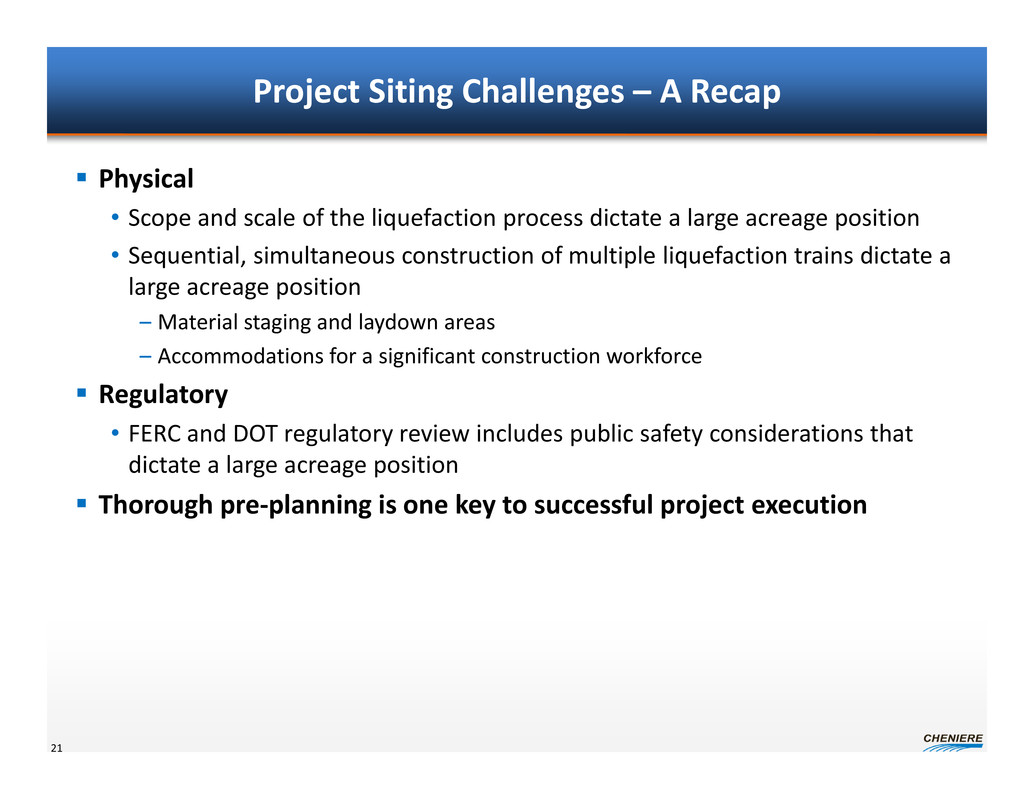

Project Siting Challenges – A Recap    Physical   • Scope and scale of the liquefaction process dictate a large acreage position   • Sequential, simultaneous construction of multiple liquefaction trains dictate a    large acreage position   – Material staging and laydown areas   – Accommodations for a significant construction workforce    Regulatory   • FERC and DOT regulatory review includes public safety considerations that    dictate a large acreage position    Thorough pre‐planning is one key to successful project execution   21

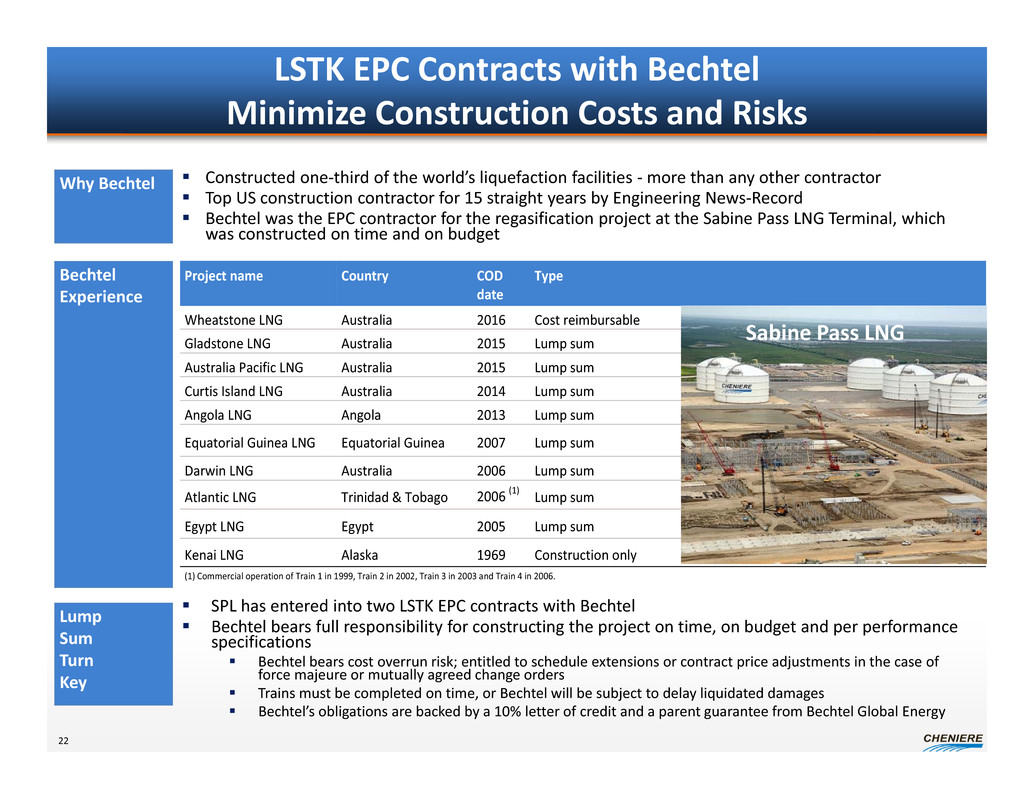

Why Bechtel  Constructed one‐third of the world’s liquefaction facilities ‐more than any other contractor  Top US construction contractor for 15 straight years by Engineering News‐Record    Bechtel was the EPC contractor for the regasification project at the Sabine Pass LNG Terminal, which    was constructed on time and on budget    Bechtel    Experience   Lump   Sum   Turn   Key    SPL has entered into two LSTK EPC contracts with Bechtel    Bechtel bears full responsibility for constructing the project on time, on budget and per performance    specifications    Bechtel bears cost overrun risk; entitled to schedule extensions or contract price adjustments in the case of    force majeure or mutually agreed change orders    Trains must be completed on time, or Bechtel will be subject to delay liquidated damages    Bechtel’s obligations are backed by a 10% letter of credit and a parent guarantee from Bechtel Global Energy   Project name  Country  COD    date    Type      Wheatstone LNG  Australia  2016  Cost reimbursable      Gladstone LNG  Australia  2015  Lump sum      Australia Pacific LNG  Australia  2015  Lump sum      Curtis Island LNG  Australia  2014  Lump sum      Angola LNG  Angola  2013  Lump sum      Equatorial Guinea LNG  Equatorial Guinea  2007  Lump sum      Darwin LNG  Australia  2006  Lump sum      Atlantic LNG  Trinidad & Tobago  2006    (1)  Lump sum      Egypt LNG  Egypt  2005   Lump sum      Kenai LNG  Alaska  1969  Construction only      (1) Commercial operation of Train 1 in 1999, Train 2 in 2002, Train 3 in 2003 and Train 4 in 2006.   LSTK EPC Contracts with Bechtel    Minimize Construction Costs and Risks   22   Sabine Pass LNG

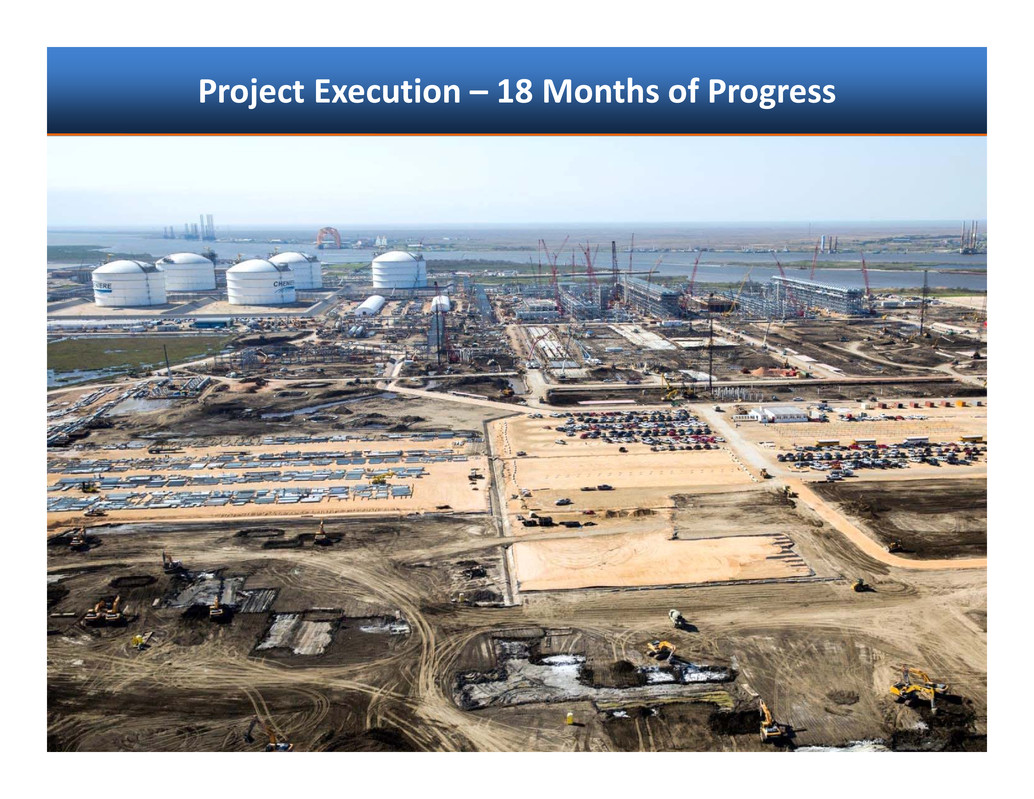

Project Execution – 18 Months of Progress   23

Project Execution – Trains 1 & 2

Project Execution – Trains 3 & 4

Project Execution – Train 1

Project Execution – Train 2

Project Execution – New Warehouse and O&M Buildings

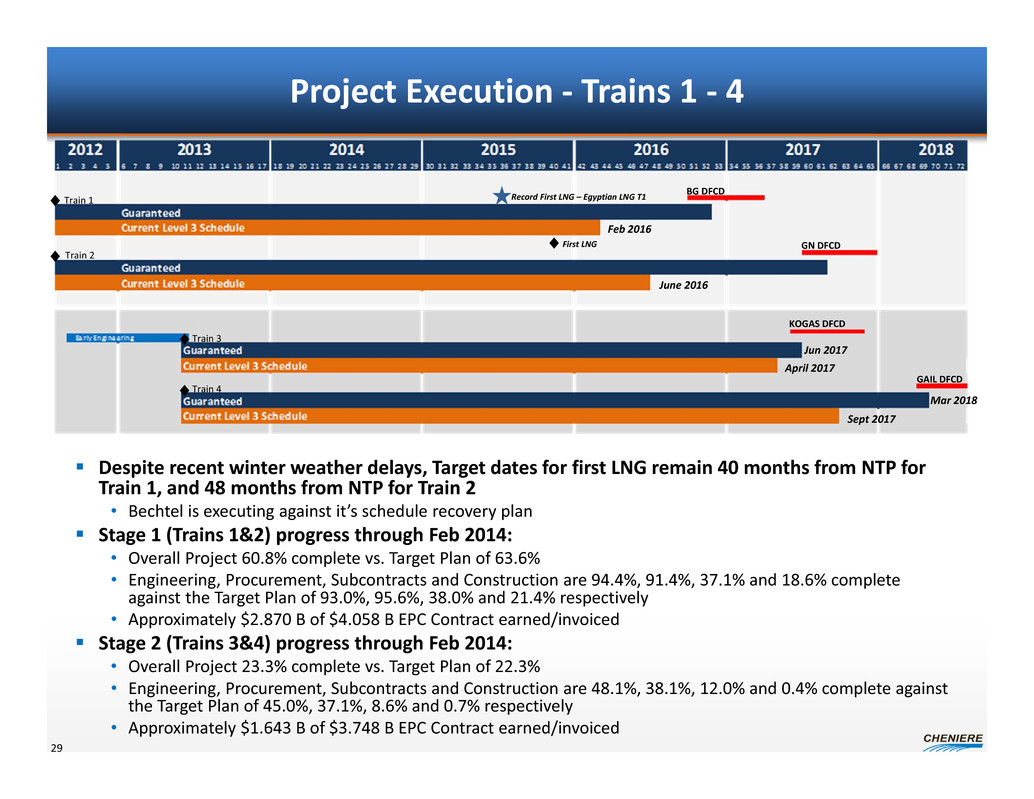

Project Execution ‐ Trains 1 ‐ 4    Despite recent winter weather delays, Target dates for first LNG remain 40 months from NTP for    Train 1, and 48 months from NTP for Train 2   • Bechtel is executing against it’s schedule recovery plan    Stage 1 (Trains 1&2) progress through Feb 2014:   • Overall Project 60.8% complete vs. Target Plan of 63.6%   • Engineering, Procurement, Subcontracts and Construction are 94.4%, 91.4%, 37.1% and 18.6% complete    against the Target Plan of 93.0%, 95.6%, 38.0% and 21.4% respectively   • Approximately $2.870 B of $4.058 B EPC Contract earned/invoiced     Stage 2 (Trains 3&4) progress through Feb 2014:   • Overall Project 23.3% complete vs. Target Plan of 22.3%   • Engineering, Procurement, Subcontracts and Construction are 48.1%, 38.1%, 12.0% and 0.4% complete against    the Target Plan of 45.0%, 37.1%, 8.6% and 0.7% respectively   • Approximately $1.643 B of $3.748 B EPC Contract earned/invoiced   29   BG DFCD   GN DFCD   KOGAS DFCD   GAIL DFCD   Record First LNG – Egyptian LNG T1   First LNG   Train 1   Train 2   Train 3   Train 4   Feb 2016   April 2017   Jun 2017   Mar 2018   June 2016   Sept 2017

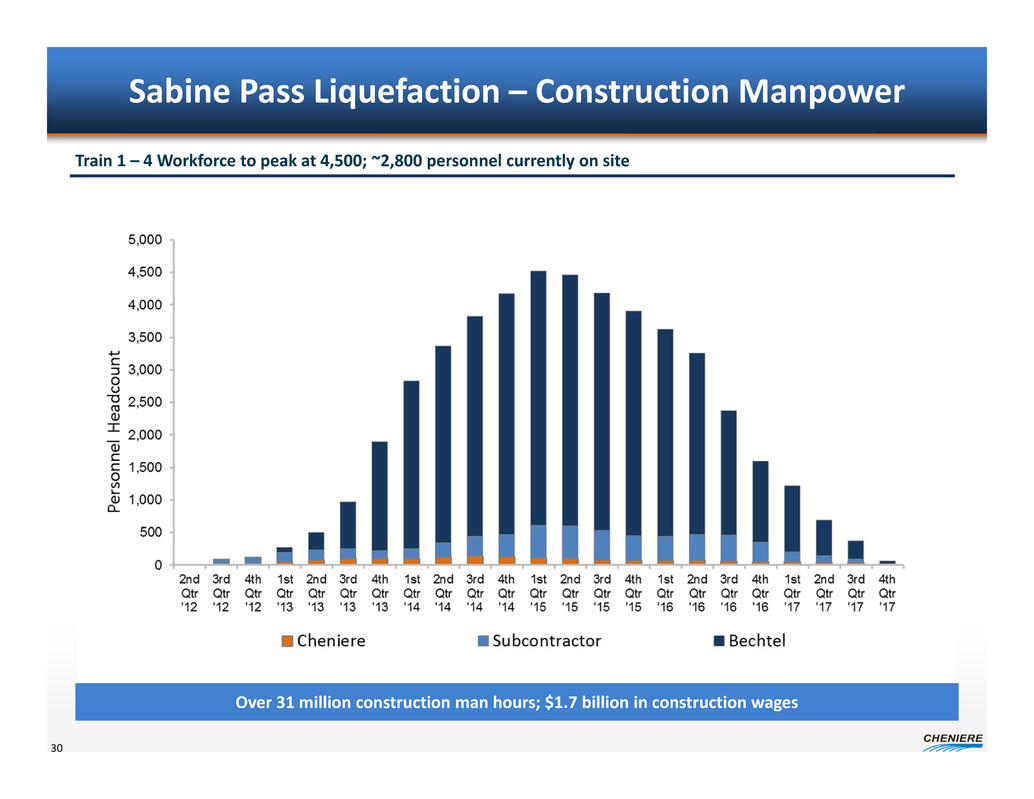

Sabine Pass Liquefaction – Construction Manpower   30   Over 31 million construction man hours; $1.7 billion in construction wages   Train 1 – 4 Workforce to peak at 4,500; ~2,800 personnel currently on site

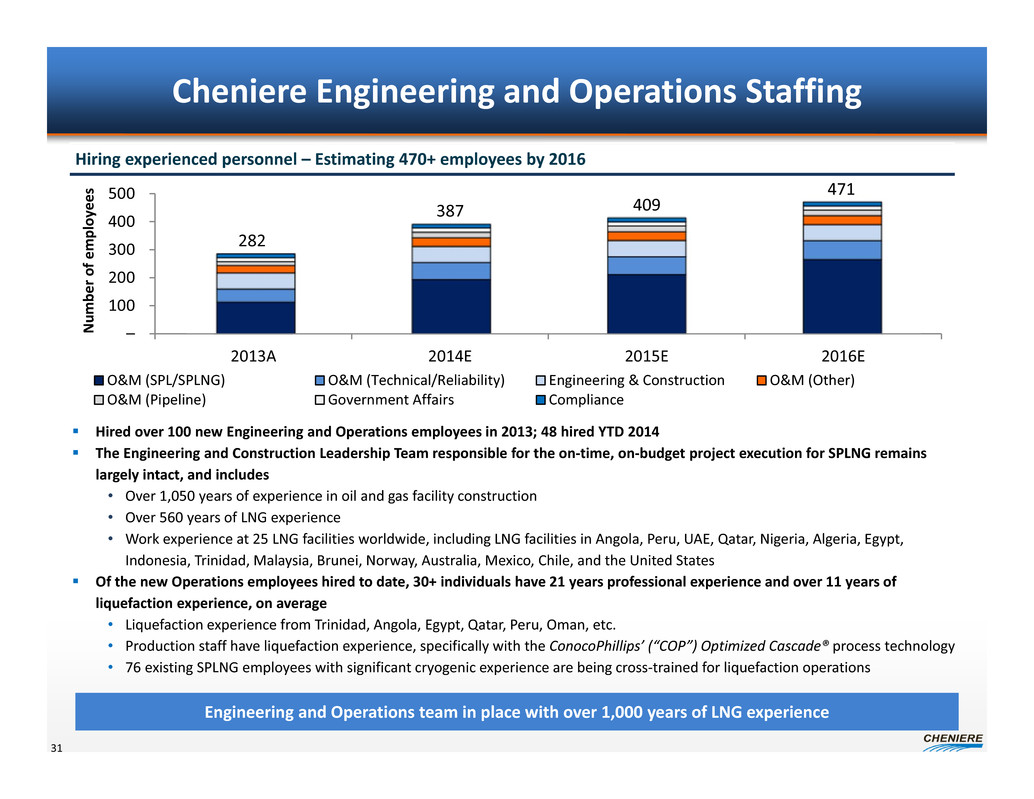

Cheniere Engineering and Operations Staffing   31    Hired over 100 new Engineering and Operations employees in 2013; 48 hired YTD 2014    The Engineering and Construction Leadership Team responsible for the on‐time, on‐budget project execution for SPLNG remains    largely intact, and includes   • Over 1,050 years of experience in oil and gas facility construction    • Over 560 years of LNG experience   • Work experience at 25 LNG facilities worldwide, including LNG facilities in Angola, Peru, UAE, Qatar, Nigeria, Algeria, Egypt,    Indonesia, Trinidad, Malaysia, Brunei, Norway, Australia, Mexico, Chile, and the United States    Of the new Operations employees hired to date, 30+ individuals have 21 years professional experience and over 11 years of    liquefaction experience, on average   • Liquefaction experience from Trinidad, Angola, Egypt, Qatar, Peru, Oman, etc.   • Production staff have liquefaction experience, specifically with the ConocoPhillips’ (“COP”) Optimized Cascade® process technology   • 76 existing SPLNG employees with significant cryogenic experience are being cross‐trained for liquefaction operations   Engineering and Operations team in place with over 1,000 years of LNG experience   Hiring experienced personnel – Estimating 470+ employees by 2016   282    387  409    455    –   100   200   300   400   500   2013A 2014E 2015E 2016E   N   u   m   b   e   r       o   f       e   m   p   l   o   y   e   e   s   O&M (SPL/SPLNG) O&M (Technical/Reliability) Engineering & Construction O&M (Other)   O&M (Pipeline) Government Affairs Compliance   282   387 409   471

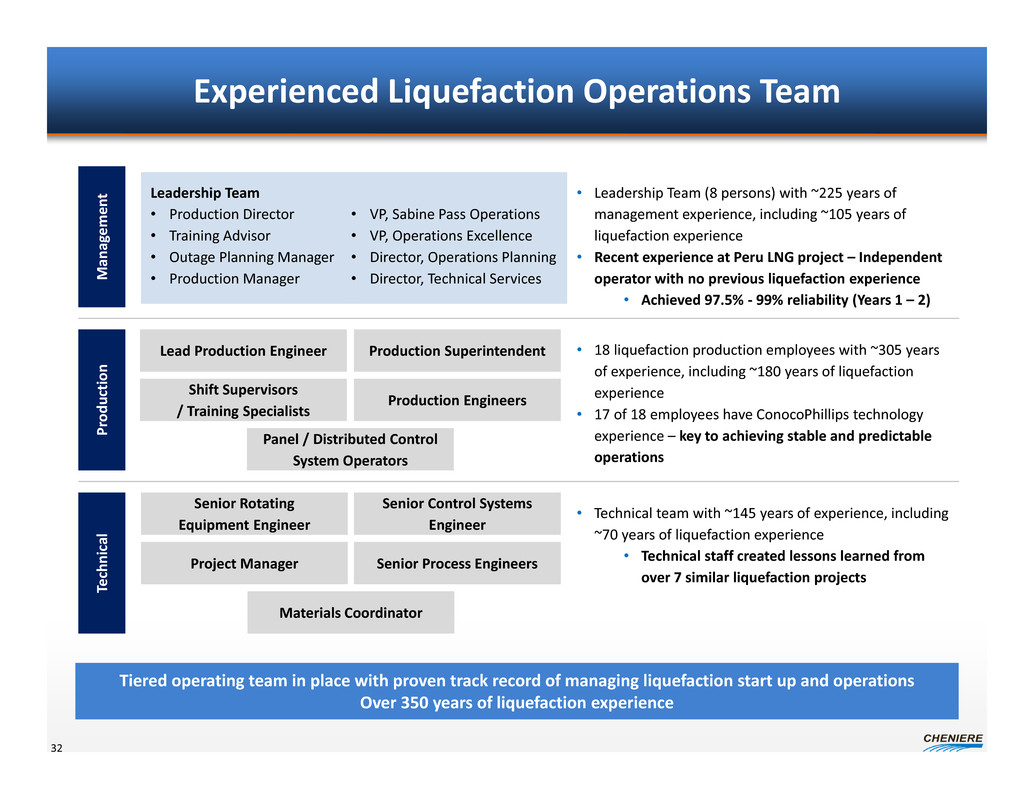

Experienced Liquefaction Operations Team   32   Tiered operating team in place with proven track record of managing liquefaction start up and operations   Over 350 years of liquefaction experience   M   a   n   a   g   e   m   e   n   t   P   r   o   d   u   c   t   i   o   n   T   e   c   h   n   i   c   a   l   Leadership Team   • Production Director   • Training Advisor   • Outage Planning Manager   • Production Manager   • VP, Sabine Pass Operations   • VP, Operations Excellence   • Director, Operations Planning   • Director, Technical Services   • Leadership Team (8 persons) with ~225 years of    management experience, including ~105 years of    liquefaction experience   • Recent experience at Peru LNG project – Independent     operator with no previous liquefaction experience   • Achieved 97.5% ‐ 99% reliability (Years 1 – 2)   Lead Production Engineer   Shift Supervisors   / Training Specialists   Panel / Distributed Control    System Operators   Production Superintendent   Production Engineers   Senior Rotating    Equipment Engineer   Project Manager   Materials Coordinator   Senior Control Systems    Engineer   Senior Process Engineers   • 18 liquefaction production employees with ~305 years    of experience, including ~180 years of liquefaction    experience   • 17 of 18 employees have ConocoPhillips technology    experience – key to achieving stable and predictable    operations   • Technical team with ~145 years of experience, including    ~70 years of liquefaction experience   • Technical staff created lessons learned from    over 7 similar liquefaction projects

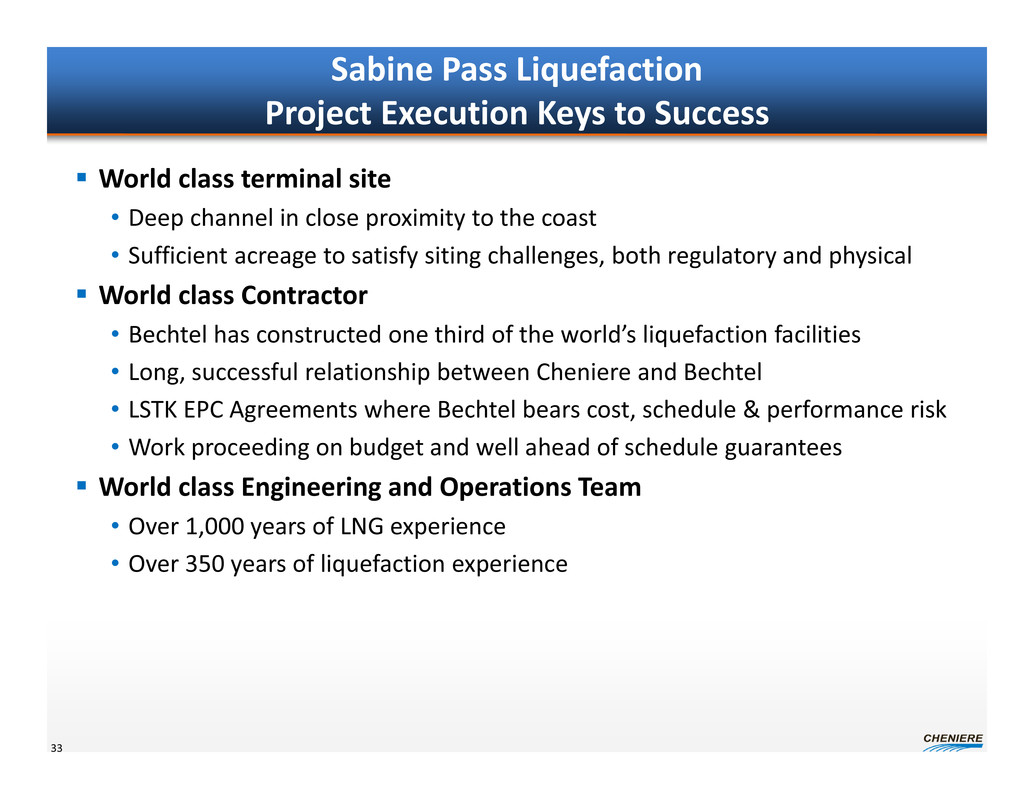

Sabine Pass Liquefaction     Project Execution Keys to Success    World class terminal site   • Deep channel in close proximity to the coast   • Sufficient acreage to satisfy siting challenges, both regulatory and physical     World class Contractor   • Bechtel has constructed one third of the world’s liquefaction facilities   • Long, successful relationship between Cheniere and Bechtel   • LSTK EPC Agreements where Bechtel bears cost, schedule & performance risk   • Work proceeding on budget and well ahead of schedule guarantees    World class Engineering and Operations Team   • Over 1,000 years of LNG experience   • Over 350 years of liquefaction experience   33

Katie Pipkin, SVP ‐ Business Development & Corporate Communications   April 2014   Growth Projects – Corpus Christi and Sabine Pass T5‐6   Analyst / Investor Day

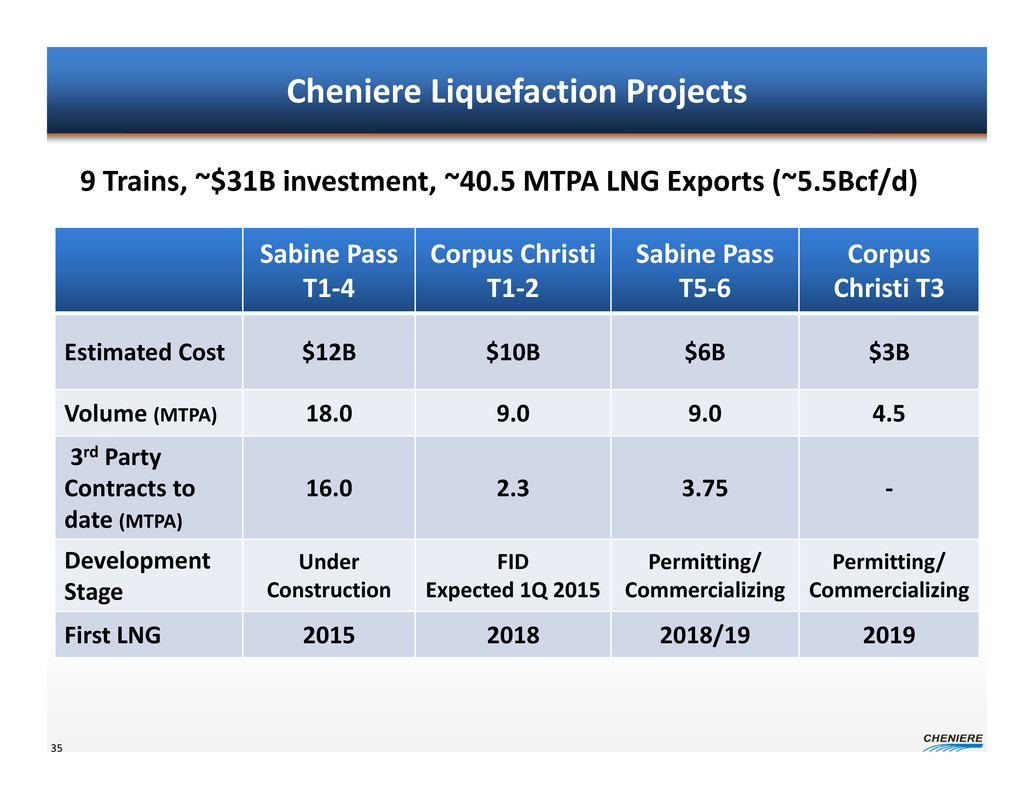

Cheniere Liquefaction Projects   35   Sabine Pass    T1‐4   Corpus Christi    T1‐2   Sabine Pass    T5‐6   Corpus    Christi T3   Estimated Cost $12B $10B $6B $3B   Volume (MTPA) 18.0 9.0 9.0 4.5   3rd Party    Contracts to    date (MTPA)   16.0 2.3 3.75 ‐   Development    Stage   Under    Construction   FID   Expected 1Q 2015   Permitting/    Commercializing   Permitting/    Commercializing   First LNG 2015 2018 2018/19 2019   9 Trains, ~$31B investment, ~40.5 MTPA LNG Exports (~5.5Bcf/d)

Source: Office of Oil and Gas Global Security and Supply, Office of Fossil Energy, U.S. Department of Energy;    U.S. Federal Energy Regulatory Commission; Company releases   U.S. LNG Export Projects   Dominion Cove Point    Under Construction   Company   Quantity   (Bcf/d)   DOE FERC* Contracts   Cheniere Sabine    Pass T1 – T4   2.2 Fully permitted   Fully    Subscribed   Freeport 1.8    FTA +    NonFTA  T1‐T3   Lake Charles 2.0   FTA +    NonFTA    Dominion Cove    Point    1.0   FTA +   NonFTA    Fully    Subscribed   Cameron LNG 1.7   FTA +    NonFTA  Fully Subscribed   Jordan Cove 1.2/0.8   FTA +    NonFTA      Oregon LNG 1.25 FTA    Cheniere Corpus    Christi   2.1 FTA  Partially    Subscribed   Cheniere Sabine    Pass T5 – T6   1.3 FTA    T5   Subscribed   Excelerate 1.3 FTA    Southern LNG 0.5 FTA    Freeport LNG    Corpus Christi   Plus  other proposed LNG export projects that have not filed a FERC    application.   • Application filing =    • FERC scheduling notice issued =    Filed FERC Application   Proposed Projects   Jordan Cove   Oregon LNG   Cameron LNG   Lake Charles   Sabine Pass   36   Southern LNG

Technical Considerations for Liquefaction Projects    LNG projects are physically difficult   • This will become apparent only through the FERC process   • Sites of limited size or near dense populations   • Possible, but expensive & delays    Must have sufficient land for complex infrastructure and lay‐down areas   • Without land, significant costs and 1‐2 years of delay    Must have long time horizon   • Minimum 24 months required to design an LNG project   • ~48 months required for construction following FID   • ~9 months per LNG train    Consider EPC builder as a partner, rather than focus on price from    competing contractors   37

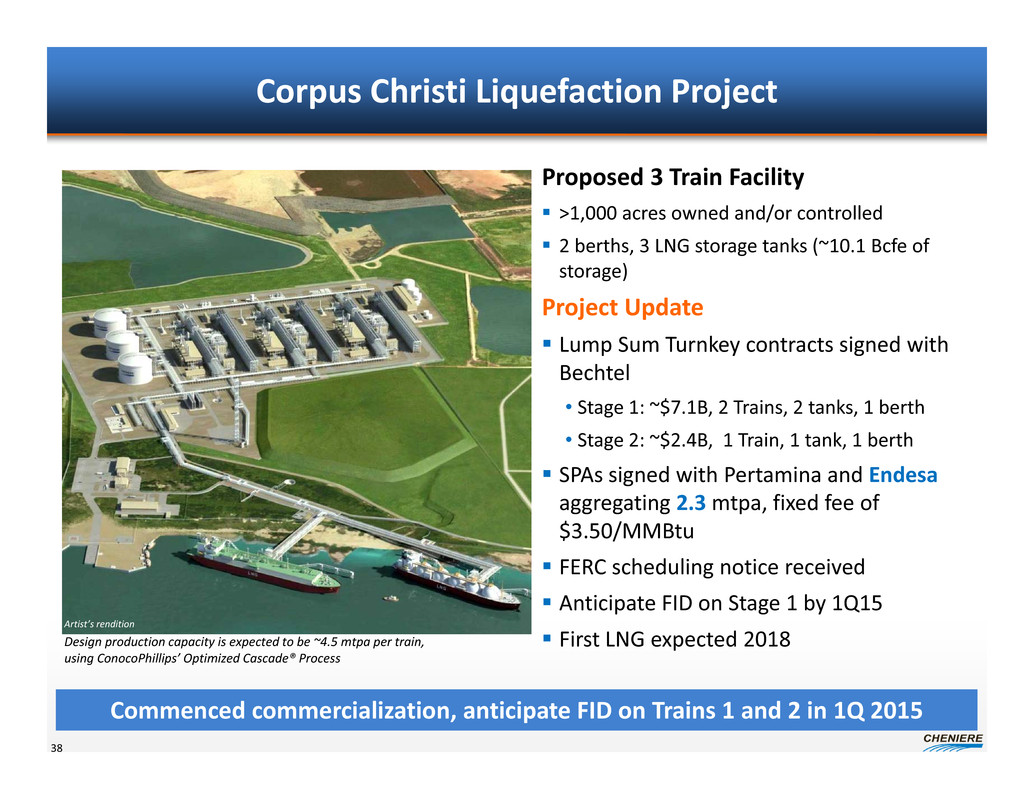

Corpus Christi Liquefaction Project   38   Proposed 3 Train Facility    >1,000 acres owned and/or controlled    2 berths, 3 LNG storage tanks (~10.1 Bcfe of    storage)    Project Update    Lump Sum Turnkey contracts signed with    Bechtel   • Stage 1: ~$7.1B, 2 Trains, 2 tanks, 1 berth   • Stage 2: ~$2.4B,  1 Train, 1 tank, 1 berth    SPAs signed with Pertamina and Endesa   aggregating 2.3 mtpa, fixed fee of    $3.50/MMBtu    FERC scheduling notice received     Anticipate FID on Stage 1 by 1Q15    First LNG expected 2018   Commenced commercialization, anticipate FID on Trains 1 and 2 in 1Q 2015   Artist’s rendition   Design production capacity is expected to be ~4.5 mtpa per train,    using ConocoPhillips’ Optimized Cascade® Process

Aerial Map of Surrounding Area   39

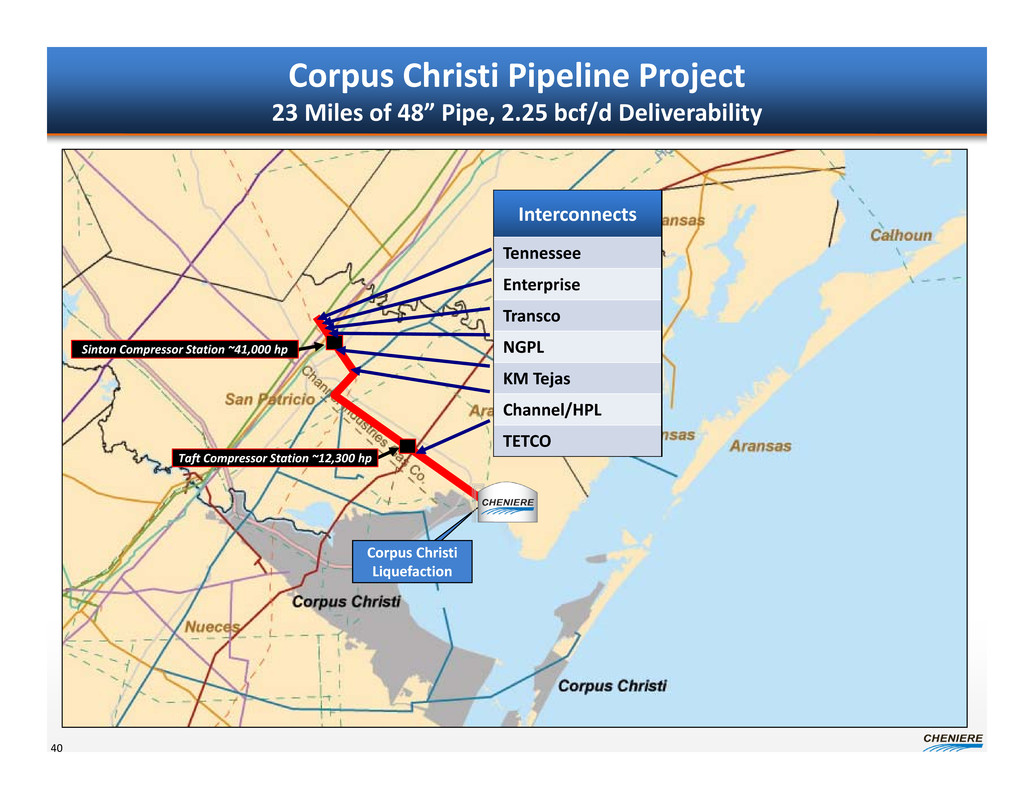

Corpus Christi Pipeline Project   23 Miles of 48” Pipe, 2.25 bcf/d Deliverability   40   Corpus Christi   Liquefaction   Interconnects   Tennessee   Enterprise   Transco   NGPL   KM Tejas   Channel/HPL   TETCO   Sinton Compressor Station ~41,000 hp   Taft Compressor Station ~12,300 hp

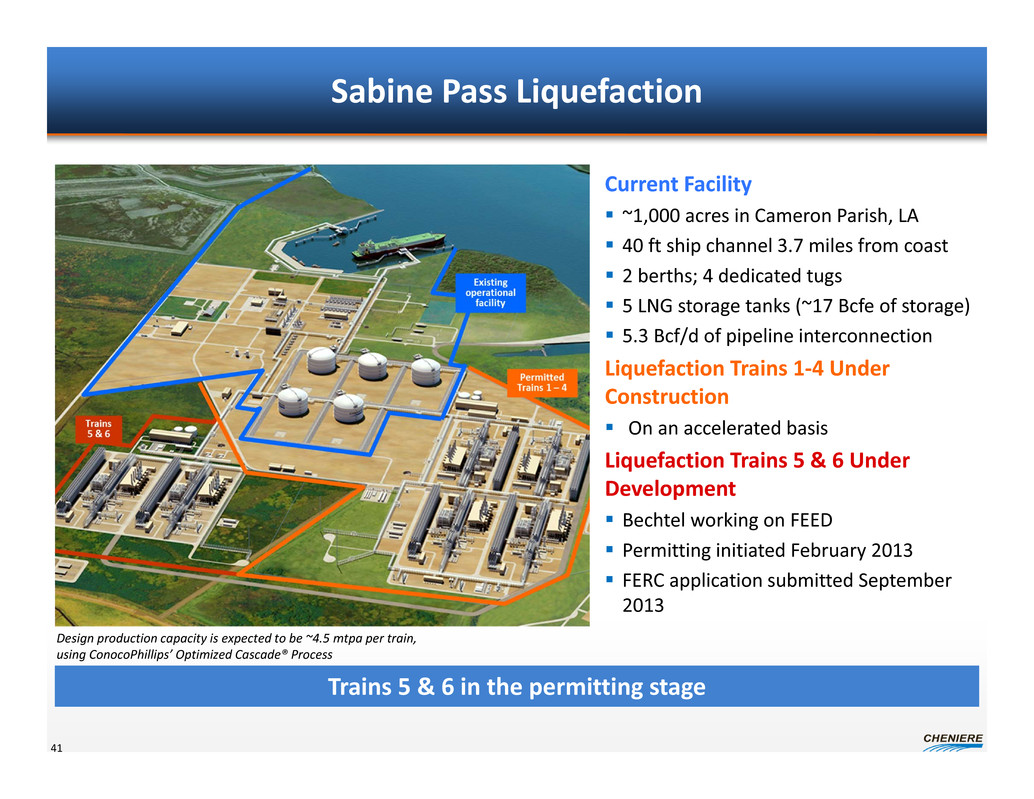

Sabine Pass Liquefaction   41   Trains 5 & 6 in the permitting stage   Design production capacity is expected to be ~4.5 mtpa per train,    using ConocoPhillips’ Optimized Cascade® Process   Current Facility    ~1,000 acres in Cameron Parish, LA     40 ft ship channel 3.7 miles from coast     2 berths; 4 dedicated tugs    5 LNG storage tanks (~17 Bcfe of storage)     5.3 Bcf/d of pipeline interconnection   Liquefaction Trains 1‐4 Under    Construction    On an accelerated basis   Liquefaction Trains 5 & 6 Under    Development    Bechtel working on FEED    Permitting initiated February 2013    FERC application submitted September    2013

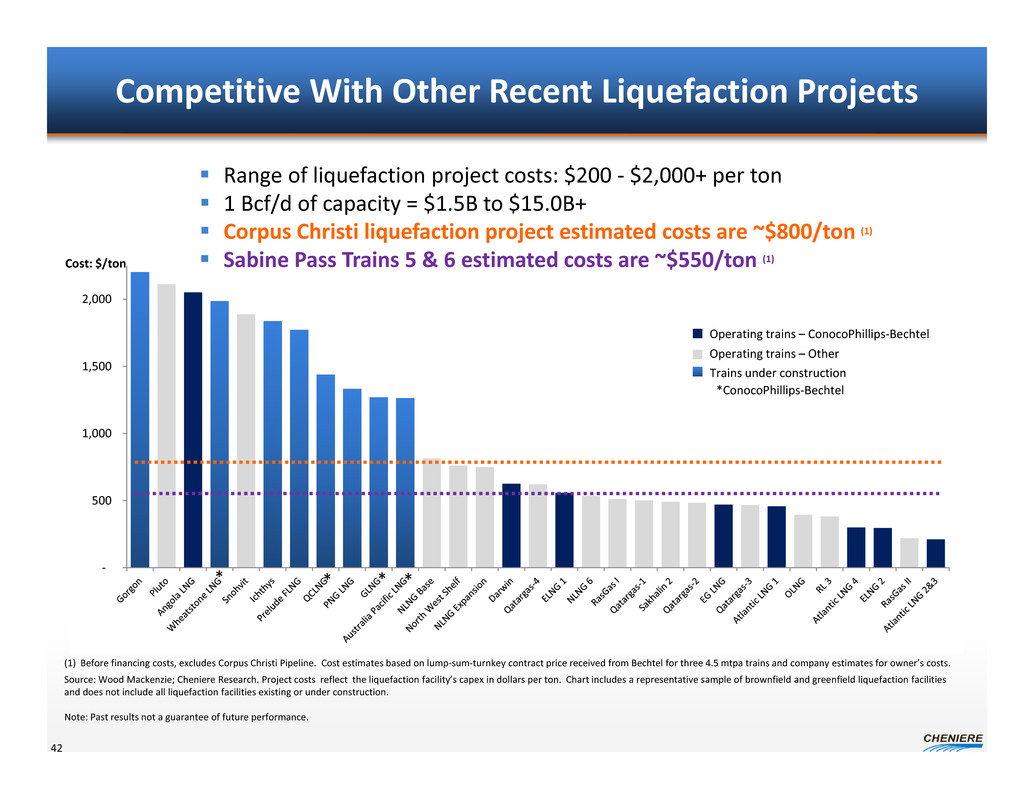

Competitive With Other Recent Liquefaction Projects   42    ‐    500    1,000    1,500    2,000   * * * *    Range of liquefaction project costs: $200 ‐ $2,000+ per ton    1 Bcf/d of capacity = $1.5B to $15.0B+    Corpus Christi liquefaction project estimated costs are ~$800/ton (1)    Sabine Pass Trains 5 & 6 estimated costs are ~$550/ton (1)   (1)  Before financing costs, excludes Corpus Christi Pipeline.  Cost estimates based on lump‐sum‐turnkey contract price received from Bechtel for three 4.5 mtpa trains and company estimates for owner’s costs.   Source: Wood Mackenzie; Cheniere Research. Project costs  reflect  the liquefaction facility’s capex in dollars per ton.  Chart includes a representative sample of brownfield and greenfield liquefaction facilities    and does not include all liquefaction facilities existing or under construction.   Note: Past results not a guarantee of future performance.   *ConocoPhillips‐Bechtel   Cost: $/ton   Trains under construction   Operating trains – ConocoPhillips‐Bechtel   Operating trains – Other

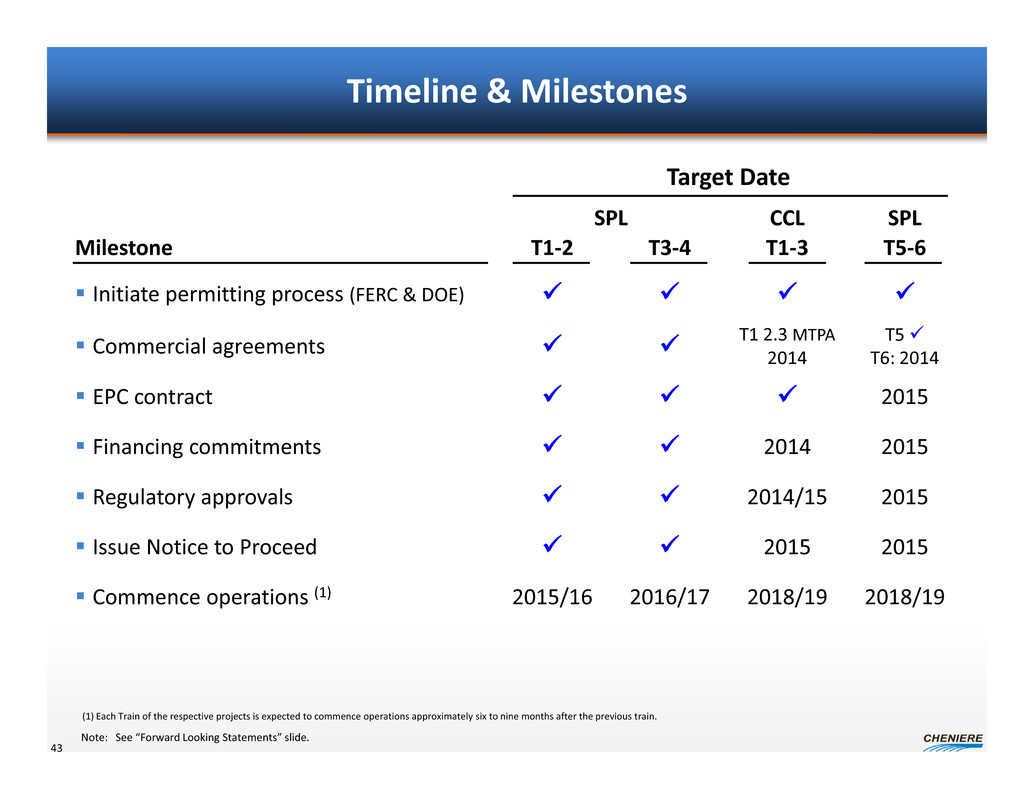

Timeline & Milestones   Target Date   SPL CCL SPL   Milestone T1‐2 T3‐4 T1‐3 T5‐6    Initiate permitting process (FERC & DOE)        Commercial agreements   T1 2.3 MTPA2014 T5T6: 2014    EPC contract    2015    Financing commitments   2014 2015    Regulatory approvals   2014/15 2015    Issue Notice to Proceed   2015 2015    Commence operations (1) 2015/16 2016/17 2018/19 2018/19   43   (1) Each Train of the respective projects is expected to commence operations approximately six to nine months after the previous train.   Note:  See “Forward Looking Statements” slide.

Pat Outtrim, Vice President Government and Regulatory Affairs   April 2014   Regulatory Review   Analyst / Investor Day

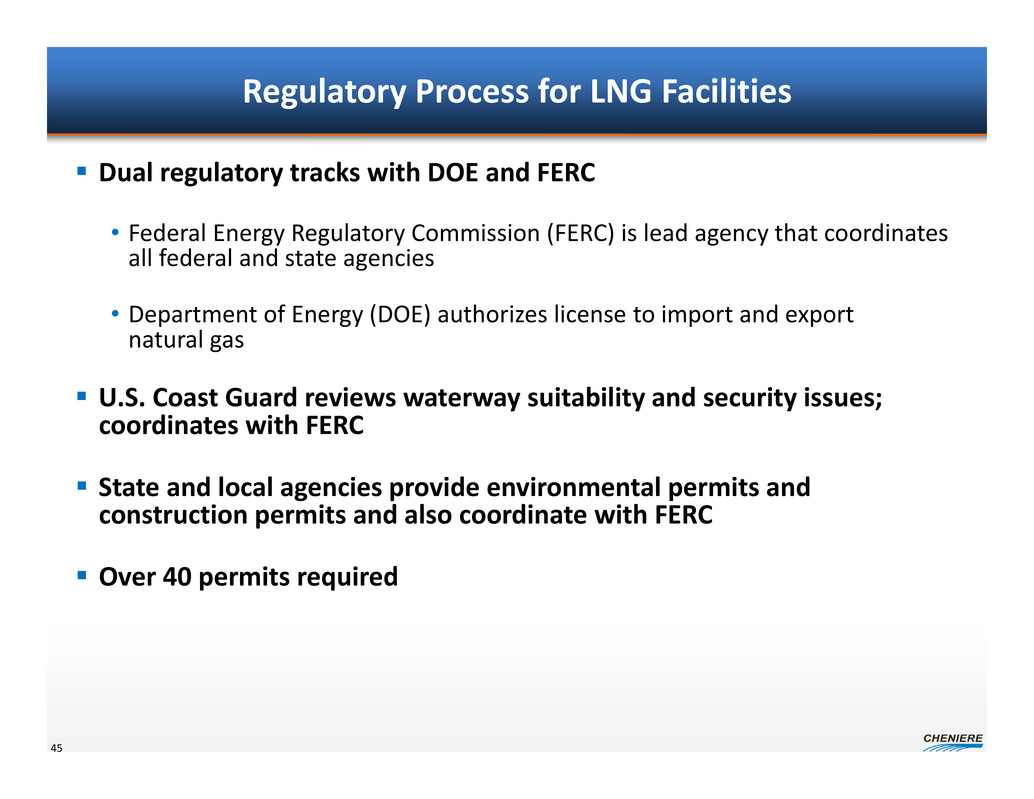

Regulatory Process for LNG Facilities    Dual regulatory tracks with DOE and FERC   • Federal Energy Regulatory Commission (FERC) is lead agency that coordinates    all federal and state agencies   • Department of Energy (DOE) authorizes license to import and export    natural gas     U.S. Coast Guard reviews waterway suitability and security issues;    coordinates with FERC    State and local agencies provide environmental permits and    construction permits and also coordinate with FERC    Over 40 permits required   45

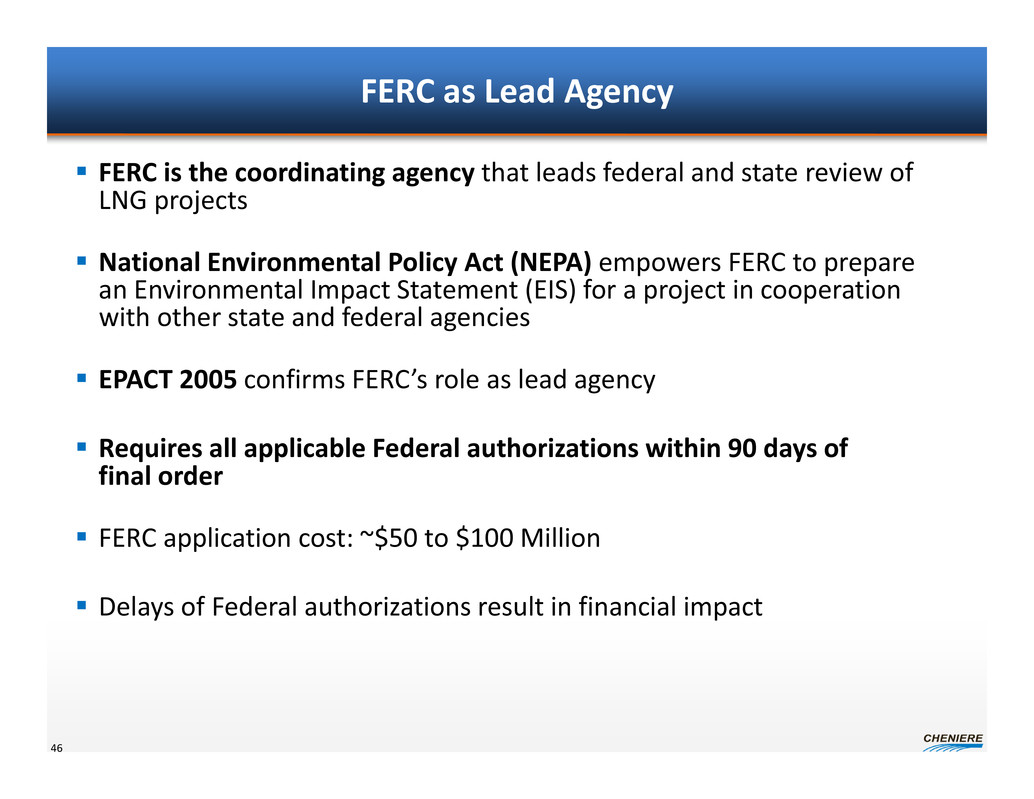

FERC as Lead Agency    FERC is the coordinating agency that leads federal and state review of    LNG projects    National Environmental Policy Act (NEPA) empowers FERC to prepare    an Environmental Impact Statement (EIS) for a project in cooperation    with other state and federal agencies     EPACT 2005 confirms FERC’s role as lead agency     Requires all applicable Federal authorizations within 90 days of    final order    FERC application cost: ~$50 to $100 Million    Delays of Federal authorizations result in financial impact   46

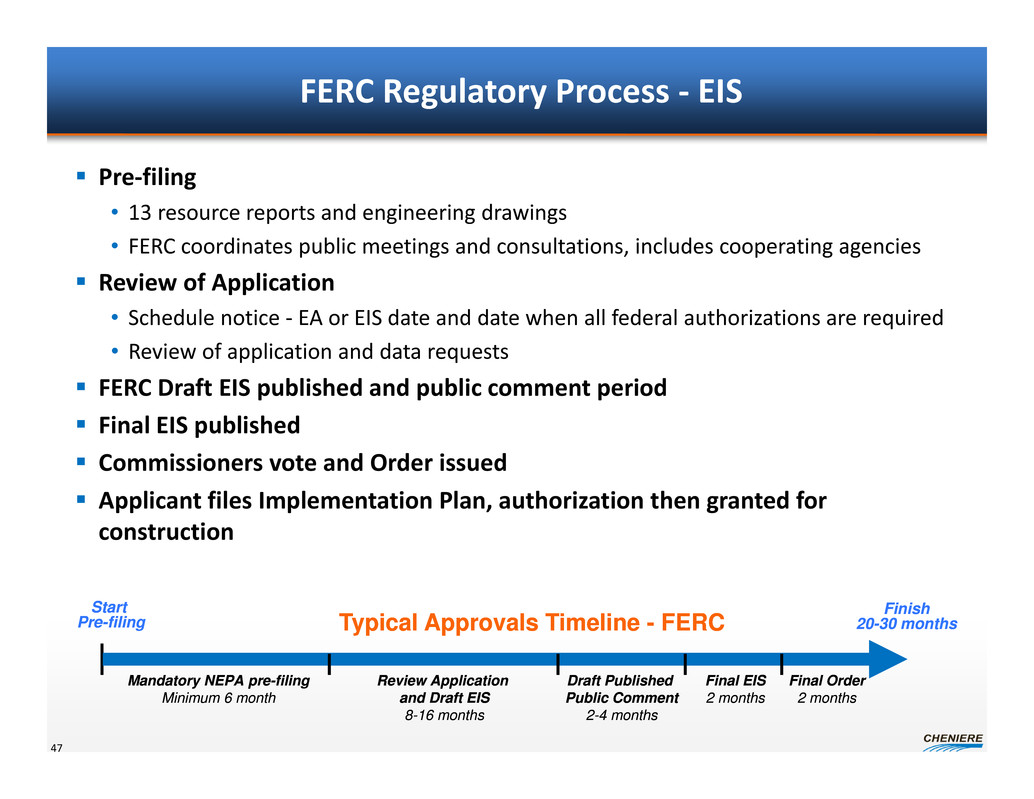

FERC Regulatory Process ‐ EIS    Pre‐filing   • 13 resource reports and engineering drawings    • FERC coordinates public meetings and consultations, includes cooperating agencies    Review of Application   • Schedule notice ‐ EA or EIS date and date when all federal authorizations are required   • Review of application and data requests    FERC Draft EIS published and public comment period    Final EIS published    Commissioners vote and Order issued    Applicant files Implementation Plan, authorization then granted for    construction   47   Start   Pre-filing   Finish   20-30 monthsTypical Approvals Timeline - FERC   Mandatory NEPA pre-filing   Minimum 6 month   Review Application   and Draft EIS   8-16 months   Draft Published   Public Comment   2-4 months   Final EIS   2 months   Final Order   2 months

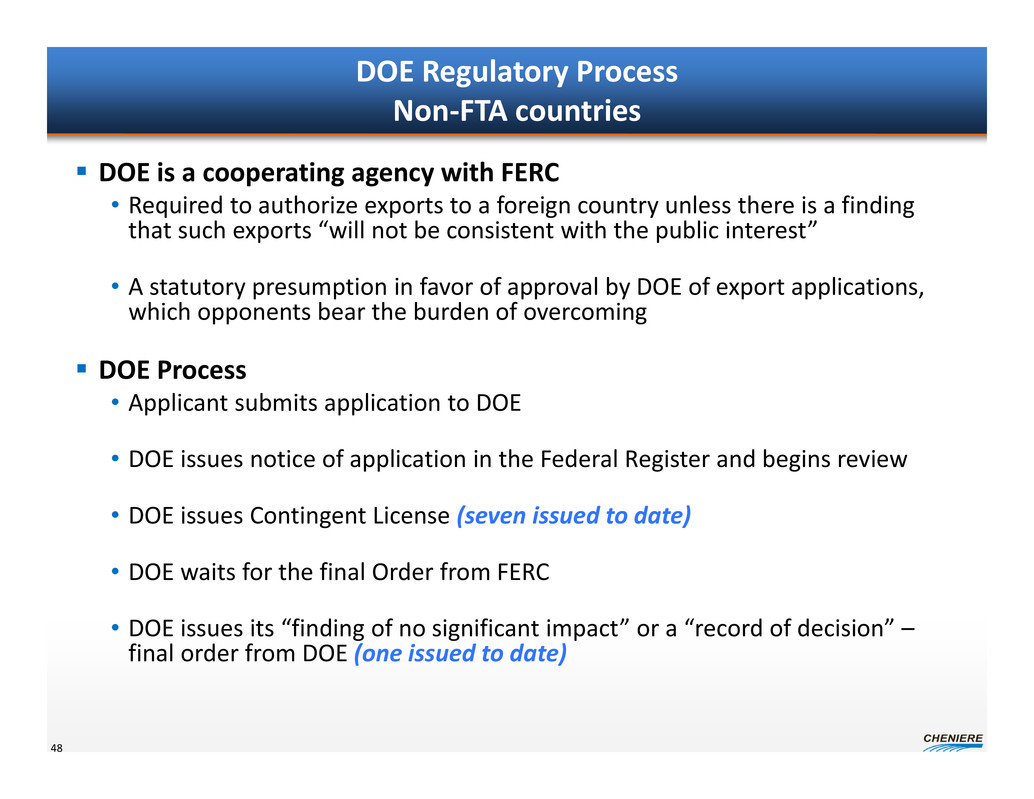

DOE Regulatory Process   Non‐FTA countries    DOE is a cooperating agency with FERC   • Required to authorize exports to a foreign country unless there is a finding    that such exports “will not be consistent with the public interest”    • A statutory presumption in favor of approval by DOE of export applications,    which opponents bear the burden of overcoming     DOE Process   • Applicant submits application to DOE    • DOE issues notice of application in the Federal Register and begins review   • DOE issues Contingent License (seven issued to date)   • DOE waits for the final Order from FERC    • DOE issues its “finding of no significant impact” or a “record of decision” –   final order from DOE (one issued to date)   48

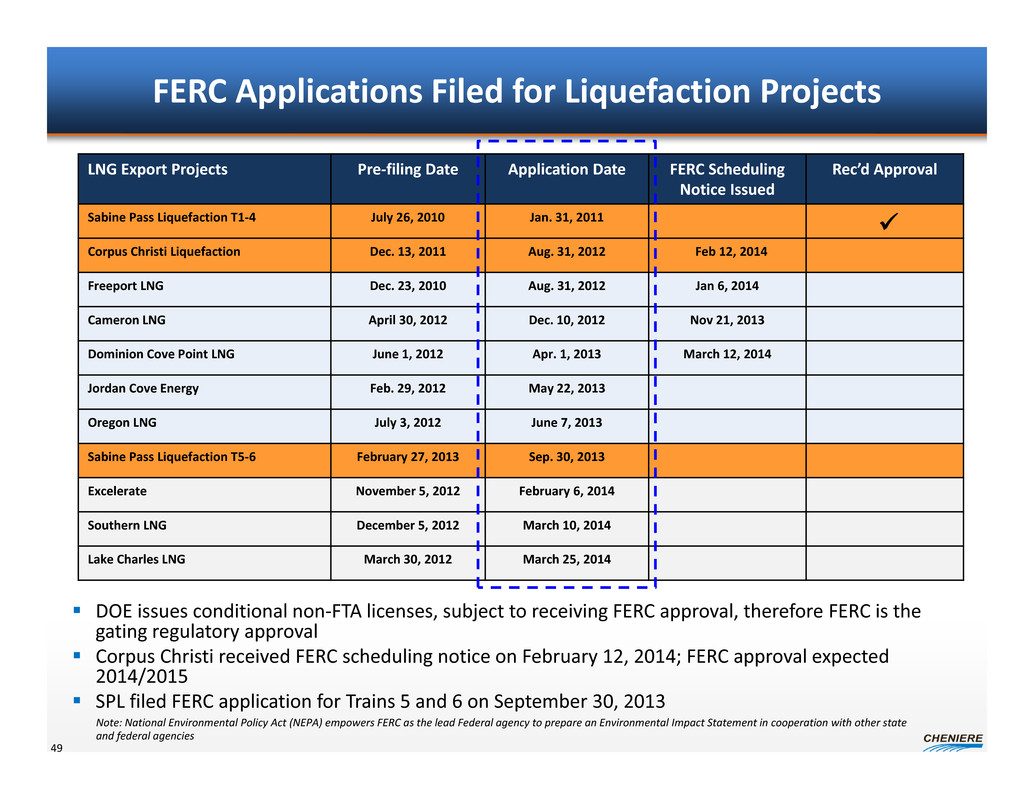

FERC Applications Filed for Liquefaction Projects    DOE issues conditional non‐FTA licenses, subject to receiving FERC approval, therefore FERC is the    gating regulatory approval    Corpus Christi received FERC scheduling notice on February 12, 2014; FERC approval expected    2014/2015    SPL filed FERC application for Trains 5 and 6 on September 30, 2013   49   LNG Export Projects   Pre‐filing Date   Application Date   FERC Scheduling    Notice Issued    Rec’d Approval   Sabine Pass Liquefaction T1‐4 July 26, 2010 Jan. 31, 2011   Corpus Christi Liquefaction Dec. 13, 2011 Aug. 31, 2012 Feb 12, 2014   Freeport LNG Dec. 23, 2010 Aug. 31, 2012 Jan 6, 2014   Cameron LNG April 30, 2012 Dec. 10, 2012 Nov 21, 2013   Dominion Cove Point LNG June 1, 2012 Apr. 1, 2013 March 12, 2014   Jordan Cove Energy Feb. 29, 2012 May 22, 2013   Oregon LNG July 3, 2012 June 7, 2013   Sabine Pass Liquefaction T5‐6 February 27, 2013 Sep. 30, 2013   Excelerate November 5, 2012 February 6, 2014   Southern LNG December 5, 2012 March 10, 2014   Lake Charles LNG March 30, 2012 March 25, 2014      Note: National Environmental Policy Act (NEPA) empowers FERC as the lead Federal agency to prepare an Environmental Impact Statement in cooperation with other state    and federal agencies

U.S. DOE Applications for LNG Exports*   50 Source: Office of Fossil Energy, U.S. Department of Energy; U.S. Federal Energy Regulatory Commission; Company releases   ** Application filed = ,  FERC scheduling notice issued =    * As of March 31, 2014.  Note additional companies have filed for their DOE license; however, not all have initiated their FERC filing process.   (1) “Order of Precedence”   (2) Orders are conditional on applicant completing the environmental review process as part of the FERC licensing process, and other conditions such as submitting all relevant long‐term commercial agreements.   (3) Application was filed for 1.4 Bcf/d; 0.4 Bcf/d was approved   Expected Order to    be Processed (1)2 Company   Date Applicant Received    FERC Approval to Begin    Pre‐Filing Process Quantity (Bcf/d)   Date Non FTA Received   FERC** ContractsConditional (2) Final   Cheniere Sabine Pass T1‐T4 8/4/2010 2.8 5/20/2011 8/7/2012  Fully Subscribed   Freeport LNG Expansion, L.P. and FLNG Liquefaction 1/5/2011 1.4 5/17/2013  Fully Subscribed   Lake Charles Exports, LLC 4/6/2012 2 8/7/2013    Dominion Cove Point LNG, LP 6/26/2012 1 9/11/2013  Fully Subscribed   Freeport LNG Expansion, L.P. and FLNG Liquefaction 1/5/2011 0.4(3) 11/15/2013  Fully Subscribed   Cameron LNG, LLC 5/9/2012 1.7 2/11/2014  Fully Subscribed   Jordan Cove Energy Project, L.P. 3/6/2012 1.2/0.8 3/24/2014    1 LNG Development Company, LLC (d/b/a Oregon LNG) 7/16/2012 1.25    2 Cheniere Marketing, LLC (Corpus Christi) 12/22/2011 2.1  T1 Partially Subscribed   3 Excelerate Liquefaction Solutions  11/20/2012 1.38    4 Carib Energy (USA) LLC 0.03/0.01   5 Gulf Coast LNG Export, LLC 2.8   6 Southern LNG Company, L.L.C. 3/1/2013 0.5    7 Gulf LNG Liquefaction Company, LLC 1.5   8 CE FLNG, LLC 4/16/2013 1.07   9 Golden Pass Products LLC 5/30/2013 2.6   10 Pangea LNG (North America) Holdings, LLC 1.09   11 Trunkline LNG Export, LLC 2   12 Freeport‐McMoRan Energy, LLC 3.22   13 Sabine Pass Liquefaction, LLC (T5 ‐ Total Contract) 3/8/2013 0.28  T5 Fully Subscribed   14 Sabine Pass Liquefaction, LLC (T5 ‐ Centrica Contract) 3/8/2013 0.24  T5 Fully Subscribed   15 Venture Global LNG, LLC 0.67   16 Eos LNG, LLC 1.6   17 Barca LNG, LLC 1.6   18 Sabine Pass Liquefaction, LLC (Remaining T5 Volumes and T6) 3/8/2013 0.86    19 Magnolia LNG, LLC 3/20/2013 1.08   20 Delfin LNG, LLC 1.8   21 Waller LNG Services, LLC 0.19   22 Gasfin Development 0.2   23 Texas LNG 0.27   24 Louisiana LNG  0.28

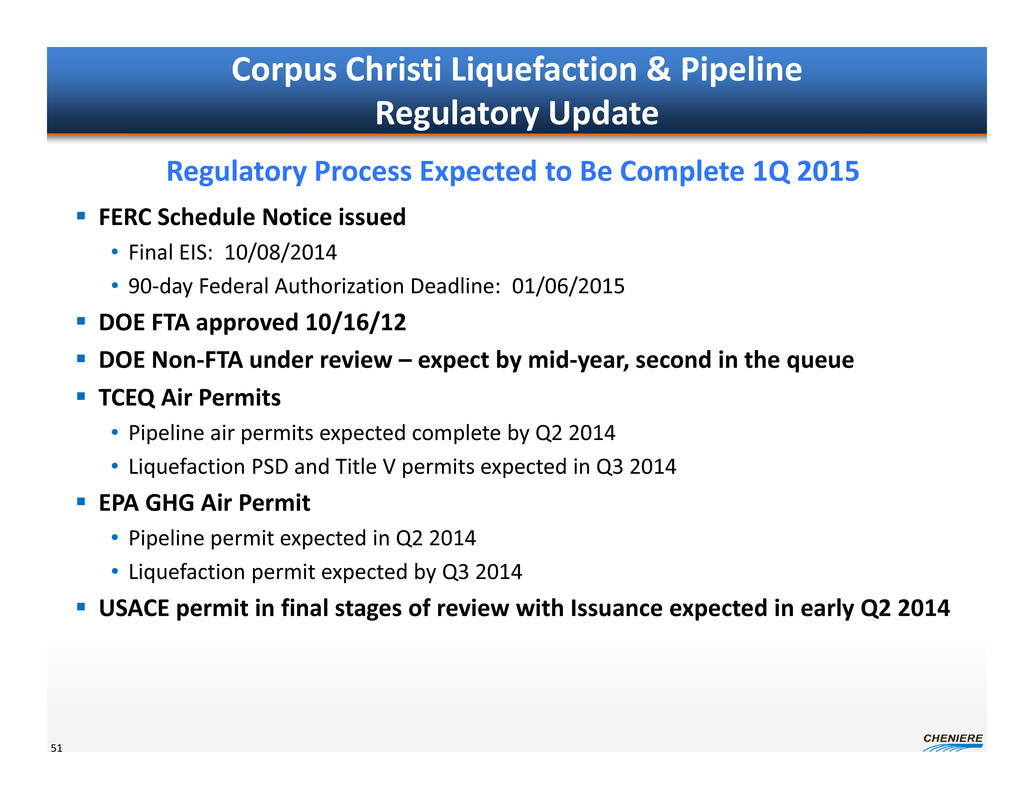

Corpus Christi Liquefaction & Pipeline   Regulatory Update    FERC Schedule Notice issued    • Final EIS:  10/08/2014   • 90‐day Federal Authorization Deadline:  01/06/2015    DOE FTA approved 10/16/12    DOE Non‐FTA under review – expect by mid‐year, second in the queue    TCEQ Air Permits   • Pipeline air permits expected complete by Q2 2014   • Liquefaction PSD and Title V permits expected in Q3 2014    EPA GHG Air Permit   • Pipeline permit expected in Q2 2014   • Liquefaction permit expected by Q3 2014    USACE permit in final stages of review with Issuance expected in early Q2 2014   51   Regulatory Process Expected to Be Complete 1Q 2015

Sabine Pass Liquefaction Trains 5&6   Regulatory Update    FERC application filed 9/30/2013   • Expect an EA   • All data requests received and answered    DOE   • FTA approved 07/12/13 and 01/22/14   • Non‐FTA:   – Train 5 is 13/14th in Queue   – Train 6 is 18th in Queue    Louisiana Department of Economic Quality (LADEQ) Air Permits   • Air permit filed on 09/20/2013, modeling filed 11/22/2013   • Expected by year‐end    United States Army Corps of Engineers (USACE)   • Loop 1 has been approved   • Loop 2 and expansions expected in Q3 2014   52   Regulatory Process Expected to Be Complete by 2015

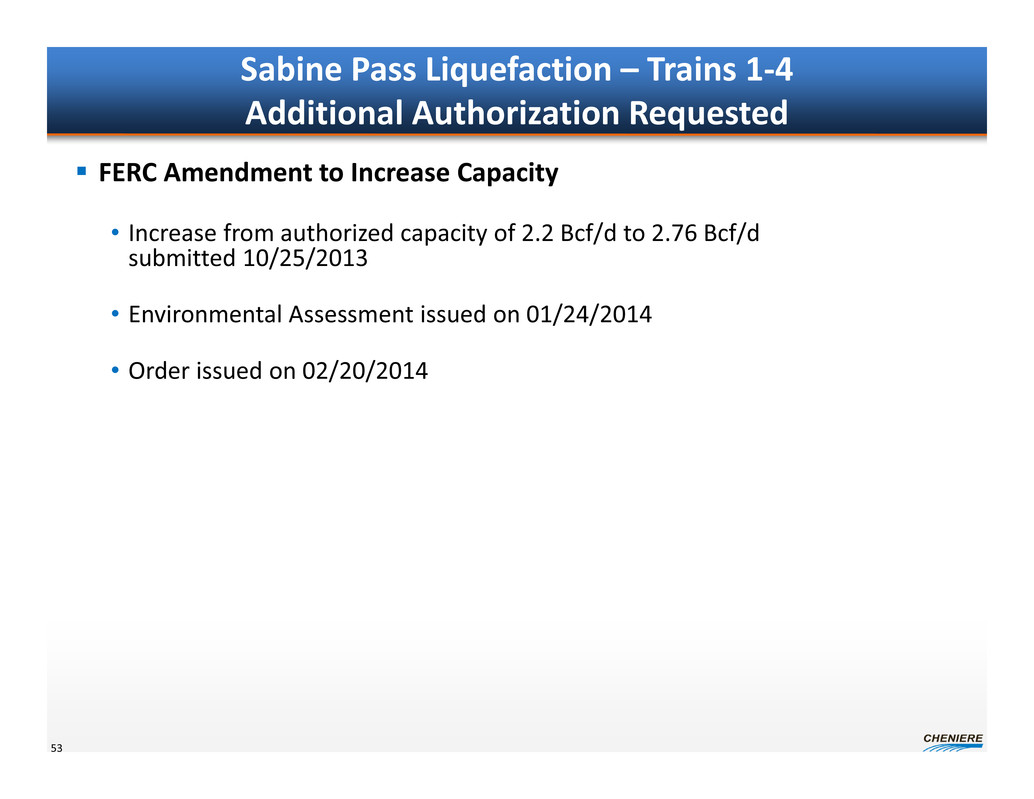

Sabine Pass Liquefaction – Trains 1‐4   Additional Authorization Requested    FERC Amendment to Increase Capacity   • Increase from authorized capacity of 2.2 Bcf/d to 2.76 Bcf/d    submitted 10/25/2013   • Environmental Assessment issued on 01/24/2014   • Order issued on 02/20/2014   53

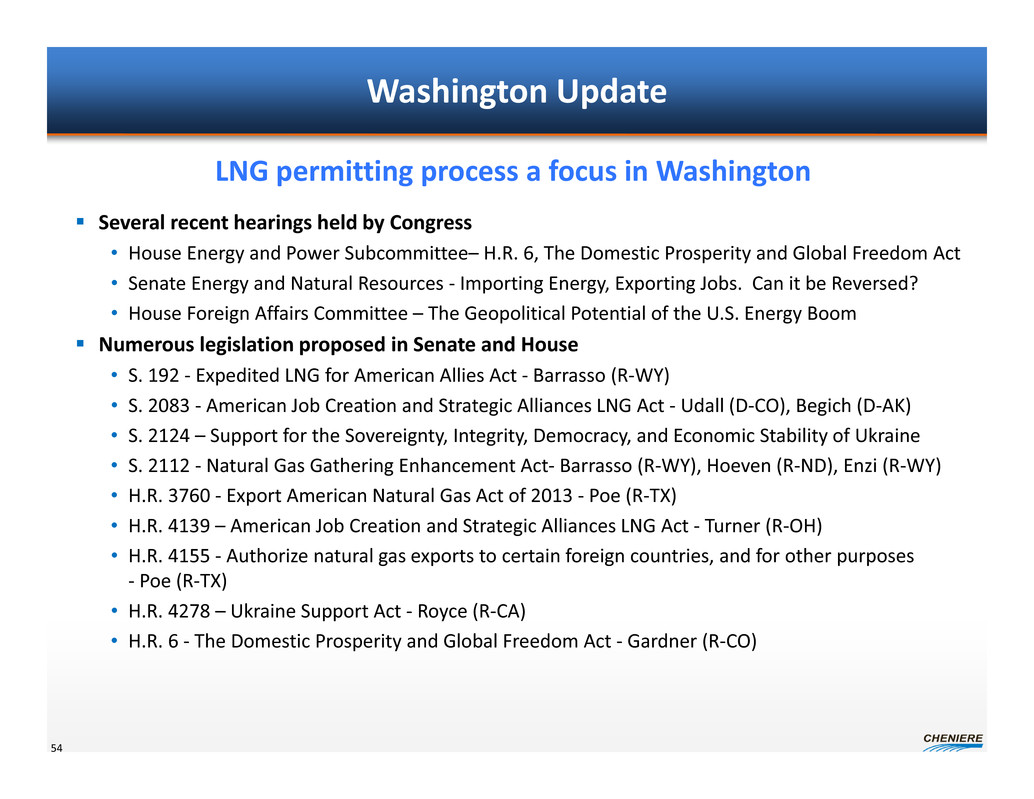

Washington Update    Several recent hearings held by Congress   • House Energy and Power Subcommittee– H.R. 6, The Domestic Prosperity and Global Freedom Act   • Senate Energy and Natural Resources ‐ Importing Energy, Exporting Jobs.  Can it be Reversed?   • House Foreign Affairs Committee – The Geopolitical Potential of the U.S. Energy Boom    Numerous legislation proposed in Senate and House   • S. 192 ‐ Expedited LNG for American Allies Act ‐ Barrasso (R‐WY)   • S. 2083 ‐ American Job Creation and Strategic Alliances LNG Act ‐ Udall (D‐CO), Begich (D‐AK)   • S. 2124 – Support for the Sovereignty, Integrity, Democracy, and Economic Stability of Ukraine    • S. 2112 ‐ Natural Gas Gathering Enhancement Act‐ Barrasso (R‐WY), Hoeven (R‐ND), Enzi (R‐WY)   • H.R. 3760 ‐ Export American Natural Gas Act of 2013 ‐ Poe (R‐TX)   • H.R. 4139 – American Job Creation and Strategic Alliances LNG Act ‐ Turner (R‐OH)   • H.R. 4155 ‐ Authorize natural gas exports to certain foreign countries, and for other purposes   ‐ Poe (R‐TX)   • H.R. 4278 – Ukraine Support Act ‐ Royce (R‐CA)   • H.R. 6 ‐ The Domestic Prosperity and Global Freedom Act ‐ Gardner (R‐CO)   54   LNG permitting process a focus in Washington

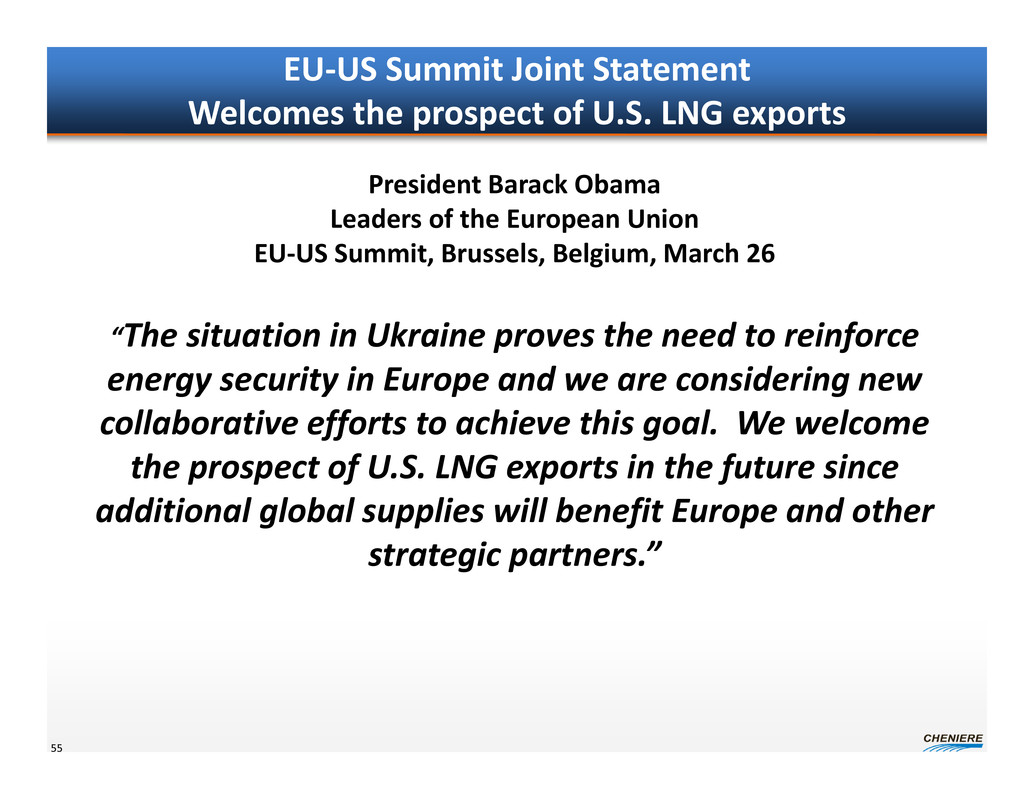

EU‐US Summit Joint Statement   Welcomes the prospect of U.S. LNG exports   55   President Barack Obama    Leaders of the European Union    EU‐US Summit, Brussels, Belgium, March 26   “The situation in Ukraine proves the need to reinforce    energy security in Europe and we are considering new    collaborative efforts to achieve this goal. We welcome    the prospect of U.S. LNG exports in the future since    additional global supplies will benefit Europe and other    strategic partners.”

Corey Grindal, Vice President, Supply   April 2014   Supply Procurement   Analyst / Investor Day

Gas Supply Procurement Plan for Liquefaction Projects    Gas procurement overview    U.S. pipeline infrastructure changes    Sabine Pass    Corpus Christi    Ongoing supply strategy    57   Natural gas will be procured by the terminals, liquefied and LNG sold based on    NYMEX settlement for the month of delivery

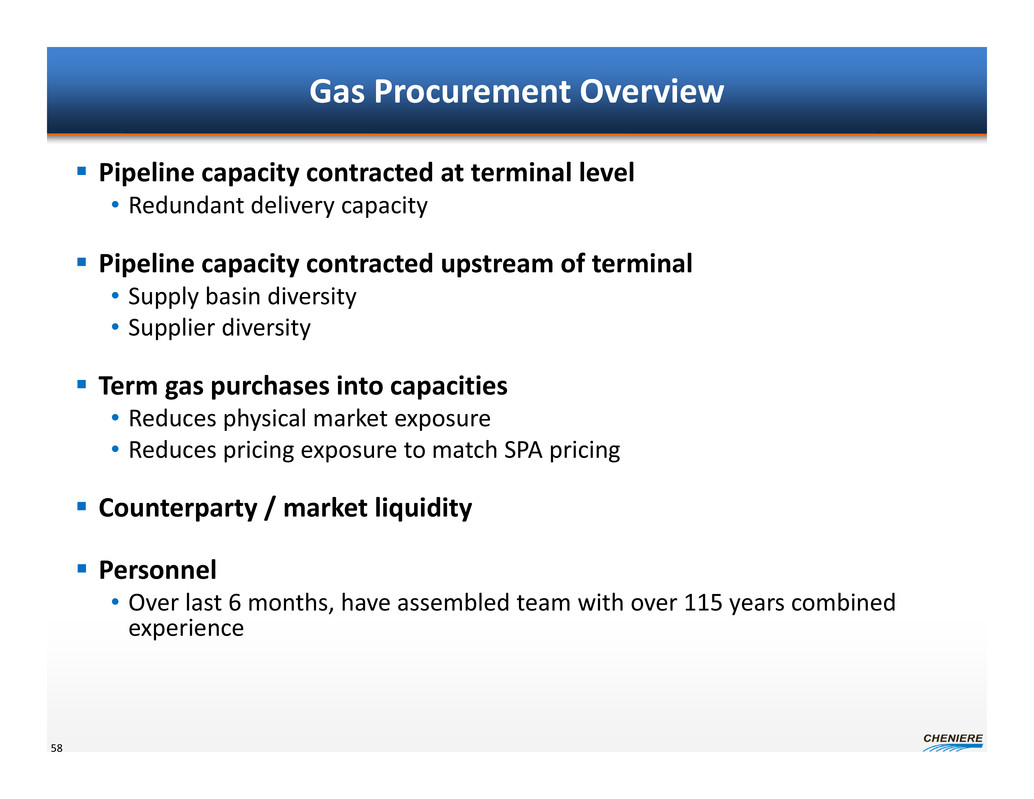

Gas Procurement Overview    Pipeline capacity contracted at terminal level   • Redundant delivery capacity    Pipeline capacity contracted upstream of terminal   • Supply basin diversity   • Supplier diversity    Term gas purchases into capacities   • Reduces physical market exposure   • Reduces pricing exposure to match SPA pricing    Counterparty / market liquidity    Personnel   • Over last 6 months, have assembled team with over 115 years combined    experience   58

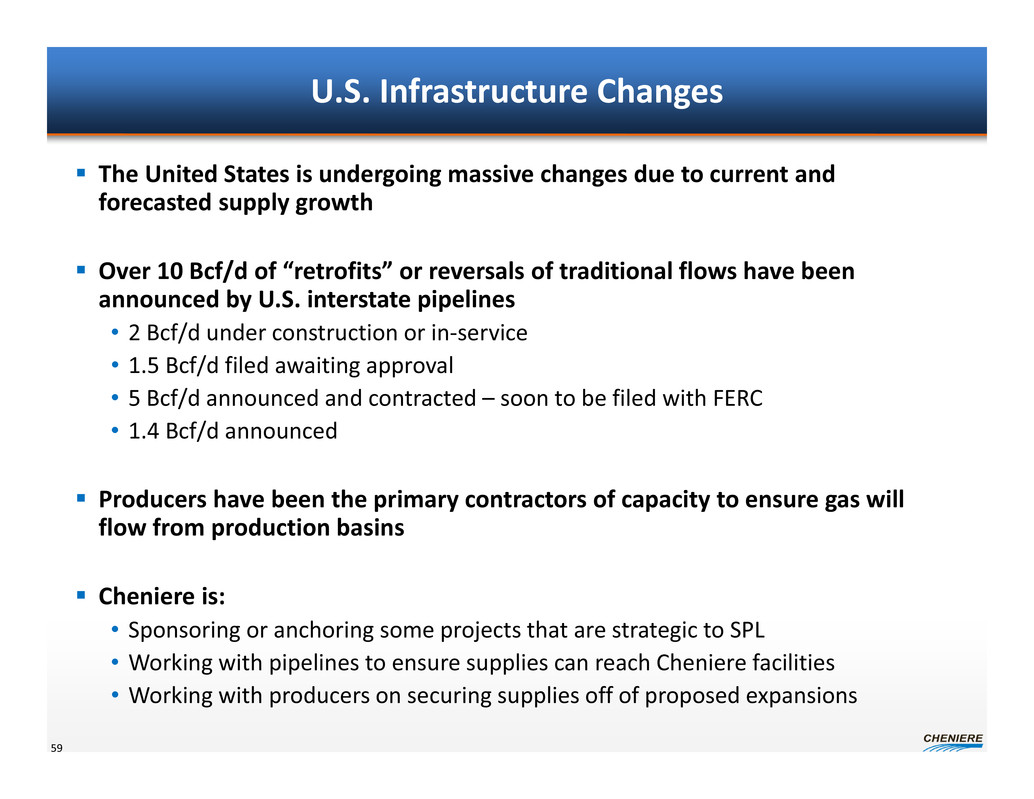

U.S. Infrastructure Changes    The United States is undergoing massive changes due to current and    forecasted supply growth    Over 10 Bcf/d of “retrofits” or reversals of traditional flows have been    announced by U.S. interstate pipelines   • 2 Bcf/d under construction or in‐service   • 1.5 Bcf/d filed awaiting approval   • 5 Bcf/d announced and contracted – soon to be filed with FERC   • 1.4 Bcf/d announced    Producers have been the primary contractors of capacity to ensure gas will    flow from production basins    Cheniere is:   • Sponsoring or anchoring some projects that are strategic to SPL   • Working with pipelines to ensure supplies can reach Cheniere facilities   • Working with producers on securing supplies off of proposed expansions   59

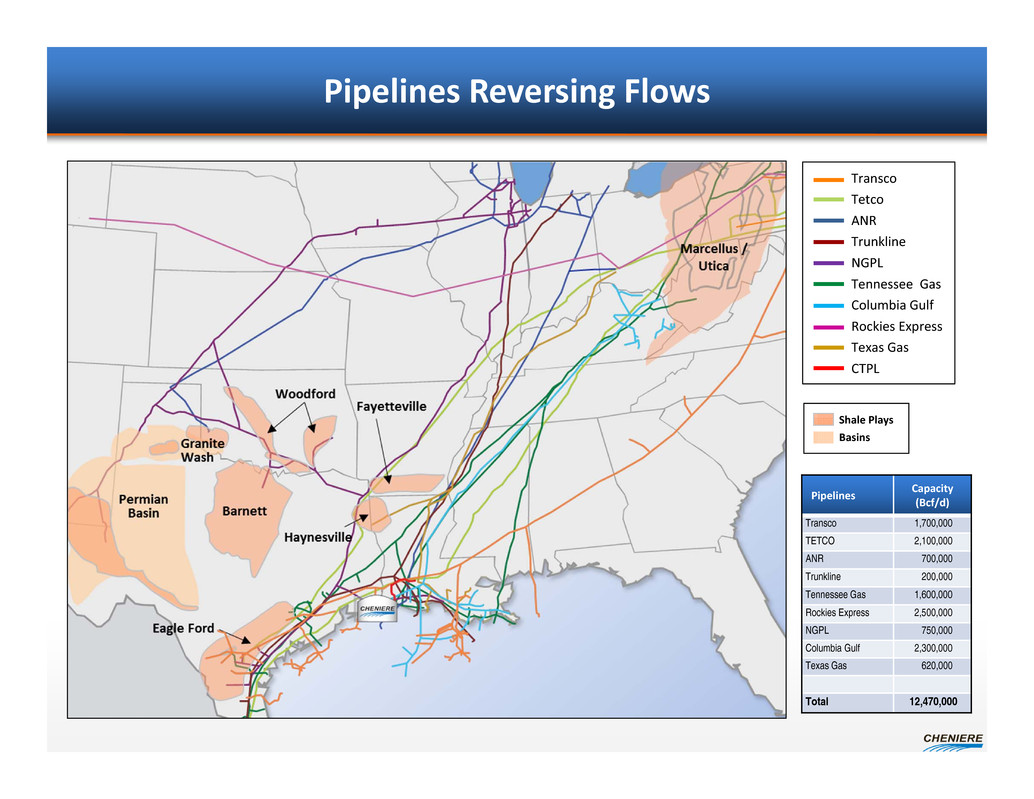

Pipelines Reversing Flows   Transco   Tetco   ANR   Trunkline   NGPL   Tennessee  Gas   Columbia Gulf   Rockies Express   Texas Gas   CTPL   Pipelines    Capacity    (Bcf/d)   Transco 1,700,000   TETCO 2,100,000   ANR 700,000   Trunkline 200,000   Tennessee Gas 1,600,000   Rockies Express 2,500,000   NGPL 750,000   Columbia Gulf 2,300,000   Texas Gas 620,000   Total 12,470,000   Shale Plays   Basins

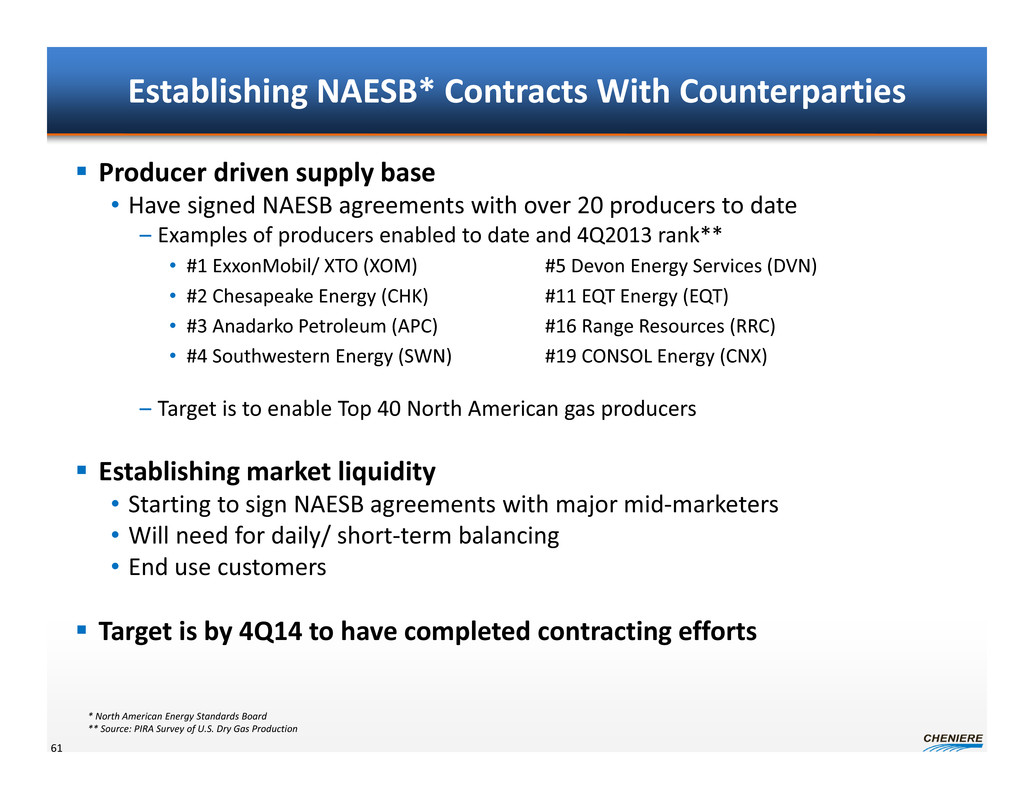

Establishing NAESB* Contracts With Counterparties    Producer driven supply base   • Have signed NAESB agreements with over 20 producers to date   – Examples of producers enabled to date and 4Q2013 rank**   • #1 ExxonMobil/ XTO (XOM)  #5 Devon Energy Services (DVN)   • #2 Chesapeake Energy (CHK) #11 EQT Energy (EQT)   • #3 Anadarko Petroleum (APC) #16 Range Resources (RRC)   • #4 Southwestern Energy (SWN) #19 CONSOL Energy (CNX)   – Target is to enable Top 40 North American gas producers    Establishing market liquidity   • Starting to sign NAESB agreements with major mid‐marketers   • Will need for daily/ short‐term balancing   • End use customers    Target is by 4Q14 to have completed contracting efforts   61   * North American Energy Standards Board   ** Source: PIRA Survey of U.S. Dry Gas Production

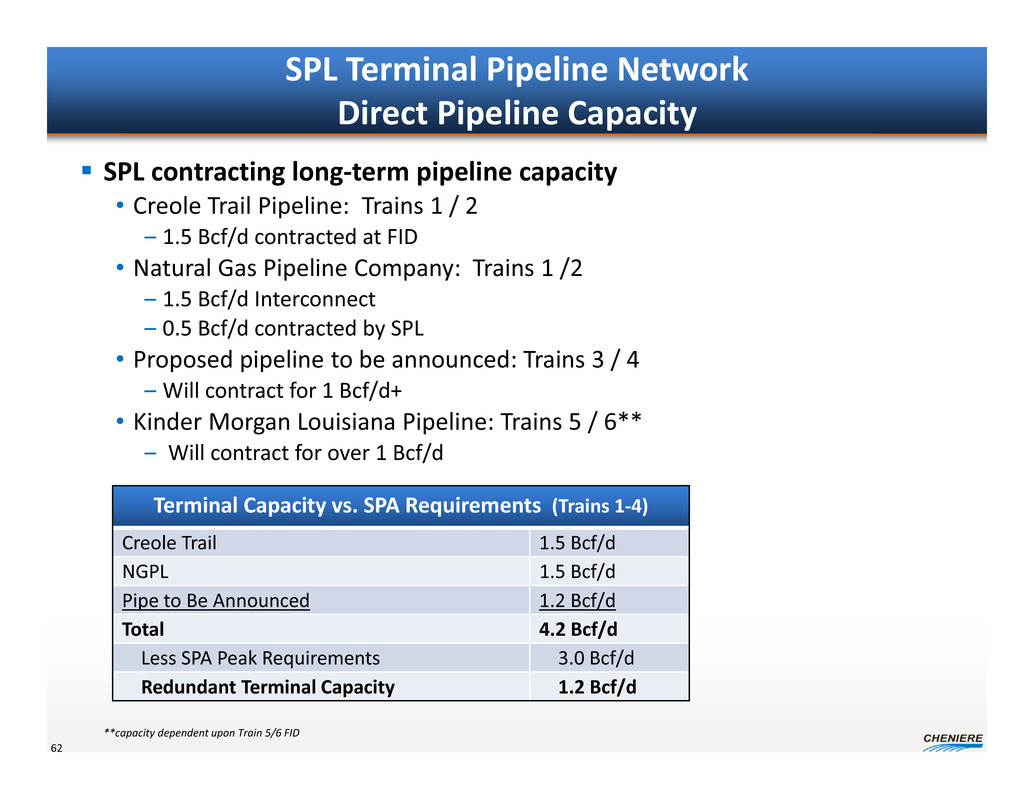

SPL Terminal Pipeline Network   Direct Pipeline Capacity    SPL contracting long‐term pipeline capacity   • Creole Trail Pipeline:  Trains 1 / 2    – 1.5 Bcf/d contracted at FID   • Natural Gas Pipeline Company:  Trains 1 /2    – 1.5 Bcf/d Interconnect   – 0.5 Bcf/d contracted by SPL   • Proposed pipeline to be announced: Trains 3 / 4    – Will contract for 1 Bcf/d+   • Kinder Morgan Louisiana Pipeline: Trains 5 / 6**   – Will contract for over 1 Bcf/d   62   Terminal Capacity vs. SPA Requirements  (Trains 1‐4)   Creole Trail 1.5 Bcf/d   NGPL 1.5 Bcf/d   Pipe to Be Announced 1.2 Bcf/d   Total 4.2 Bcf/d   Less SPA Peak Requirements 3.0 Bcf/d   Redundant Terminal Capacity 1.2 Bcf/d   **capacity dependent upon Train 5/6 FID

SPL Terminal Pipelines   63          Cheniere Creole Trail Pipeline (CTPL)             Kinder Morgan Louisiana Pipeline (KMLP)     Natural Gas Pipeline Company (NGPL)   Transco   .   Texas Eastern   TrunklineTransco   Pine Prairie   Energy Center   Texas Gas   ANR   TETCO   Tennessee   Trunkline   Columbia Gulf   NGPL   Sabine Pass LNG   Liquidity Points   Storage   Henry Hub

SPL Terminal Pipeline Network   Upstream Pipeline Capacity    Selectively contracting capacity from major supply basins:   • Utica/ Marcellus – TETCO, TGP, Texas Gas, CGT, Rockies Express   • Fayetteville – Trunkline, Texas Gas, ANR, NGPL, Columbia Gulf   • Perryville/ Haynesville ‐ Trunkline, Texas Gas, ANR, CGT   • MidContinent – NGPL, ANR, Panhandle Eastern   • Texas – NGPL, Transco, Trunkline    SPL will be able to access supplies from all major interstate pipelines    in South Louisiana    Having redundant capacities and optionality:   • Reduces risk of being subject to pipeline constraints or bottlenecks   • Provides access to lowest cost supply options   • Provides ability to manage maintenance or unscheduled outages   • Reduces dependence on one supplier, supply basin or source   64

Source: Lippman Consulting, Baker Hughes and Bentek, as of January 2014   SPL Supply Network   Transco   Tetco   ANR   Trunkline   NGPL   Tennessee Gas   Columbia Gulf   Rockies Express   Texas Gas   Permian   Basin Barnett   Granite    Wash   Eagle Ford   Haynesville   Woodford   Fayetteville   Marcellus /    Utica   Shale Plays   Basins    Sabine Pass

SPL Supply Transactions Completed    Sabine Pass has termed up a significant amount of long‐term    supply to date   • Staggered over time and train completion   • Accessing diverse supply basins   • Using existing portfolio of pipeline capacity to reach terminal   • Pricing to date provides terminal supply below 105% of NYMEX pricing   66

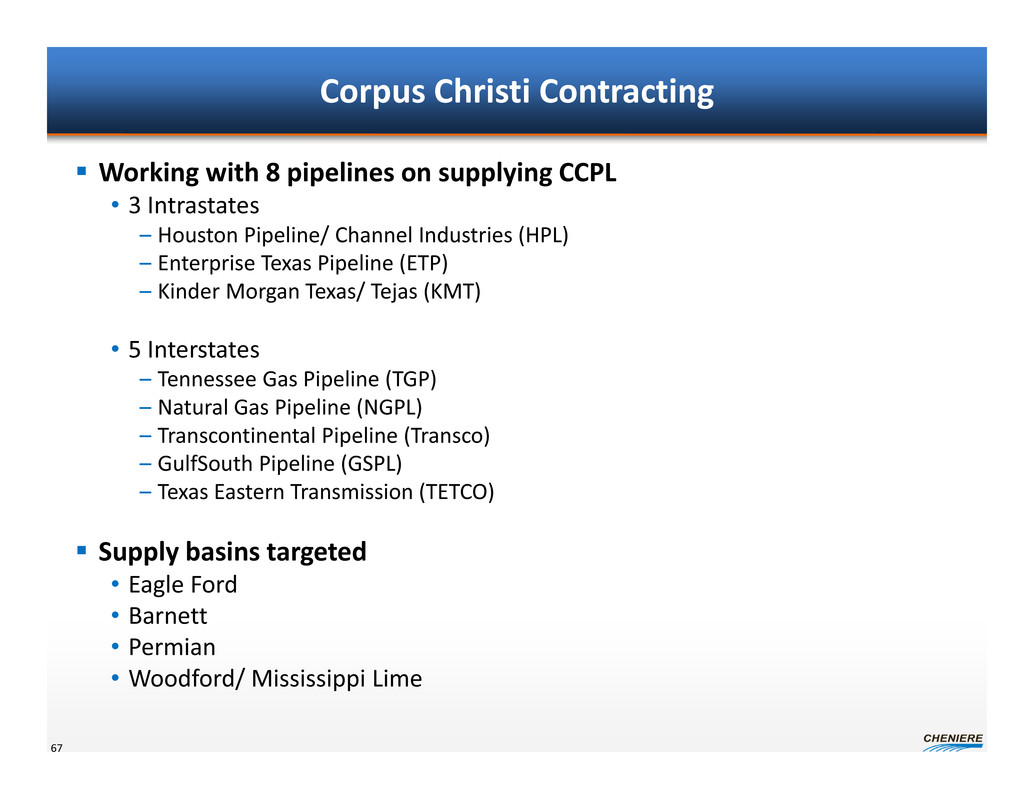

Corpus Christi Contracting    Working with 8 pipelines on supplying CCPL   • 3 Intrastates   – Houston Pipeline/ Channel Industries (HPL)   – Enterprise Texas Pipeline (ETP)   – Kinder Morgan Texas/ Tejas (KMT)   • 5 Interstates   – Tennessee Gas Pipeline (TGP)   – Natural Gas Pipeline (NGPL)   – Transcontinental Pipeline (Transco)   – GulfSouth Pipeline (GSPL)   – Texas Eastern Transmission (TETCO)    Supply basins targeted   • Eagle Ford   • Barnett   • Permian   • Woodford/ Mississippi Lime   67

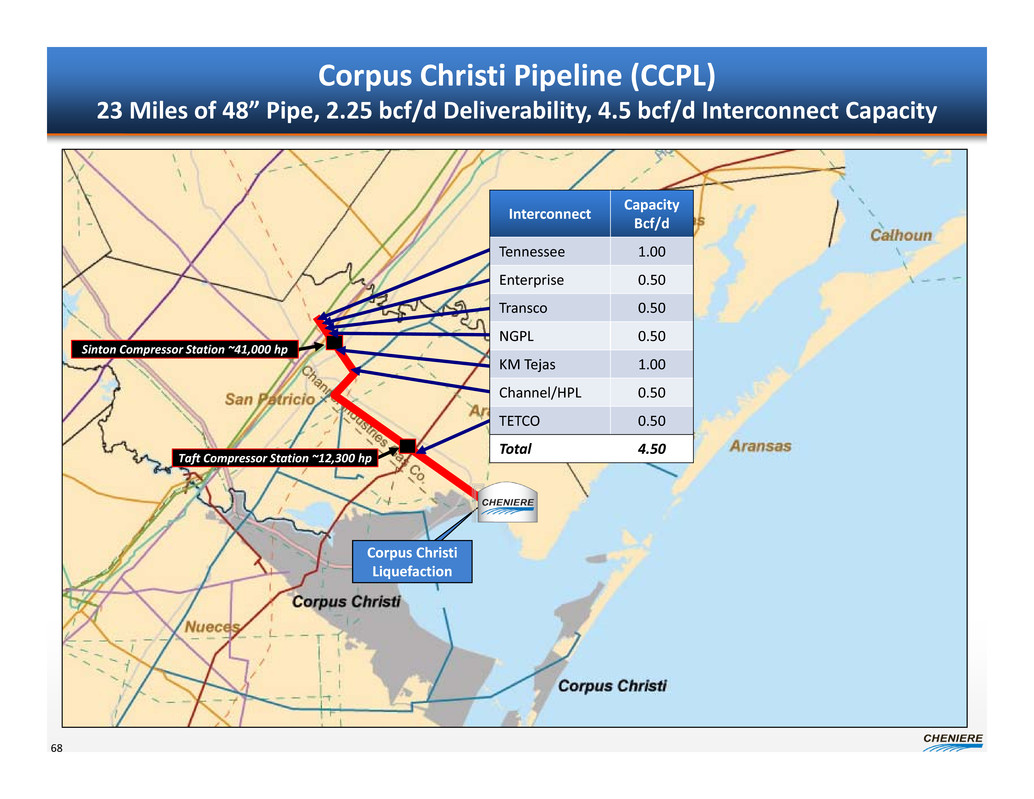

Corpus Christi Pipeline (CCPL)   23 Miles of 48” Pipe, 2.25 bcf/d Deliverability, 4.5 bcf/d Interconnect Capacity   68   Corpus Christi   Liquefaction   Interconnect   Capacity    Bcf/d   Tennessee 1.00   Enterprise 0.50   Transco 0.50   NGPL 0.50   KM Tejas 1.00   Channel/HPL 0.50   TETCO 0.50   Total 4.50   Sinton Compressor Station ~41,000 hp   Taft Compressor Station ~12,300 hp

Shale Plays   Basins    Source: Lippman Consulting, Baker Hughes and Bentek, as of January 2014   Corpus Christi Gas Supply Network   NGPL   Tennessee Gas   HPL   KM Tejas   Oasis   Enterprise   Permian   Basin   Barnett   Granite    Wash   Eagle Ford   Haynesville   Marcellus /    Utica   Corpus Christi   Source   Current    Rig    Count   Current    Production    Bcf/d   2020    est.   Bcf/d   Barnett 30 5.3 4.7   Haynesville 41 4.6 7.2   Eagle Ford 221 4.6 9.4   Marcellus 82 12.3 20.0   Permian 487 4.8 5.6   Granite Wash 54 1.4 1.2   Woodford 46 1.6 2.5   Woodford

Cheniere Ongoing Supply Strategy    Sabine Pass   • Continue to purchase gas supply and strategically fill existing pipeline capacity   – Currently in discussion with 15+ counterparties on term deals   – Structuring deals to best mitigate both physical risk and price risk   • Acquire strategic upstream pipeline capacity   – Actively negotiating with 10+ interstate natural gas pipelines    – Diversify supply basins to manage physical risk    Corpus Christi   • Continue to develop pipeline infrastructure into CCPL with intent of    contracting upon project FID   • Engage producers and begin contracting for long term supply   70

Meg Gentle, Executive VP – Marketing   April 2014   Commercializing Corpus Christi & Sabine Pass T6   Analyst / Investor Day

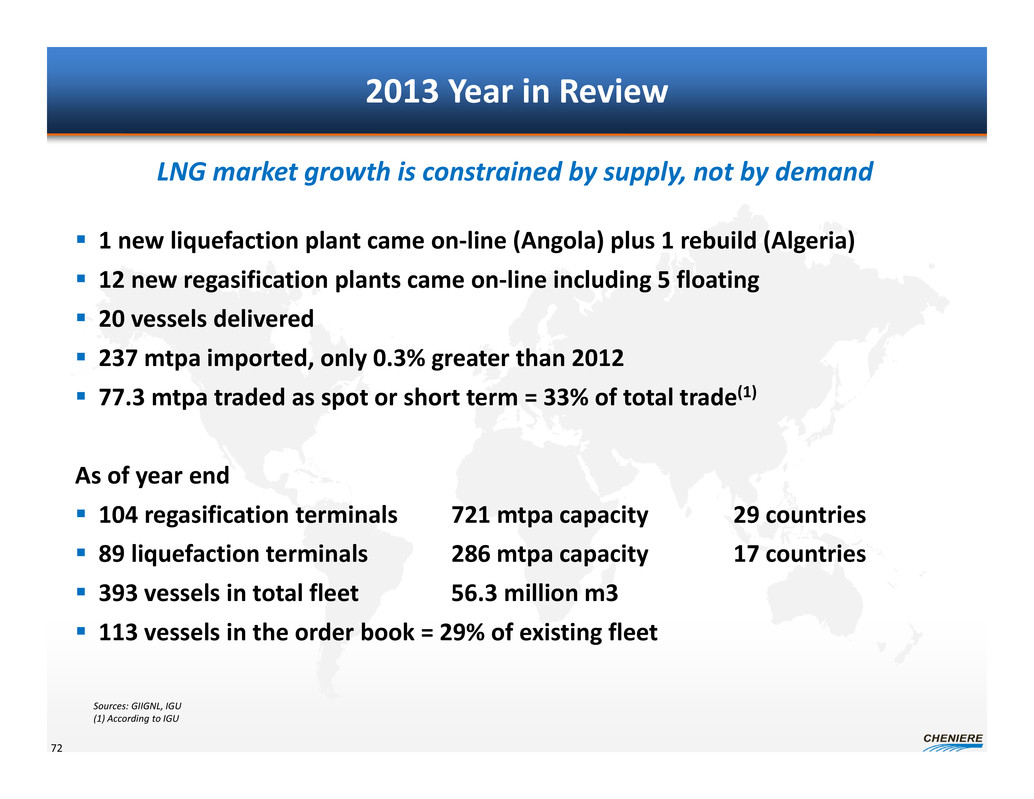

2013 Year in Review    1 new liquefaction plant came on‐line (Angola) plus 1 rebuild (Algeria)    12 new regasification plants came on‐line including 5 floating    20 vessels delivered    237 mtpa imported, only 0.3% greater than 2012    77.3 mtpa traded as spot or short term = 33% of total trade(1)   As of year end    104 regasification terminals 721 mtpa capacity 29 countries    89 liquefaction terminals 286 mtpa capacity 17 countries    393 vessels in total fleet 56.3 million m3    113 vessels in the order book = 29% of existing fleet   LNG market growth is constrained by supply, not by demand   Sources: GIIGNL, IGU   (1) According to IGU   72

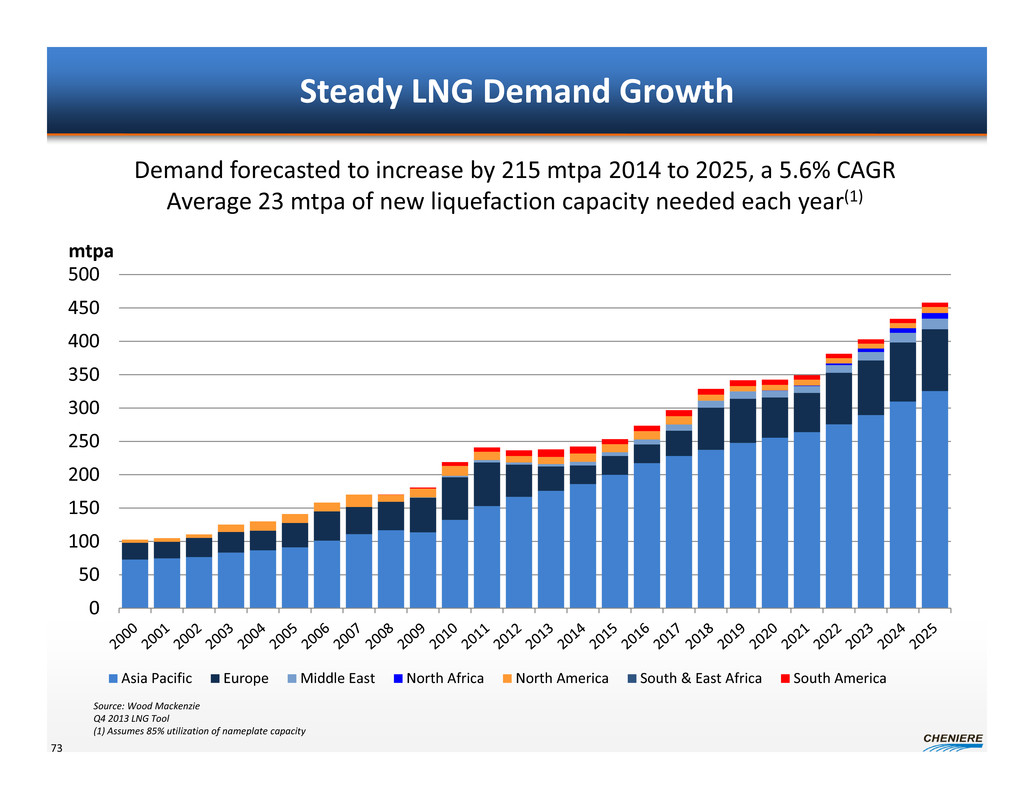

Steady LNG Demand Growth   0   50   100   150   200   250   300   350   400   450   500   mtpa   Asia Pacific Europe Middle East North Africa North America South & East Africa South America   73   Source: Wood Mackenzie   Q4 2013 LNG Tool   (1) Assumes 85% utilization of nameplate capacity   Demand forecasted to increase by 215 mtpa 2014 to 2025, a 5.6% CAGR   Average 23 mtpa of new liquefaction capacity needed each year(1)

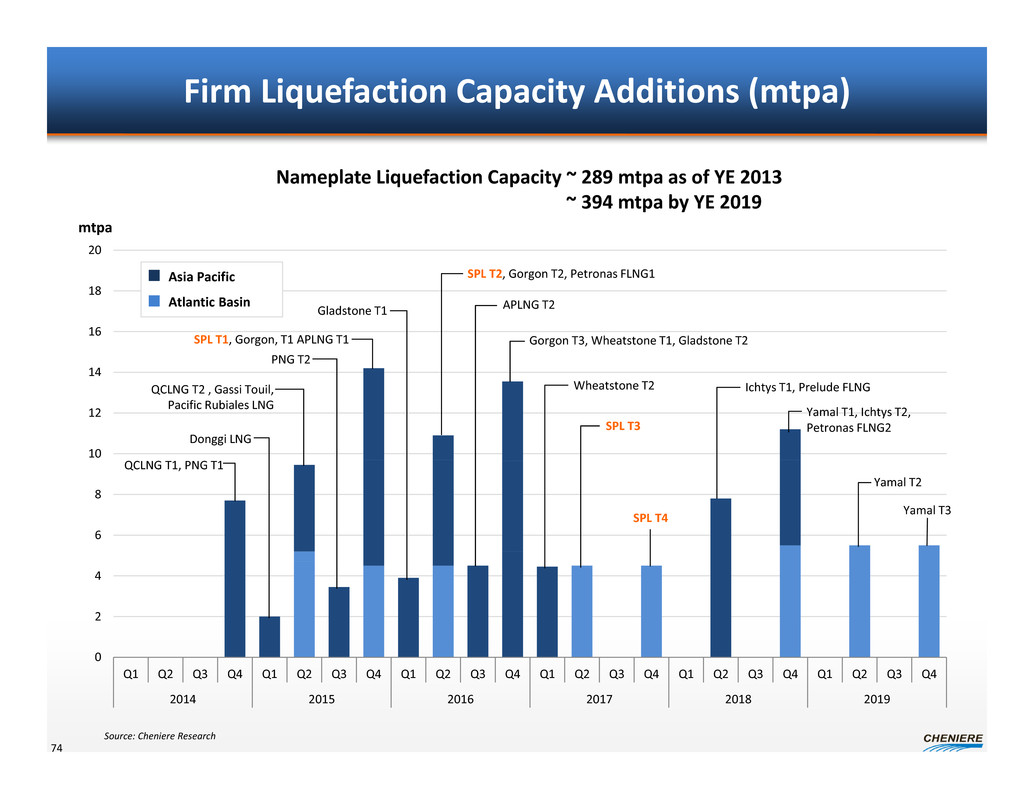

0   2   4   6   8   10   12   14   16   18   20   Q1 Q2 Q3 Q4 Q1 Q2 Q3 Q4 Q1 Q2 Q3 Q4 Q1 Q2 Q3 Q4 Q1 Q2 Q3 Q4 Q1 Q2 Q3 Q4   2014 2015 2016 2017 2018 2019   Firm Liquefaction Capacity Additions (mtpa)   74   Source: Cheniere Research   Nameplate Liquefaction Capacity ~ 289 mtpa as of YE 2013   ~ 394 mtpa by YE 2019       QCLNG T1, PNG T1   SPL T1, Gorgon, T1 APLNG T1   QCLNG T2 , Gassi Touil,   Pacific Rubiales LNG   PNG T2   Gorgon T3, Wheatstone T1, Gladstone T2   Gladstone T1   Wheatstone T2   APLNG T2   SPL T3   Yamal T1, Ichtys T2,    Petronas FLNG2   Ichtys T1, Prelude FLNG   Yamal T2   SPL T2, Gorgon T2, Petronas FLNG1   SPL T4   Yamal T3   Donggi LNG   Asia Pacific   Atlantic Basin   mtpa

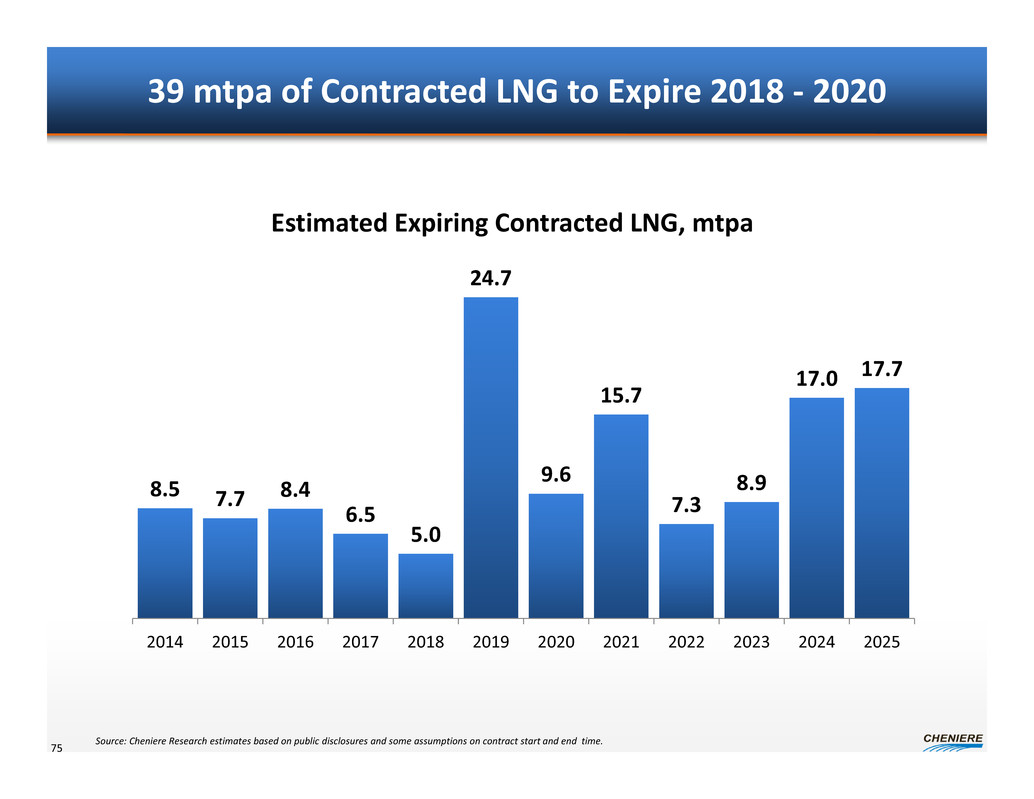

39 mtpa of Contracted LNG to Expire 2018 ‐ 2020   75   8.5 7.7 8.4   6.5   5.0   24.7   9.6   15.7   7.3   8.9   17.0 17.7   2014 2015 2016 2017 2018 2019 2020 2021 2022 2023 2024 2025   Estimated Expiring Contracted LNG, mtpa   Source: Cheniere Research estimates based on public disclosures and some assumptions on contract start and end  time.

What is our competitive advantage?   76   1. Low cost natural gas and Henry Hub pricing   2. Low cost construction   3. Full destination flexibility   4. Ability to cancel cargo lifting with notice   5. Contract structure – FOB tailgate vs tolling   6. Proven record of execution   7. On time / on budget construction   8. Short time to market   9. Financing reliability   10. Stable regulatory and political system

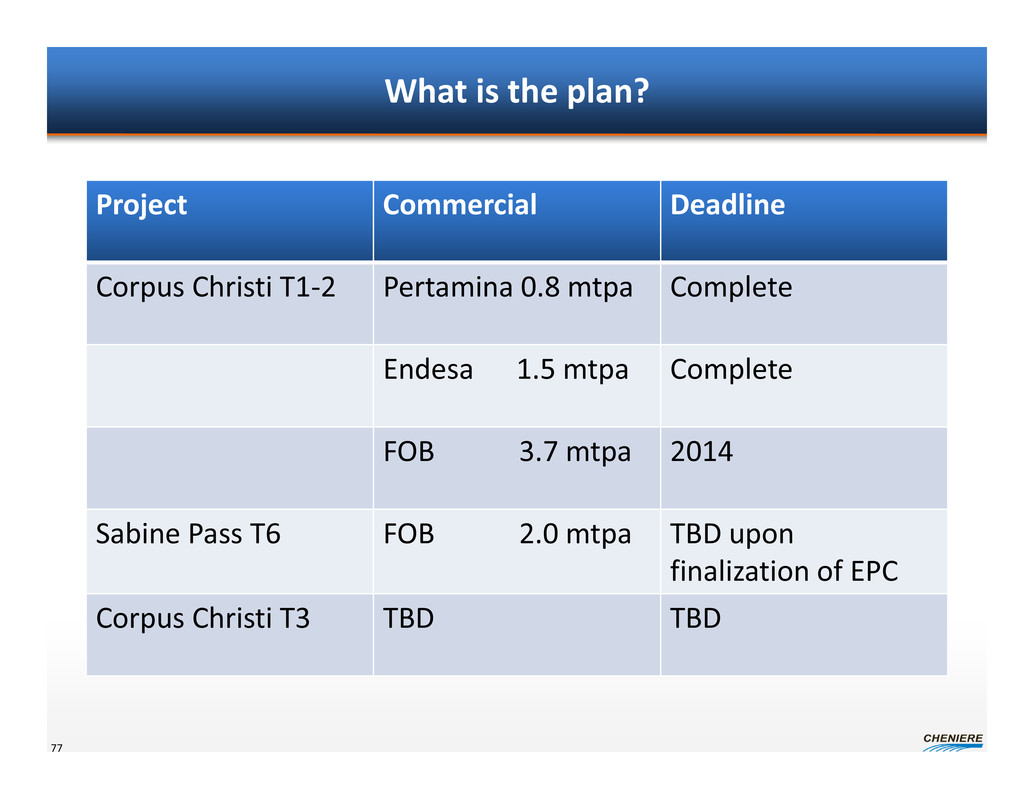

What is the plan?   77   Project Commercial Deadline   Corpus Christi T1‐2 Pertamina 0.8 mtpa Complete    Endesa 1.5 mtpa Complete   FOB            3.7 mtpa 2014   Sabine Pass T6 FOB            2.0 mtpa TBD upon    finalization of EPC   Corpus Christi T3 TBD TBD

Short Term and Medium Term Marketing

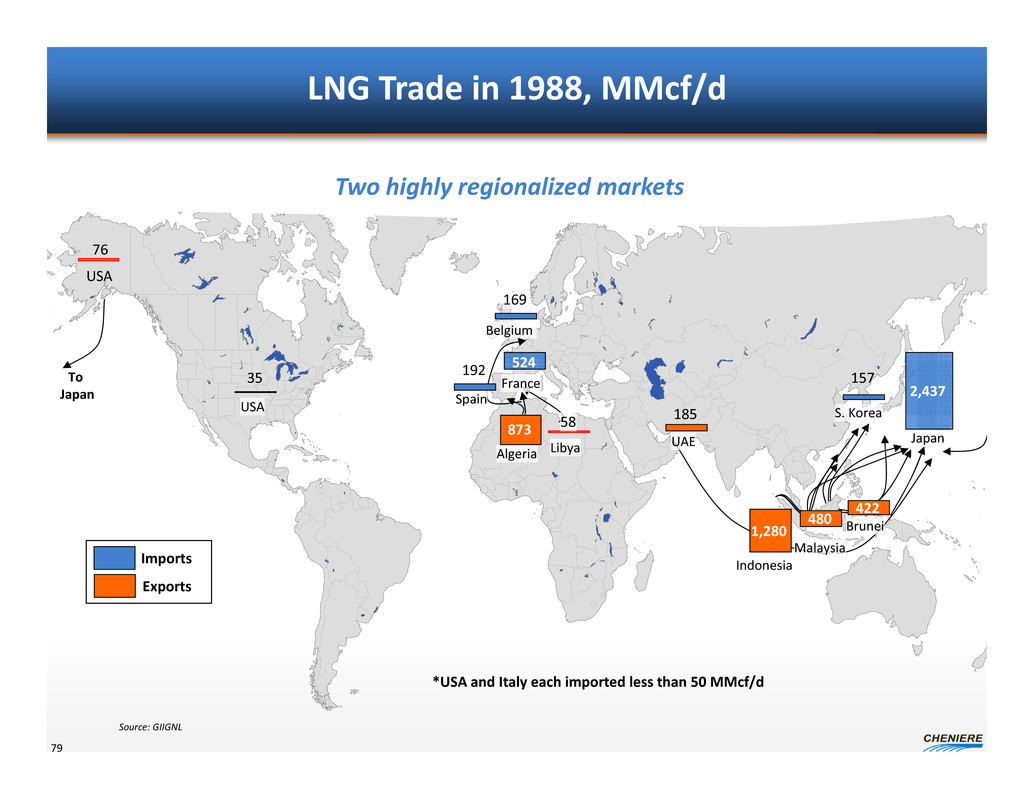

LNG Trade in 1988, MMcf/d   *USA and Italy each imported less than 50 MMcf/d   USA   Libya   Japan   S. KoreaUSA   Belgium    Imports   Exports   Algeria   Indonesia   Malaysia   Brunei   UAE   Spain   FranceTo    Japan 2,437   15719235   524   169   1,280   480   422   185   76   58873   Two highly regionalized markets   Source: GIIGNL    79

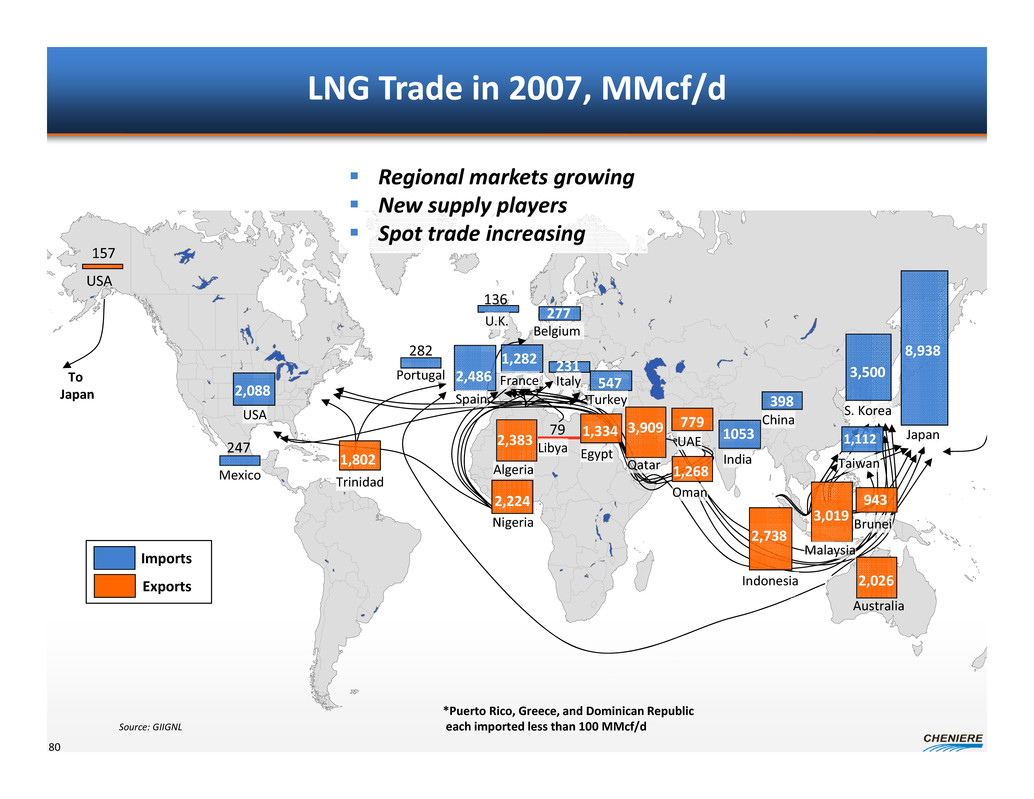

LNG Trade in 2007, MMcf/d   80   2,026   779   157   79   Trinidad   Nigeria   Australia   USA   Libya   8,938   3,500   2,088   231   Japan   S. KoreaUSA   Italy   Belgium    *Puerto Rico, Greece, and Dominican Republic    each imported less than 100 MMcf/d   Imports   Exports   Algeria   2,383   3,019   Indonesia   Malaysia   1,112   Taiwan   Brunei   943   2,738   Oman   UAE   Qatar 1,268   2,486   Turkey   1,282   Spain   FranceTo    Japan    Regional markets growing    New supply players    Spot trade increasing   1053   India   547   247   Portugal   3,9091,334   Egypt   277   2,224   Source: GIIGNL    282   Mexico   398   China   136   U.K.   1,802

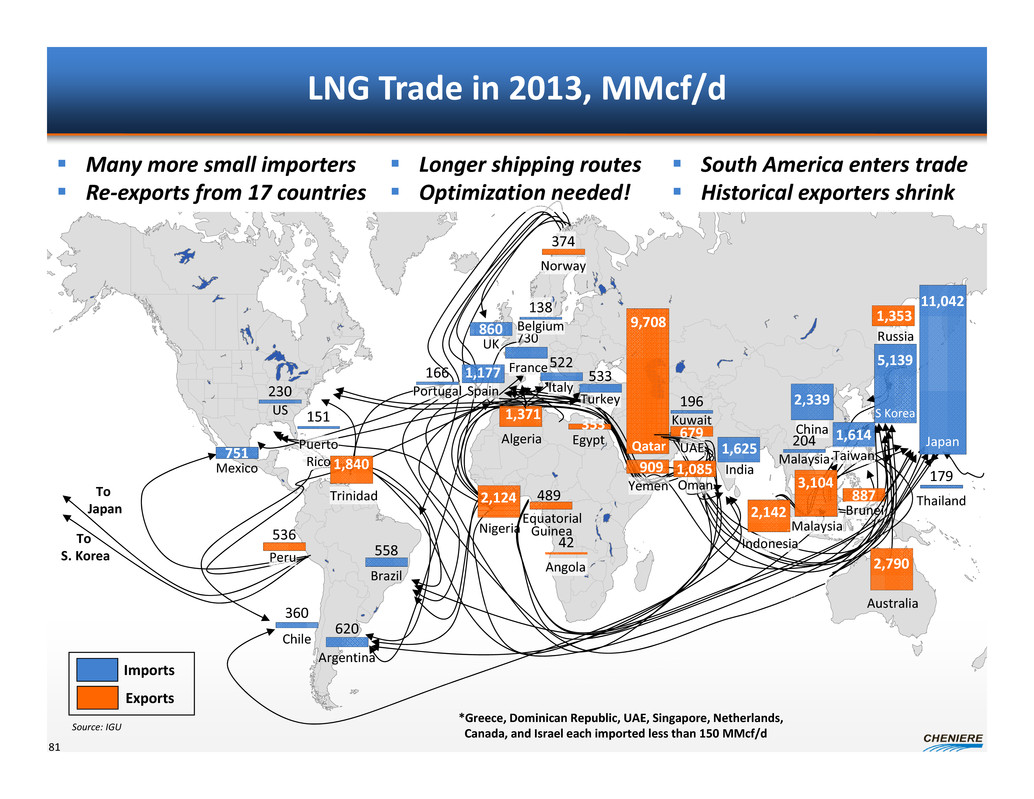

LNG Trade in 2013, MMcf/d   81   *Greece, Dominican Republic, UAE, Singapore, Netherlands,    Canada, and Israel each imported less than 150 MMcf/d   Imports   Exports    Many more small importers    Re‐exports from 17 countries   Source: IGU   1,371    887   353    489    2,142   536   1,353    Algeria   Australia   Brunei   Egypt   Equatorial   GuineaNigeria   9,708    Qatar   Russia   Trinidad   Peru   To    Japan   To    S. Korea   2,124   Indonesia   3,104   Malaysia   374   Norway   2,790   Oman   1,085   UAE   679   Yemen   909    2,339   China   11,042   Japan   5,139   S Korea   Taiwan   1,614   France   730   Belgium   138   Italy   522   Turkey   533   UK   860   Argentina   620   558   Brazil   Chile   360   751   Mexico   Portugal   166   230   US   196   Kuwait   204   Malaysia   179   Thailand   151   Puerto   Rico    Longer shipping routes    Optimization needed!   1,840   Angola   42   India   1,625   Spain   1,177    South America enters trade    Historical exporters shrink

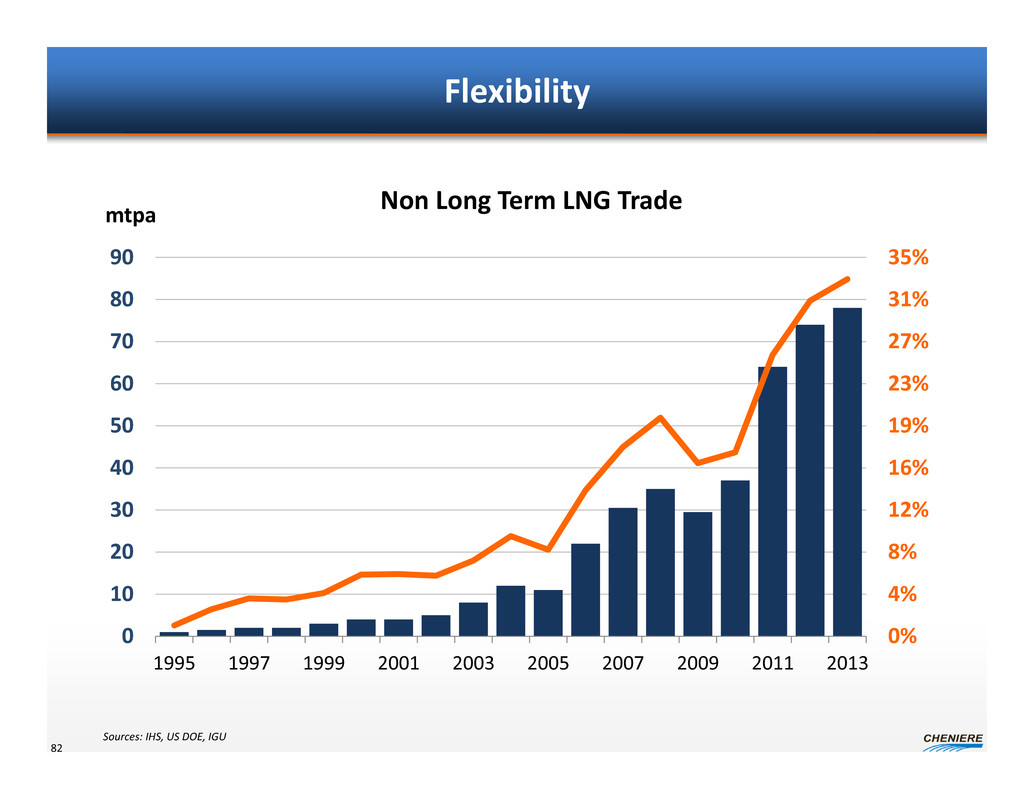

Flexibility   82   0%   4%   8%   12%   16%   19%   23%   27%   31%   35%   0   10   20   30   40   50   60   70   80   90   1995 1997 1999 2001 2003 2005 2007 2009 2011 2013   mtpa   Non Long Term LNG Trade   Sources: IHS, US DOE, IGU

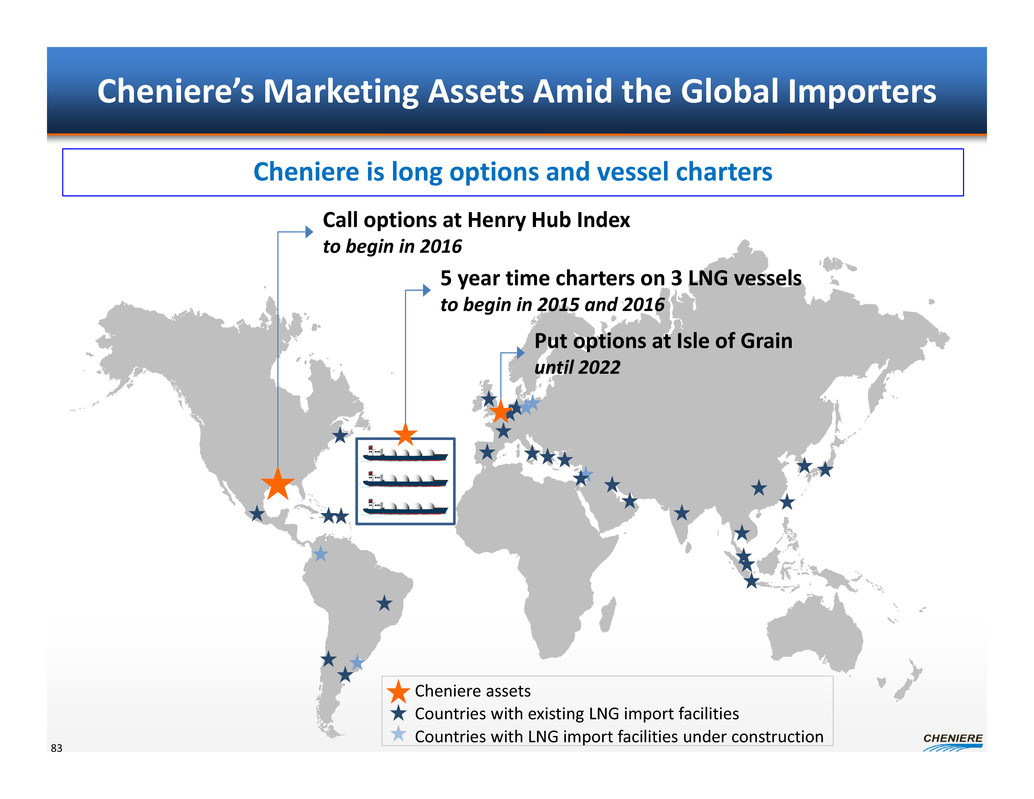

Cheniere’s Marketing Assets Amid the Global Importers   Call options at Henry Hub Index   to begin in 2016   Put options at Isle of Grain    until 2022   5 year time charters on 3 LNG vessels   to begin in 2015 and 2016   Cheniere is long options and vessel charters   Cheniere assets   Countries with existing LNG import facilities    Countries with LNG import facilities under construction   83

Futures Prices Support $7.25 / MMBtu Intrinsic Margin    $  9.70 / MMBtu – gross margins realized from purchasing LNG at 115% of HH and    selling at 15% of Brent; higher in the prompt month    $ 7.25 / MMBtu – intrinsic margins net of shipping, boil‐off & fuel to Asia   84   $0   $13   $26   $39   $52   $64   $77   $90   $103   $116   $0   $2   $4   $6   $8   $10   $12   $14   $16   $18   May‐14 Nov‐14 May‐15 Nov‐15 May‐16 Nov‐16 May‐17 Nov‐17 May‐18 Nov‐18   $/Bbl$/MMBtu Brent and Henry Hub:  5 Years Futures Prices   Henry Hub   115% Henry Hub   Brent   15% Brent   $10.83 / MMBtu

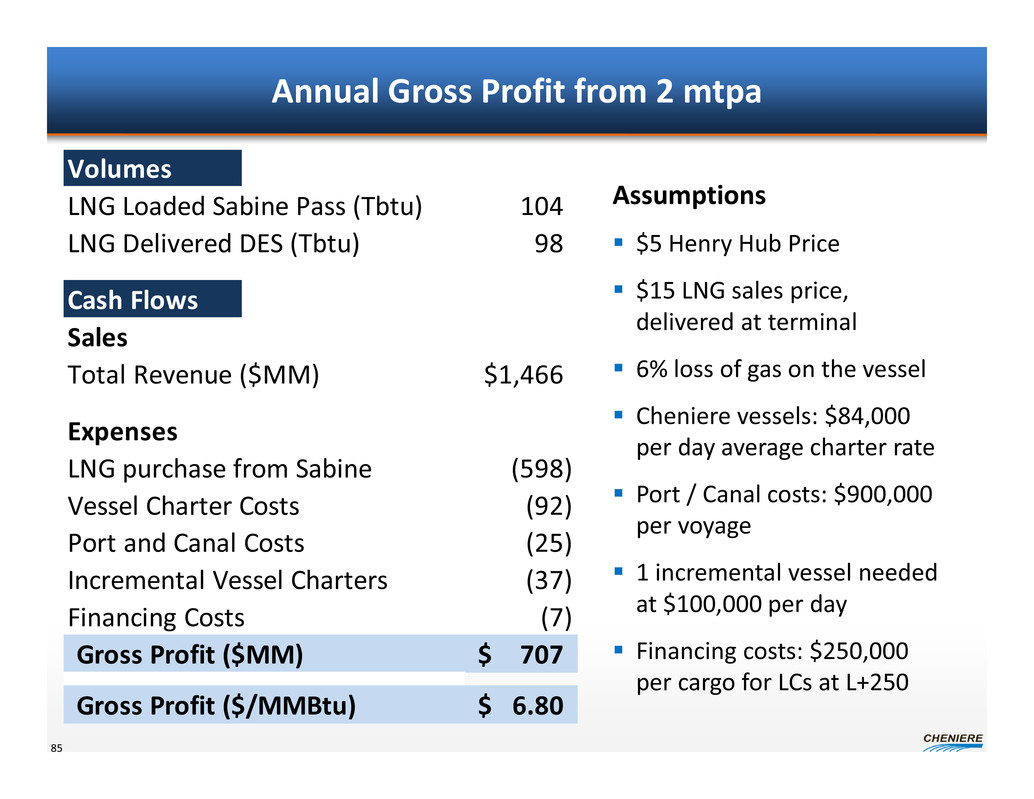

Annual Gross Profit from 2 mtpa   85   Assumptions    $5 Henry Hub Price    $15 LNG sales price,    delivered at terminal    6% loss of gas on the vessel    Cheniere vessels: $84,000    per day average charter rate    Port / Canal costs: $900,000    per voyage    1 incremental vessel needed   at $100,000 per day    Financing costs: $250,000    per cargo for LCs at L+250   Volumes   LNG Loaded Sabine Pass (Tbtu) 104          LNG Delivered DES (Tbtu) 98            Cash Flows   Sales   Total Revenue ($MM) 1,466$    Expenses   LNG purchase from Sabine (598)        Vessel Charter Costs (92)           Port and Canal Costs (25)           Incremental Vessel Charters (37)           Financing Costs (7)             Gross Profit ($MM) 707$        Gross Profit ($/MMBtu) 6.80$

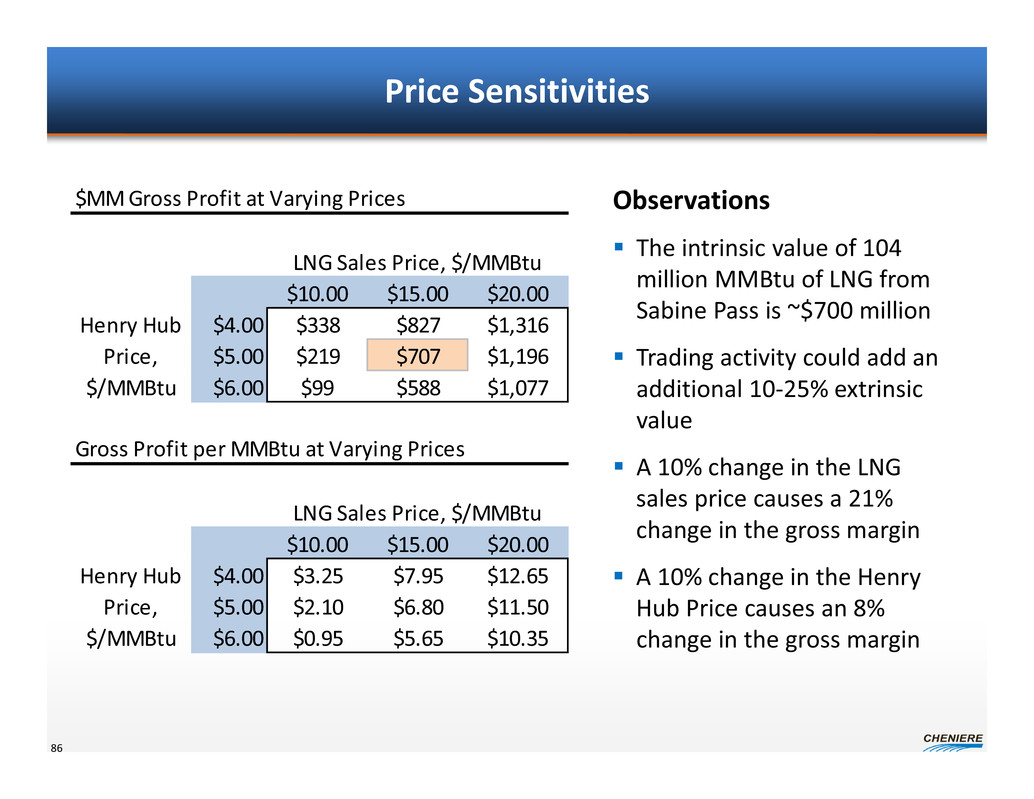

Price Sensitivities   86   Observations    The intrinsic value of 104    million MMBtu of LNG from    Sabine Pass is ~$700 million    Trading activity could add an    additional 10‐25% extrinsic    value    A 10% change in the LNG    sales price causes a 21%    change in the gross margin    A 10% change in the Henry    Hub Price causes an 8%    change in the gross margin   $MM Gross Profit at Varying Prices   LNG Sales Price, $/MMBtu   $10.00 $15.00 $20.00   $4.00 $338 $827 $1,316   $5.00 $219 $707 $1,196   $6.00 $99 $588 $1,077   Henry Hub    Price,    $/MMBtu   Gross Profit per MMBtu at Varying Prices   LNG Sales Price, $/MMBtu   $10.00 $15.00 $20.00   $4.00 $3.25 $7.95 $12.65   $5.00 $2.10 $6.80 $11.50   $6.00 $0.95 $5.65 $10.35   Henry Hub    Price,    $/MMBtu

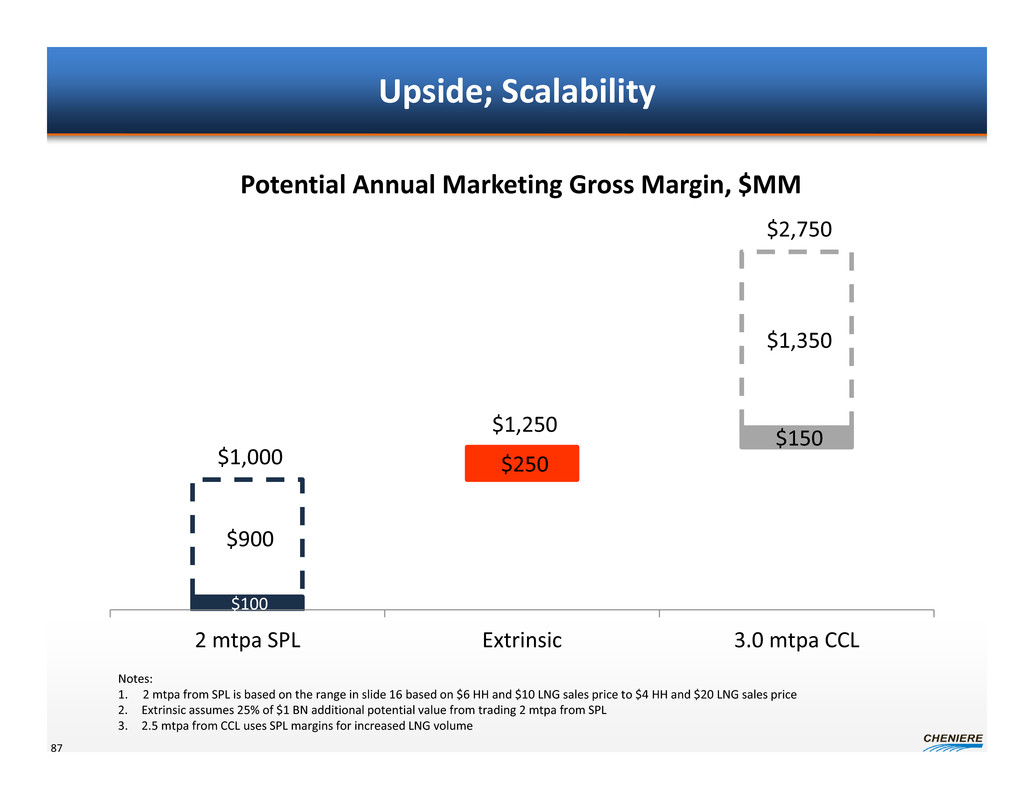

Upside; Scalability   87   $100    $900    $150    $250    $1,350    $1,000    $1,250    $2,750    2 mtpa SPL Extrinsic 3.0 mtpa CCL   Potential Annual Marketing Gross Margin, $MM   Notes:   1.     2 mtpa from SPL is based on the range in slide 16 based on $6 HH and $10 LNG sales price to $4 HH and $20 LNG sales price   2. Extrinsic assumes 25% of $1 BN additional potential value from trading 2 mtpa from SPL   3. 2.5 mtpa from CCL uses SPL margins for increased LNG volume

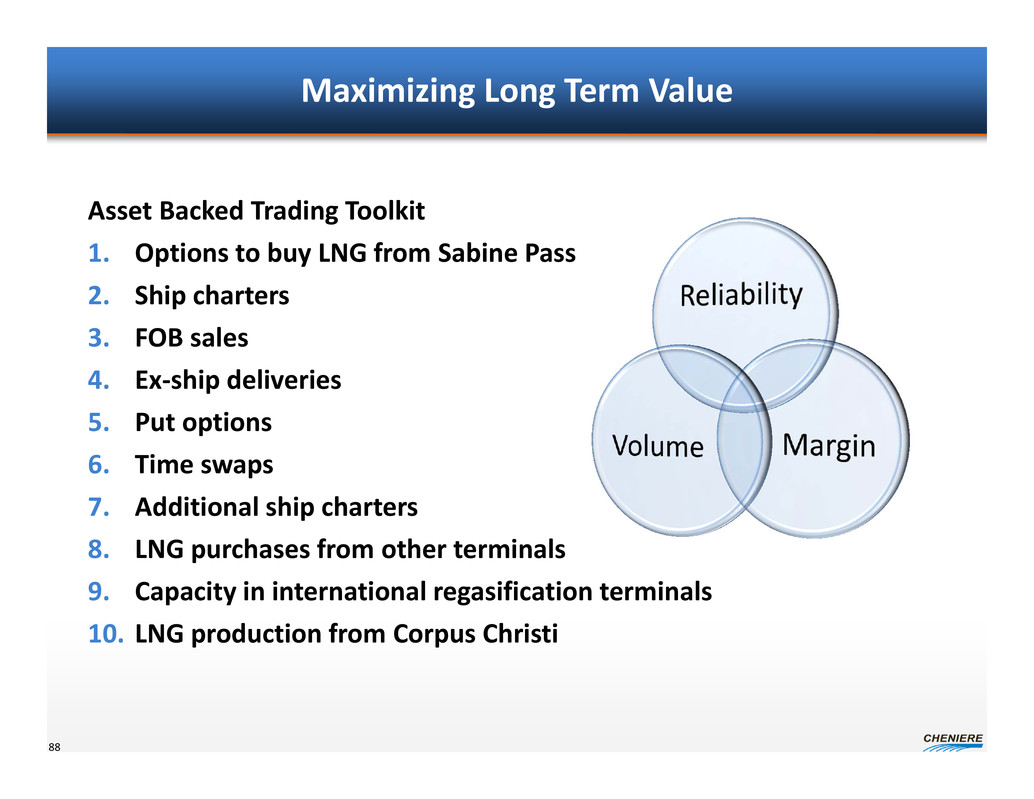

88   Maximizing Long Term Value   Asset Backed Trading Toolkit   1. Options to buy LNG from Sabine Pass   2. Ship charters   3. FOB sales   4. Ex‐ship deliveries   5. Put options   6. Time swaps   7. Additional ship charters   8. LNG purchases from other terminals   9. Capacity in international regasification terminals   10. LNG production from Corpus Christi

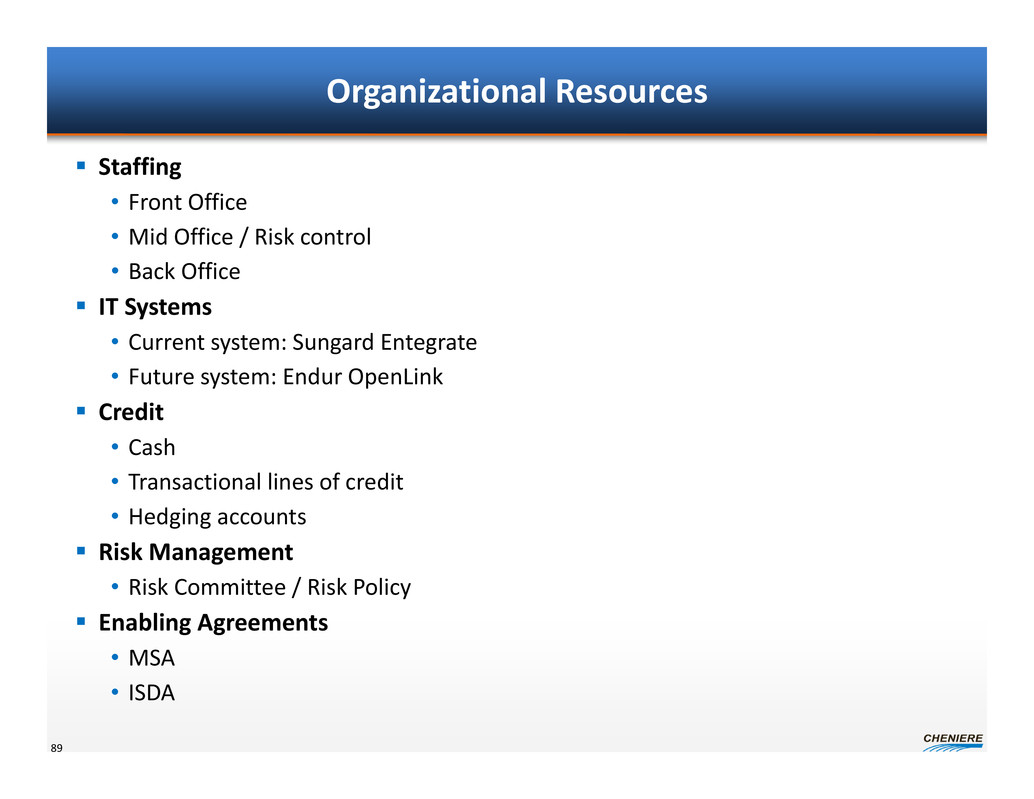

Organizational Resources    Staffing   • Front Office   • Mid Office / Risk control   • Back Office    IT Systems   • Current system: Sungard Entegrate   • Future system: Endur OpenLink    Credit   • Cash   • Transactional lines of credit   • Hedging accounts    Risk Management   • Risk Committee / Risk Policy     Enabling Agreements   • MSA   • ISDA   89

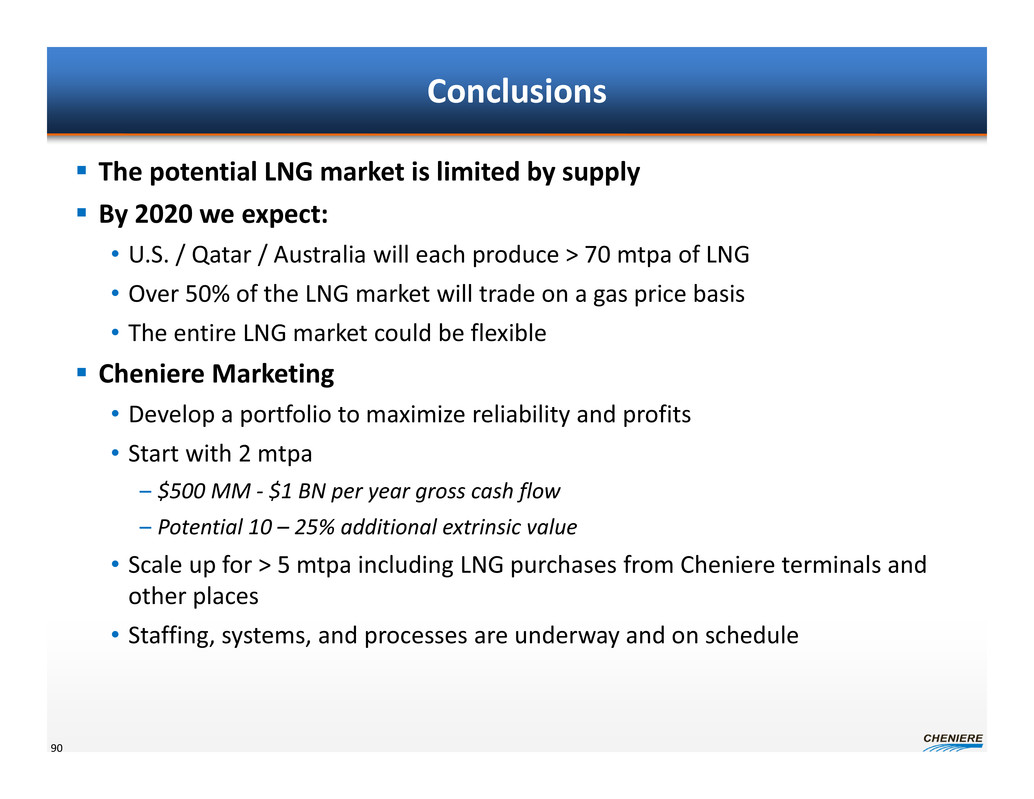

Conclusions    The potential LNG market is limited by supply    By 2020 we expect:   • U.S. / Qatar / Australia will each produce > 70 mtpa of LNG   • Over 50% of the LNG market will trade on a gas price basis   • The entire LNG market could be flexible    Cheniere Marketing    • Develop a portfolio to maximize reliability and profits   • Start with 2 mtpa   – $500 MM ‐ $1 BN per year gross cash flow   – Potential 10 – 25% additional extrinsic value   • Scale up for > 5 mtpa including LNG purchases from Cheniere terminals and    other places   • Staffing, systems, and processes are underway and on schedule   90

Michael Wortley, Chief Financial Officer   April 2014   Financial Update   Analyst / Investor Day Conference

–   $5   $10   $15   $20   – 200 400 600 800 1,000 1,200   U   S       G   a   s       S   u   p   p   l   y       P   r   i   c   e       (   $   /   M   M   B   t   u   )   US Unconventional Reserves (Tcf)   1,000 Tcf economical in Asia at ~$14/MMBtu   US LNG Well Positioned for Growth    US Unconventional Gas(1,4) Supply Curve    US has a tremendous resource base at low cost   • 1,000 Tcf of unconventional gas reserves(1) recoverable at prices less than $7/MMBtu    Equivalent to 27 Bcf/d of incremental production assuming a 100 year horizon    Demand for LNG expected to increase 2.4x faster than global natural gas    • 4.6%(2) p.a. through 2030 (vs. 1.9%(3) p.a. for global gas)    Cheap US natural gas has the potential to take material market share from oil   • Total displacement of diesel & fuel oil in Asian power generation would increase global demand by 19 Bcf/d   Incremental Gas Demand from Oil Switching in Global Power Sector(5)   1,000 Tcf economical in US at ~$7/MMBtu   ~$19.50 average diesel and fuel oil costs in Asia   • 115% HH, plus   • $3.50/MMBtu liquefaction fee, plus   • $3.00/MMBtu shipping to Asia   (1)             Cost resource analysis per Advanced Resources International research assuming 15% pre‐tax unlevered return hurdle, $90 WTI and NGL prices between 42‐52% of WTI.   (2)             Wood Mackenzie, as of Q4 2013.   (3)             BP Energy Outlook 2035, January 2014.   (4)             Includes Barnett, Cana‐Woodford, Eagleford, Granite Wash, Haynesville/Bossier, Marcellus, Permian and Utica.   (5)  United Nations Statistics Division ‐ Energy Statistics Database.92   (4)

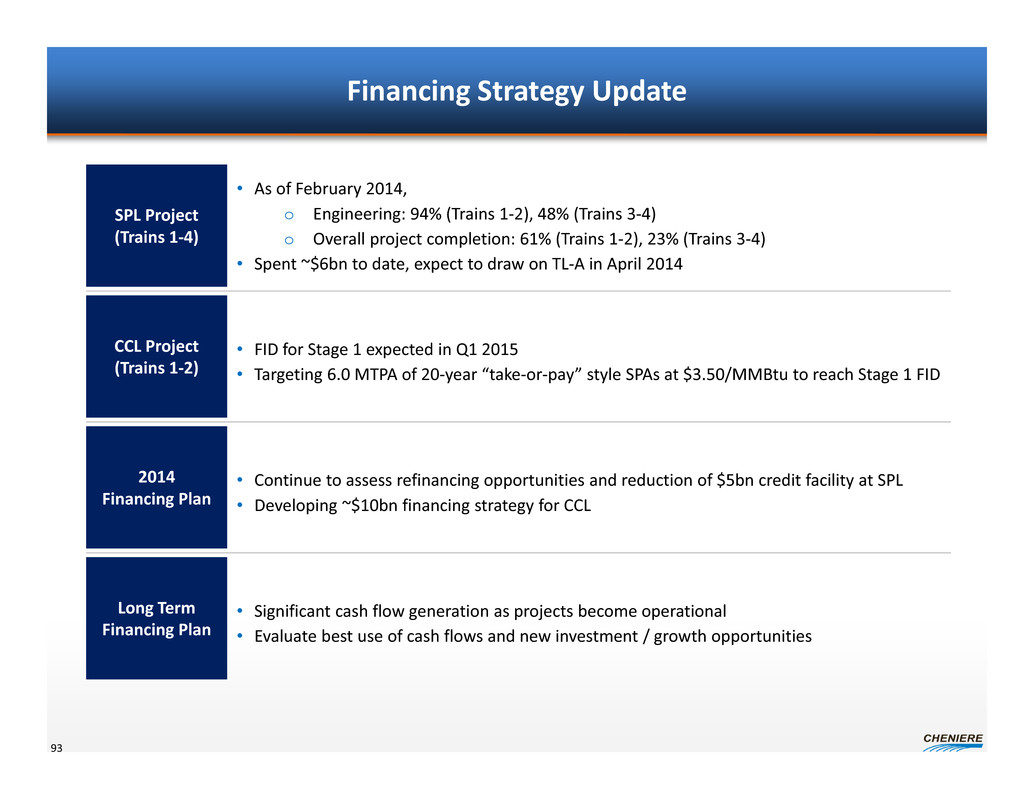

Financing Strategy Update   93   SPL Project    (Trains 1‐4)   CCL Project    (Trains 1‐2)   2014    Financing Plan   • As of February 2014,    o Engineering: 94% (Trains 1‐2), 48% (Trains 3‐4)   o Overall project completion: 61% (Trains 1‐2), 23% (Trains 3‐4)   • Spent ~$6bn to date, expect to draw on TL‐A in April 2014   Long Term    Financing Plan   • FID for Stage 1 expected in Q1 2015   • Targeting 6.0 MTPA of 20‐year “take‐or‐pay” style SPAs at $3.50/MMBtu to reach Stage 1 FID   • Continue to assess refinancing opportunities and reduction of $5bn credit facility at SPL   • Developing ~$10bn financing strategy for CCL   • Significant cash flow generation as projects become operational   • Evaluate best use of cash flows and new investment / growth opportunities

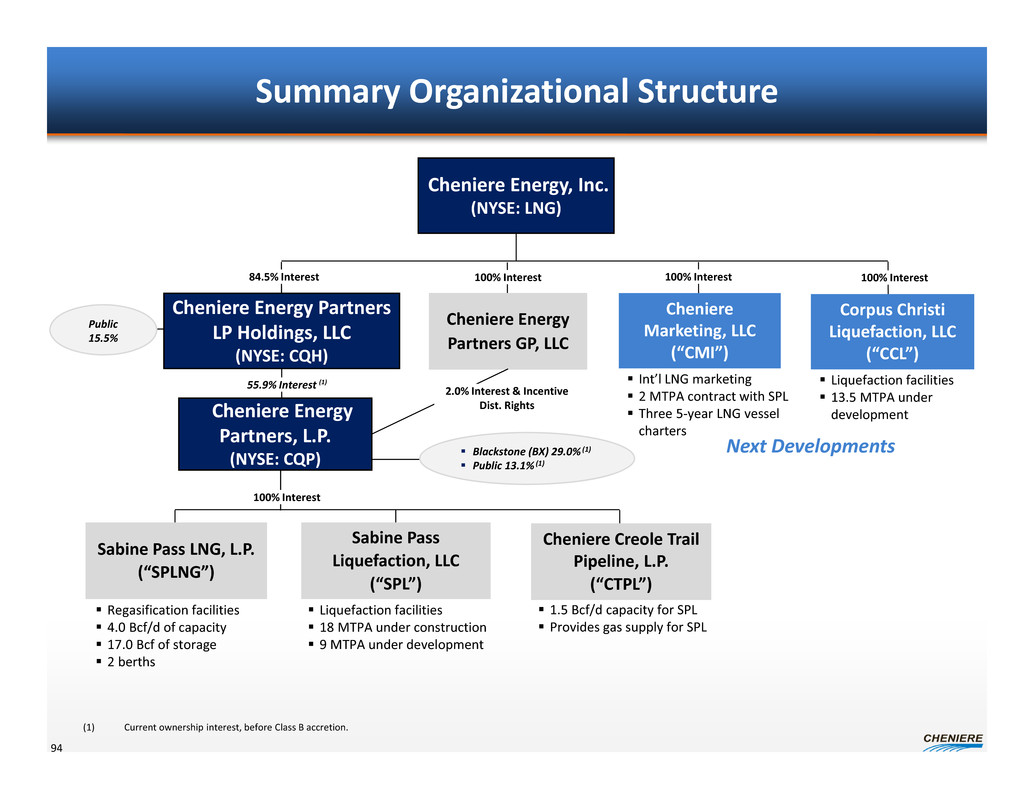

Summary Organizational Structure   94   Cheniere Energy, Inc.    (NYSE: LNG)   Sabine Pass LNG, L.P.   (“SPLNG”)    Sabine Pass    Liquefaction, LLC   (“SPL”)   Cheniere Energy    Partners, L.P.   (NYSE: CQP)   Cheniere Creole Trail    Pipeline, L.P.    (“CTPL”)   Corpus Christi    Liquefaction, LLC   (“CCL”)   Cheniere    Marketing, LLC   (“CMI”)    Cheniere Energy    Partners GP, LLC   100% Interest   100% Interest 100% Interest100% Interest    Liquefaction facilities    13.5 MTPA under    development    Regasification facilities    4.0 Bcf/d of capacity    17.0 Bcf of storage    2 berths    Liquefaction facilities    18 MTPA under construction    9 MTPA under development   Cheniere Energy Partners    LP Holdings, LLC   (NYSE: CQH)    1.5 Bcf/d capacity for SPL    Provides gas supply for SPL   84.5% Interest   55.9% Interest (1)   2.0% Interest & Incentive    Dist. Rights    Int’l LNG marketing    2 MTPA contract with SPL    Three 5‐year LNG vessel    charters    Blackstone (BX) 29.0% (1)    Public 13.1% (1)   Public    15.5%   Next Developments   (1)             Current ownership interest, before Class B accretion.

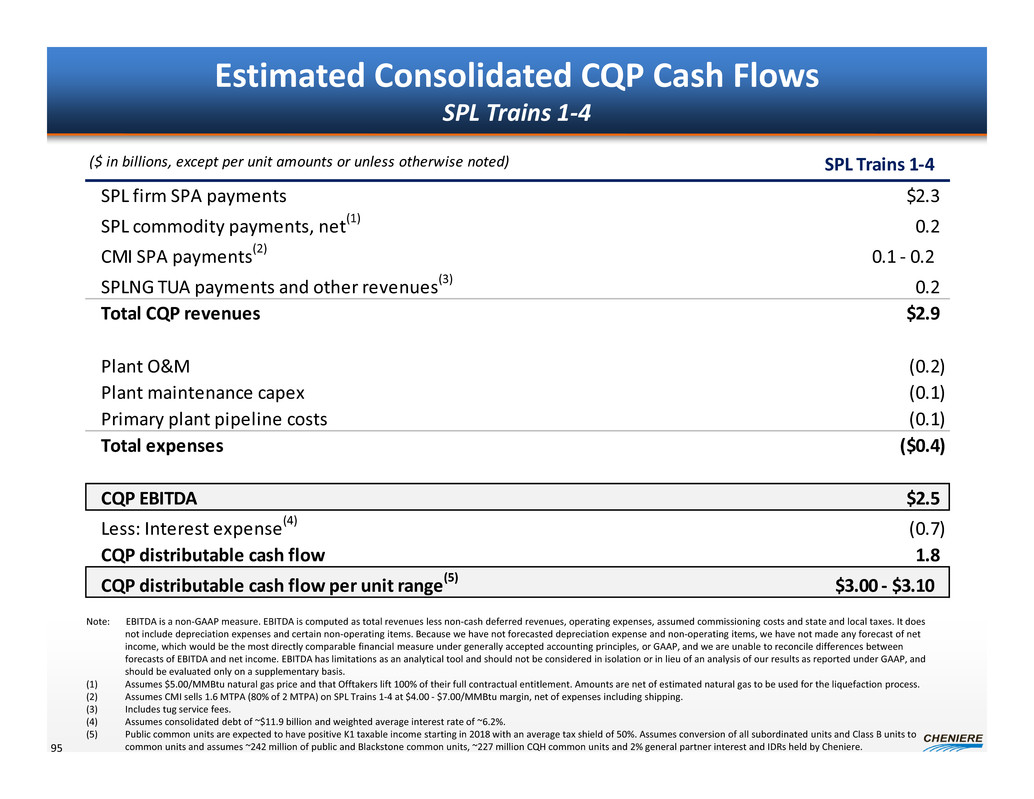

($ in billions, except per unit amounts or unless otherwise noted) SPL Trains 1‐4   SPL firm SPA payments $2.3   SPL commodity payments, net(1) 0.2   CMI SPA payments(2) 0.1 ‐ 0.2   SPLNG TUA payments and other revenues(3) 0.2   Total CQP revenues $2.9   Plant O&M (0.2)   Plant maintenance capex (0.1)   Primary plant pipeline costs (0.1)   Total expenses ($0.4)   CQP EBITDA $2.5   Less: Interest expense(4) (0.7)   CQP distributable cash flow 1.8   CQP distributable cash flow per unit range(5) $3.00 ‐ $3.10   Estimated Consolidated CQP Cash Flows   SPL Trains 1‐4   95   Note:     EBITDA is a non‐GAAP measure. EBITDA is computed as total revenues less non‐cash deferred revenues, operating expenses, assumed commissioning costs and state and local taxes. It does    not include depreciation expenses and certain non‐operating items. Because we have not forecasted depreciation expense and non‐operating items, we have not made any forecast of net    income, which would be the most directly comparable financial measure under generally accepted accounting principles, or GAAP, and we are unable to reconcile differences between    forecasts of EBITDA and net income. EBITDA has limitations as an analytical tool and should not be considered in isolation or in lieu of an analysis of our results as reported under GAAP, and    should be evaluated only on a supplementary basis.   (1)            Assumes $5.00/MMBtu natural gas price and that Offtakers lift 100% of their full contractual entitlement. Amounts are net of estimated natural gas to be used for the liquefaction process.   (2)            Assumes CMI sells 1.6 MTPA (80% of 2 MTPA) on SPL Trains 1‐4 at $4.00 ‐ $7.00/MMBtu margin, net of expenses including shipping.   (3)            Includes tug service fees.   (4)            Assumes consolidated debt of ~$11.9 billion and weighted average interest rate of ~6.2%.   (5)            Public common units are expected to have positive K1 taxable income starting in 2018 with an average tax shield of 50%. Assumes conversion of all subordinated units and Class B units to    common units and assumes ~242 million of public and Blackstone common units, ~227 million CQH common units and 2% general partner interest and IDRs held by Cheniere.

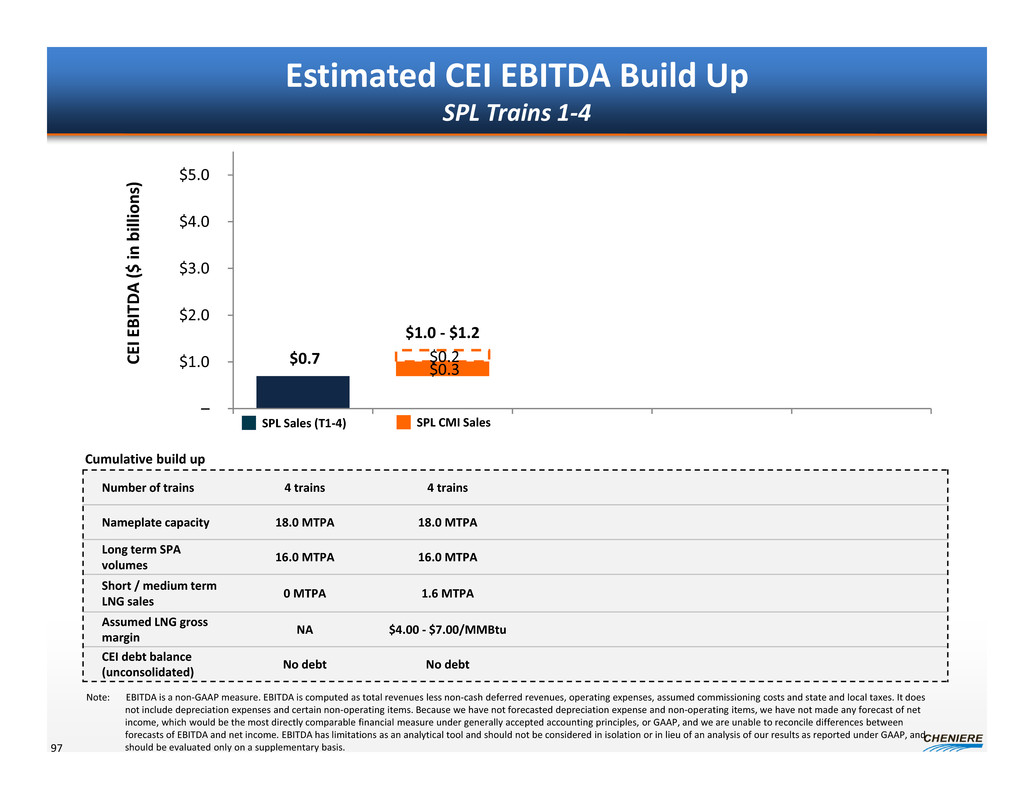

CEI EBITDA build up   ($ in billions, unless otherwise noted)   CQH distributions (based on 84.5% interest)(1) $0.6   GP and IDR distributions 0.3   Management fees 0.1   CMI profit share (after SPL SPA payment)(2) 0.2 ‐ 0.4   Total revenues $1.4   G&A and other capex (0.2)   Total expenses ($0.2)   CEI EBITDA $1.0 ‐ $1.2   Estimated CEI Cash Flows   SPL Trains 1‐4   96    $1.0 ‐ $1.2 billion of run‐rate EBITDA    CEI NOL exhausted in 2019 – 2020, depending on CMI profitability   Note:     EBITDA is a non‐GAAP measure. EBITDA is computed as total revenues less non‐cash deferred revenues, operating expenses, assumed commissioning costs and state and local taxes. It does    not include depreciation expenses and certain non‐operating items. Because we have not forecasted depreciation expense and non‐operating items, we have not made any forecast of net    income, which would be the most directly comparable financial measure under generally accepted accounting principles, or GAAP, and we are unable to reconcile differences between    forecasts of EBITDA and net income. EBITDA has limitations as an analytical tool and should not be considered in isolation or in lieu of an analysis of our results as reported under GAAP, and    should be evaluated only on a supplementary basis.   (1)            Prior to NOL exhaustion at CQH.   (2)            Assumes CMI sells  1.6 MTPA (80% of 2 MTPA) on SPL Trains 1‐4 at $4.00 ‐ $7.00/MMBtu margin, net of expenses including shipping.

$0.3     $0.2  $0.7     $1.0 ‐ $1.2   –    $1.0    $2.0    $3.0    $4.0    $5.0   C   E   I       E   B   I   T   D   A       (   $       i   n       b   i   l   l   i   o   n   s   )   Estimated CEI EBITDA Build Up   SPL Trains 1‐4   97   Number of trains 4 trains 4 trains   Nameplate capacity 18.0 MTPA 18.0 MTPA   Long term SPA   volumes   16.0 MTPA 16.0 MTPA   Short / medium term    LNG sales   0 MTPA 1.6 MTPA   Assumed LNG gross   margin   NA $4.00 ‐ $7.00/MMBtu   CEI debt balance    (unconsolidated)   No debt No debt   SPL Sales (T1‐4) SPL CMI Sales   Cumulative build up   Note:     EBITDA is a non‐GAAP measure. EBITDA is computed as total revenues less non‐cash deferred revenues, operating expenses, assumed commissioning costs and state and local taxes. It does    not include depreciation expenses and certain non‐operating items. Because we have not forecasted depreciation expense and non‐operating items, we have not made any forecast of net    income, which would be the most directly comparable financial measure under generally accepted accounting principles, or GAAP, and we are unable to reconcile differences between    forecasts of EBITDA and net income. EBITDA has limitations as an analytical tool and should not be considered in isolation or in lieu of an analysis of our results as reported under GAAP, and    should be evaluated only on a supplementary basis.

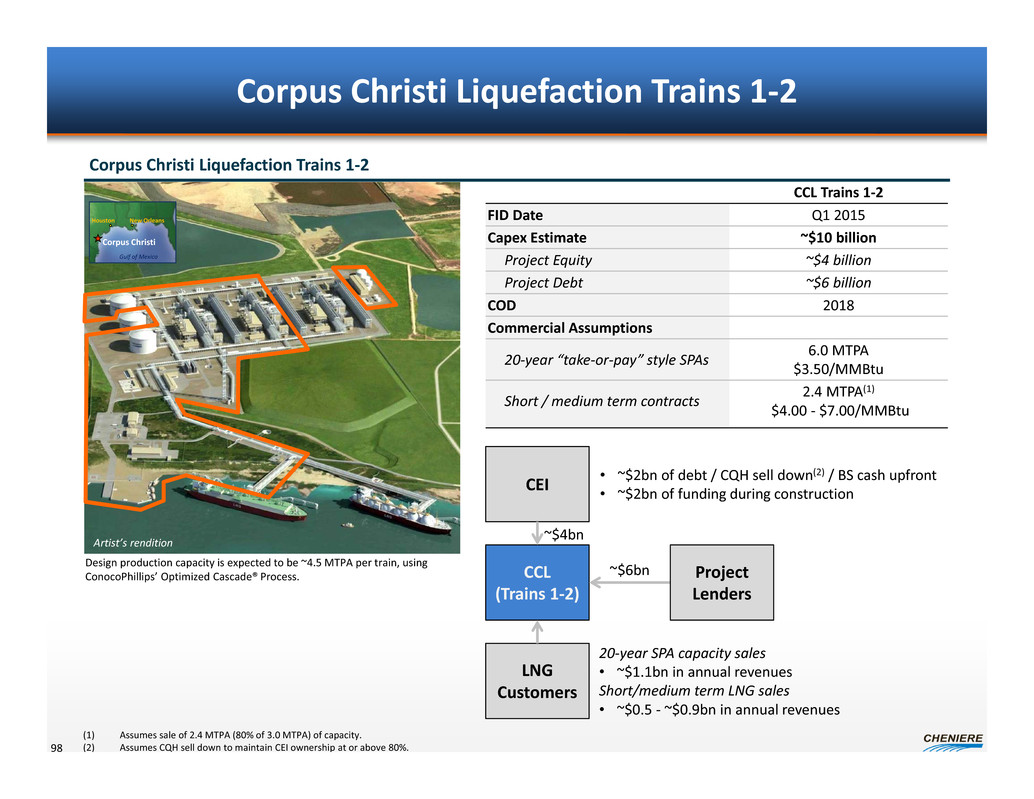

~$4bn   Corpus Christi Liquefaction Trains 1‐2   98   Corpus Christi Liquefaction Trains 1‐2   Design production capacity is expected to be ~4.5 MTPA per train, using    ConocoPhillips’ Optimized Cascade® Process.   CEI   CCL   (Trains 1‐2)   LNG    Customers   Project    Lenders   ~$6bn   CCL Trains 1‐2   FID Date Q1 2015   Capex Estimate ~$10 billion   Project Equity ~$4 billion   Project Debt ~$6 billion   COD 2018   Commercial Assumptions   20‐year “take‐or‐pay” style SPAs   6.0 MTPA    $3.50/MMBtu   Short / medium term contracts   2.4 MTPA(1)   $4.00 ‐ $7.00/MMBtu   (1)           Assumes sale of 2.4 MTPA (80% of 3.0 MTPA) of capacity.   (2)           Assumes CQH sell down to maintain CEI ownership at or above 80%.   20‐year SPA capacity sales   • ~$1.1bn in annual revenues   Short/medium term LNG sales    • ~$0.5 ‐ ~$0.9bn in annual revenues   • ~$2bn of debt / CQH sell down(2) / BS cash upfront   • ~$2bn of funding during construction   Houston New Orleans   Gulf of Mexico   Corpus Christi   Artist’s rendition

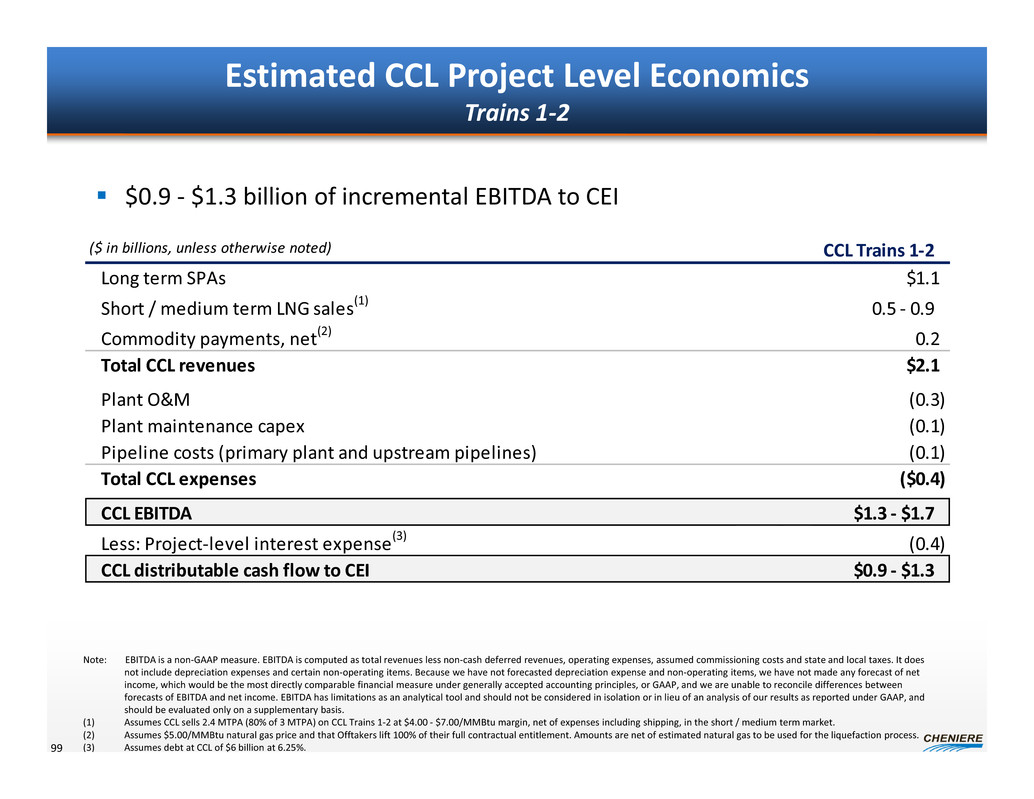

($ in billions, unless otherwise noted) CCL Trains 1‐2   Long term SPAs $1.1   Short / medium term LNG sales(1) 0.5 ‐ 0.9   Commodity payments, net(2) 0.2   Total CCL revenues $2.1   Plant O&M (0.3)   Plant maintenance capex (0.1)   Pipeline costs (primary plant and upstream pipelines) (0.1)   Total CCL expenses ($0.4)   CCL EBITDA $1.3 ‐ $1.7   Less: Project‐level interest expense(3) (0.4)   CCL distributable cash flow to CEI $0.9 ‐ $1.3   Estimated CCL Project Level Economics   Trains 1‐2   99   Note:        EBITDA is a non‐GAAP measure. EBITDA is computed as total revenues less non‐cash deferred revenues, operating expenses, assumed commissioning costs and state and local taxes. It does    not include depreciation expenses and certain non‐operating items. Because we have not forecasted depreciation expense and non‐operating items, we have not made any forecast of net                    income, which would be the most directly comparable financial measure under generally accepted accounting principles, or GAAP, and we are unable to reconcile differences between    forecasts of EBITDA and net income. EBITDA has limitations as an analytical tool and should not be considered in isolation or in lieu of an analysis of our results as reported under GAAP, and    should be evaluated only on a supplementary basis.   (1)             Assumes CCL sells 2.4 MTPA (80% of 3 MTPA) on CCL Trains 1‐2 at $4.00 ‐ $7.00/MMBtu margin, net of expenses including shipping, in the short / medium term market.    (2)             Assumes $5.00/MMBtu natural gas price and that Offtakers lift 100% of their full contractual entitlement. Amounts are net of estimated natural gas to be used for the liquefaction process.   (3)  Assumes debt at CCL of $6 billion at 6.25%.    $0.9 ‐ $1.3 billion of incremental EBITDA to CEI

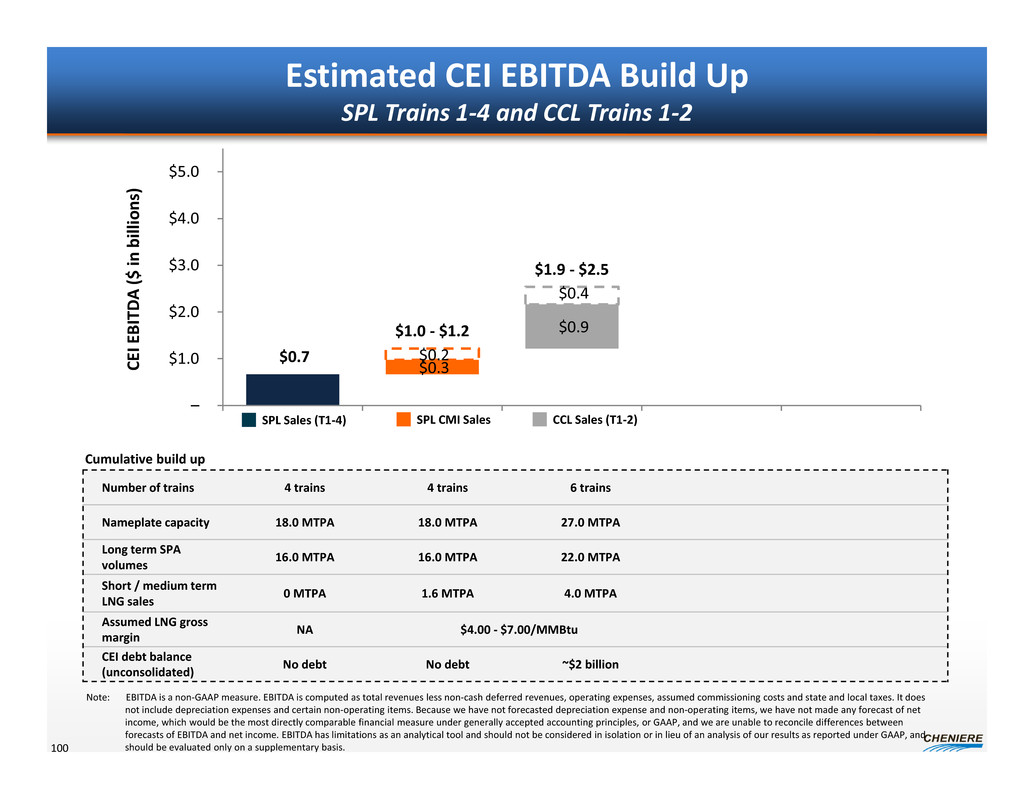

$0.3     $0.2     $0.9     $0.4     $0.7     $1.0 ‐ $1.2   $1.9 ‐ $2.5   –    $1.0    $2.0    $3.0    $4.0    $5.0   C   E   I       E   B   I   T   D   A       (   $       i   n       b   i   l   l   i   o   n   s   )   Estimated CEI EBITDA Build Up   SPL Trains 1‐4 and CCL Trains 1‐2   100   SPL Sales (T1‐4) SPL CMI Sales CCL Sales (T1‐2)   Number of trains 4 trains 4 trains 6 trains   Nameplate capacity 18.0 MTPA 18.0 MTPA 27.0 MTPA   Long term SPA   volumes   16.0 MTPA 16.0 MTPA 22.0 MTPA   Short / medium term    LNG sales   0 MTPA 1.6 MTPA 4.0 MTPA   Assumed LNG gross   margin   NA $4.00 ‐ $7.00/MMBtu   CEI debt balance    (unconsolidated)   No debt No debt ~$2 billion   Cumulative build up   Note:     EBITDA is a non‐GAAP measure. EBITDA is computed as total revenues less non‐cash deferred revenues, operating expenses, assumed commissioning costs and state and local taxes. It does    not include depreciation expenses and certain non‐operating items. Because we have not forecasted depreciation expense and non‐operating items, we have not made any forecast of net    income, which would be the most directly comparable financial measure under generally accepted accounting principles, or GAAP, and we are unable to reconcile differences between    forecasts of EBITDA and net income. EBITDA has limitations as an analytical tool and should not be considered in isolation or in lieu of an analysis of our results as reported under GAAP, and    should be evaluated only on a supplementary basis.

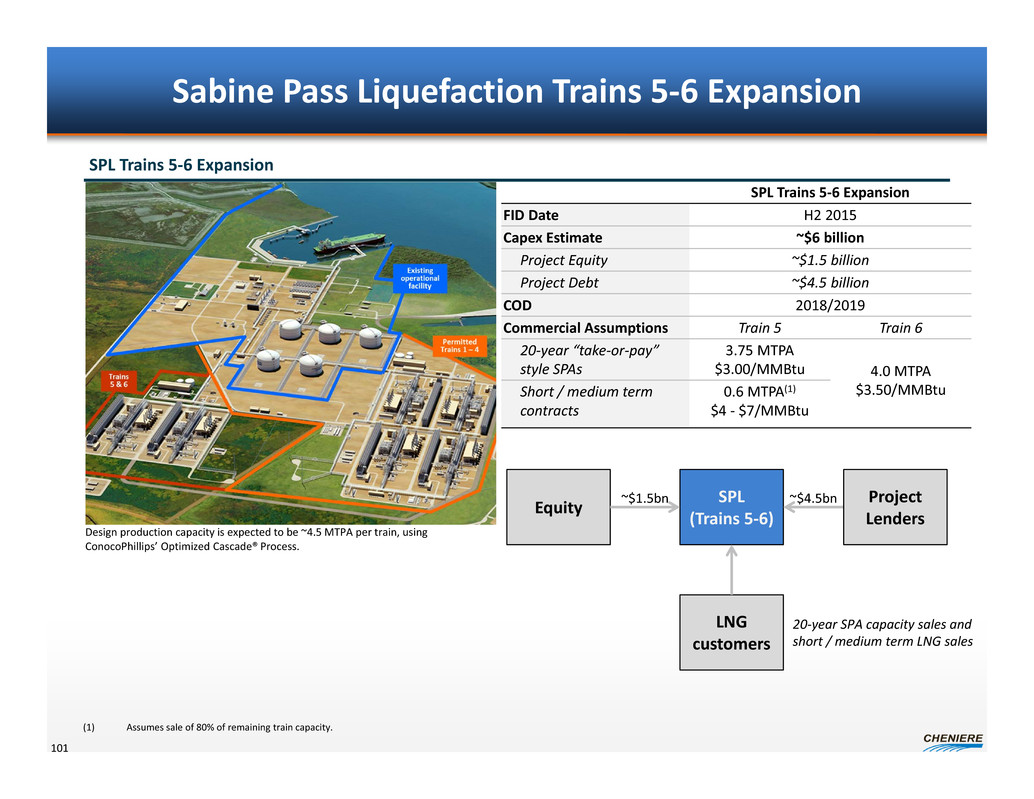

Sabine Pass Liquefaction Trains 5‐6 Expansion   101   SPL Trains 5‐6 Expansion   SPL Trains 5‐6 Expansion   FID Date H2 2015   Capex Estimate ~$6 billion   Project Equity ~$1.5 billion   Project Debt ~$4.5 billion   COD 2018/2019   Commercial Assumptions Train 5 Train 6   20‐year “take‐or‐pay”    style SPAs   3.75 MTPA   $3.00/MMBtu 4.0 MTPA    $3.50/MMBtu Short / medium term    contracts   0.6 MTPA(1)   $4 ‐ $7/MMBtu   Equity   SPL    (Trains 5‐6)   LNG    customers   Project    Lenders   ~$4.5bn~$1.5bn   20‐year SPA capacity sales and    short / medium term LNG sales   (1)              Assumes sale of 80% of remaining train capacity.    Design production capacity is expected to be ~4.5 MTPA per train, using    ConocoPhillips’ Optimized Cascade® Process.

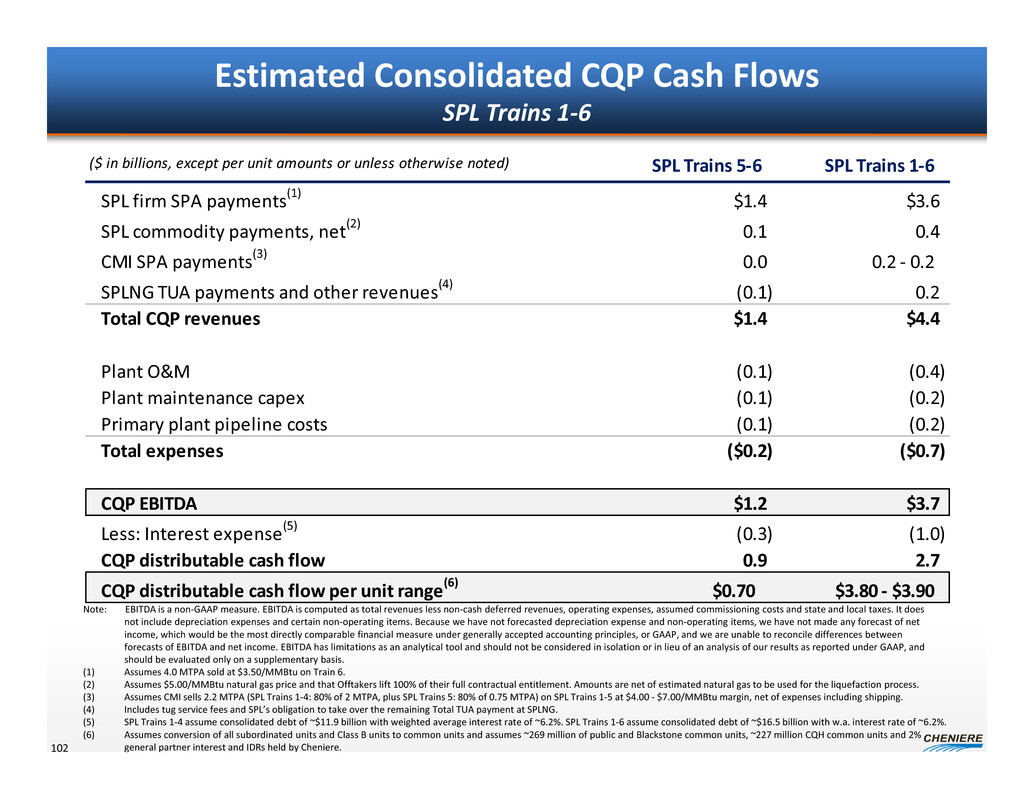

($ in billions, except per unit amounts or unless otherwise noted) SPL Trains 5‐6 SPL Trains 1‐6   SPL firm SPA payments(1) $1.4 $3.6   SPL commodity payments, net(2) 0.1 0.4   CMI SPA payments(3) 0.0 0.2 ‐ 0.2   SPLNG TUA payments and other revenues(4) (0.1) 0.2   Total CQP revenues $1.4 $4.4   Plant O&M (0.1) (0.4)   Plant maintenance capex (0.1) (0.2)   Primary plant pipeline costs (0.1) (0.2)   Total expenses ($0.2) ($0.7)   CQP EBITDA $1.2 $3.7   Less: Interest expense(5) (0.3) (1.0)   CQP distributable cash flow 0.9 2.7   CQP distributable cash flow per unit range(6) $0.70 $3.80 ‐ $3.90   Estimated Consolidated CQP Cash Flows   SPL Trains 1‐6   102   Note:        EBITDA is a non‐GAAP measure. EBITDA is computed as total revenues less non‐cash deferred revenues, operating expenses, assumed commissioning costs and state and local taxes. It does    not include depreciation expenses and certain non‐operating items. Because we have not forecasted depreciation expense and non‐operating items, we have not made any forecast of net                    income, which would be the most directly comparable financial measure under generally accepted accounting principles, or GAAP, and we are unable to reconcile differences between    forecasts of EBITDA and net income. EBITDA has limitations as an analytical tool and should not be considered in isolation or in lieu of an analysis of our results as reported under GAAP, and    should be evaluated only on a supplementary basis.   (1)             Assumes 4.0 MTPA sold at $3.50/MMBtu on Train 6.   (2)             Assumes $5.00/MMBtu natural gas price and that Offtakers lift 100% of their full contractual entitlement. Amounts are net of estimated natural gas to be used for the liquefaction process.   (3)             Assumes CMI sells 2.2 MTPA (SPL Trains 1‐4: 80% of 2 MTPA, plus SPL Trains 5: 80% of 0.75 MTPA) on SPL Trains 1‐5 at $4.00 ‐ $7.00/MMBtu margin, net of expenses including shipping.   (4)             Includes tug service fees and SPL’s obligation to take over the remaining Total TUA payment at SPLNG.   (5)             SPL Trains 1‐4 assume consolidated debt of ~$11.9 billion with weighted average interest rate of ~6.2%. SPL Trains 1‐6 assume consolidated debt of ~$16.5 billion with w.a. interest rate of ~6.2%.   (6)             Assumes conversion of all subordinated units and Class B units to common units and assumes ~269 million of public and Blackstone common units, ~227 million CQH common units and 2%    general partner interest and IDRs held by Cheniere.

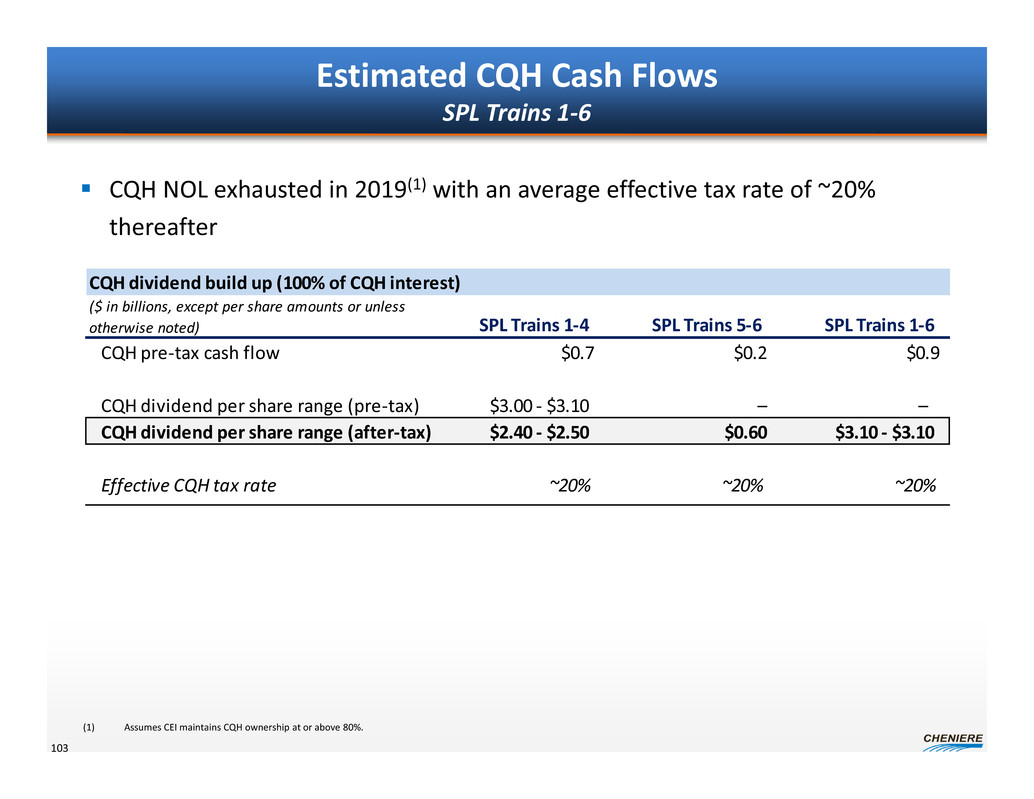

CQH dividend build up (100% of CQH interest)   SPL Trains 1‐4 SPL Trains 5‐6 SPL Trains 1‐6   CQH pre‐tax cash flow $0.7 $0.2 $0.9   CQH dividend per share range (pre‐tax) $3.00 ‐ $3.10 – –   CQH dividend per share range (after‐tax) $2.40 ‐ $2.50 $0.60 $3.10 ‐ $3.10   Effective CQH tax rate ~20% ~20% ~20%   ($ in billions, except per share amounts or unless    otherwise noted)   Estimated CQH Cash Flows   SPL Trains 1‐6   103    CQH NOL exhausted in 2019(1) with an average effective tax rate of ~20%    thereafter   (1)             Assumes CEI maintains CQH ownership at or above 80%.

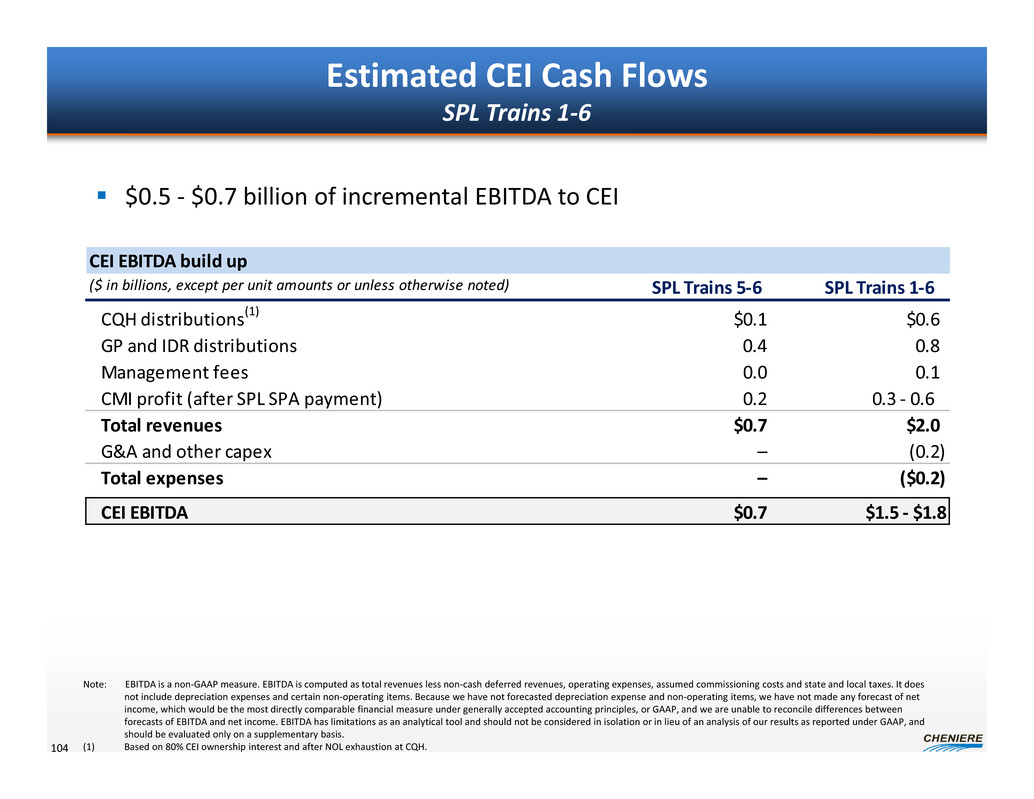

CEI EBITDA build up   ($ in billions, except per unit amounts or unless otherwise noted) SPL Trains 5‐6 SPL Trains 1‐6   CQH distributions(1) $0.1 $0.6   GP and IDR distributions 0.4 0.8   Management fees 0.0 0.1   CMI profit (after SPL SPA payment) 0.2 0.3 ‐ 0.6   Total revenues $0.7 $2.0   G&A and other capex – (0.2)   Total expenses – ($0.2)   CEI EBITDA $0.7 $1.5 ‐ $1.8   Estimated CEI Cash Flows   SPL Trains 1‐6   104   Note:        EBITDA is a non‐GAAP measure. EBITDA is computed as total revenues less non‐cash deferred revenues, operating expenses, assumed commissioning costs and state and local taxes. It does    not include depreciation expenses and certain non‐operating items. Because we have not forecasted depreciation expense and non‐operating items, we have not made any forecast of net                    income, which would be the most directly comparable financial measure under generally accepted accounting principles, or GAAP, and we are unable to reconcile differences between    forecasts of EBITDA and net income. EBITDA has limitations as an analytical tool and should not be considered in isolation or in lieu of an analysis of our results as reported under GAAP, and    should be evaluated only on a supplementary basis.   (1)             Based on 80% CEI ownership interest and after NOL exhaustion at CQH.    $0.5 ‐ $0.7 billion of incremental EBITDA to CEI

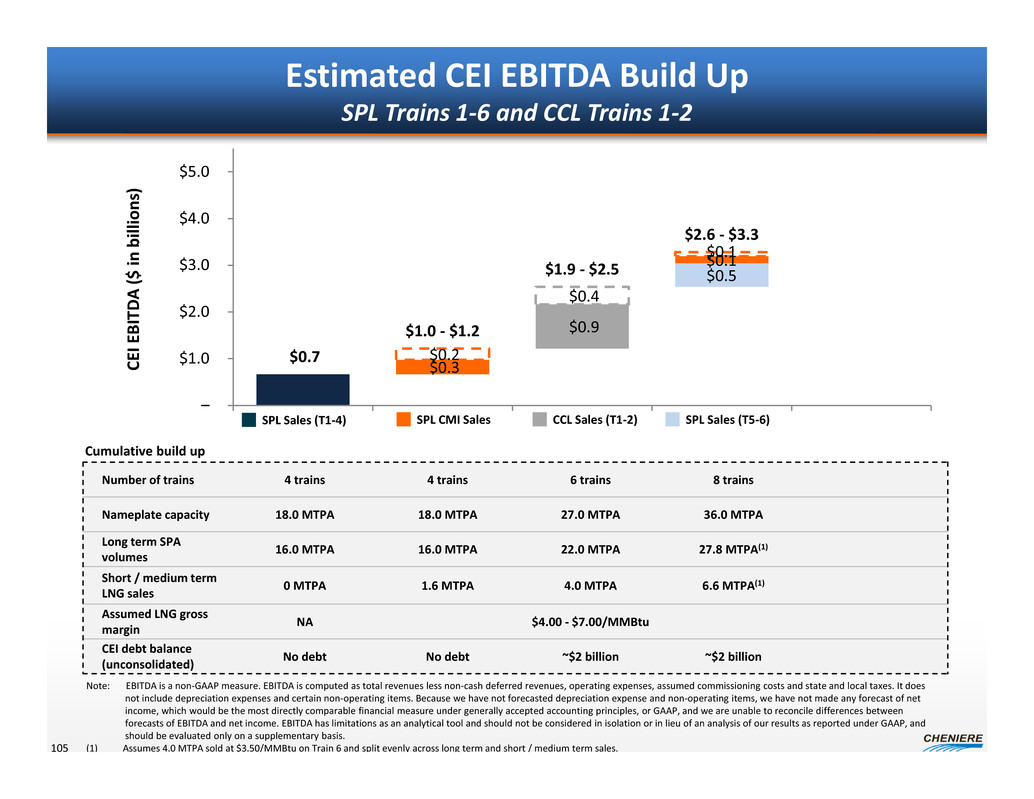

$0.3     $0.2     $0.9     $0.4     $0.5    $0.1 $0.1    $0.7     $1.0 ‐ $1.2   $1.9 ‐ $2.5   $2.6 ‐ $3.3   –    $1.0    $2.0    $3.0    $4.0    $5.0   C   E   I       E   B   I   T   D   A       (   $       i   n       b   i   l   l   i   o   n   s   )   Estimated CEI EBITDA Build Up   SPL Trains 1‐6 and CCL Trains 1‐2   105   SPL Sales (T1‐4) SPL CMI Sales CCL Sales (T1‐2) SPL Sales (T5‐6)   Number of trains 4 trains 4 trains 6 trains 8 trains   Nameplate capacity 18.0 MTPA 18.0 MTPA 27.0 MTPA 36.0 MTPA   Long term SPA   volumes   16.0 MTPA 16.0 MTPA 22.0 MTPA 27.8 MTPA(1)   Short / medium term    LNG sales   0 MTPA 1.6 MTPA 4.0 MTPA 6.6 MTPA(1)   Assumed LNG gross   margin   NA $4.00 ‐ $7.00/MMBtu   CEI debt balance    (unconsolidated)   No debt No debt ~$2 billion ~$2 billion   Cumulative build up   Note:     EBITDA is a non‐GAAP measure. EBITDA is computed as total revenues less non‐cash deferred revenues, operating expenses, assumed commissioning costs and state and local taxes. It does    not include depreciation expenses and certain non‐operating items. Because we have not forecasted depreciation expense and non‐operating items, we have not made any forecast of net    income, which would be the most directly comparable financial measure under generally accepted accounting principles, or GAAP, and we are unable to reconcile differences between    forecasts of EBITDA and net income. EBITDA has limitations as an analytical tool and should not be considered in isolation or in lieu of an analysis of our results as reported under GAAP, and    should be evaluated only on a supplementary basis.   (1)           Assumes 4.0 MTPA sold at $3.50/MMBtu on Train 6 and split evenly across long term and short / medium term sales.

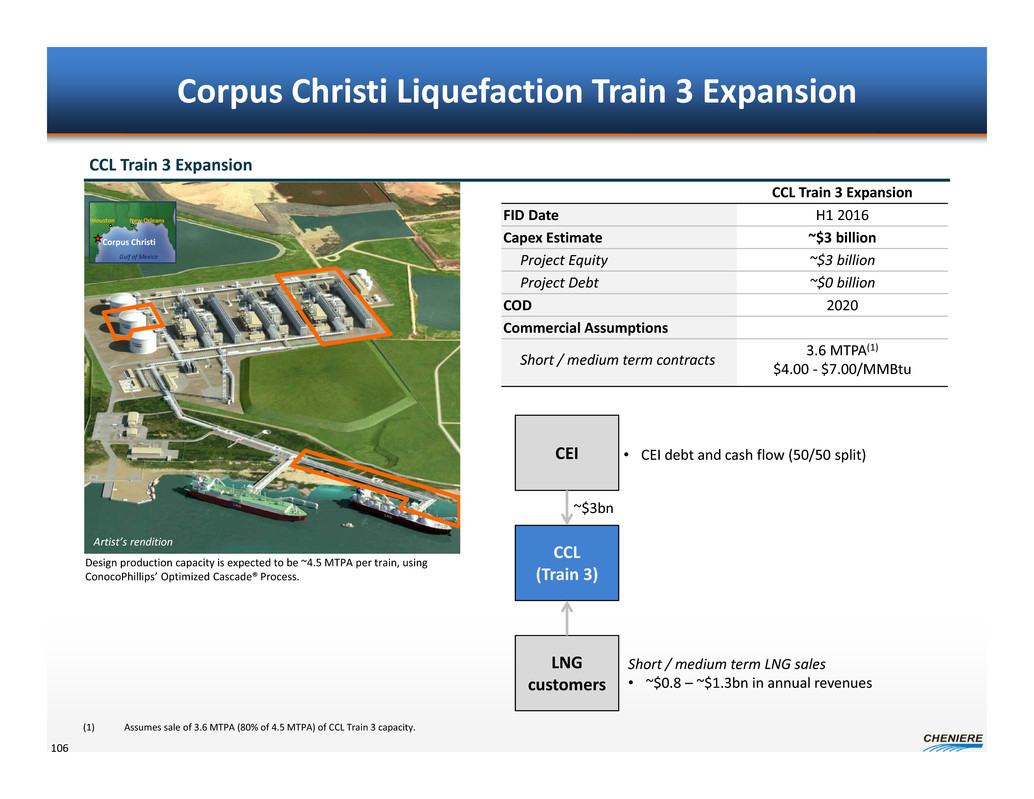

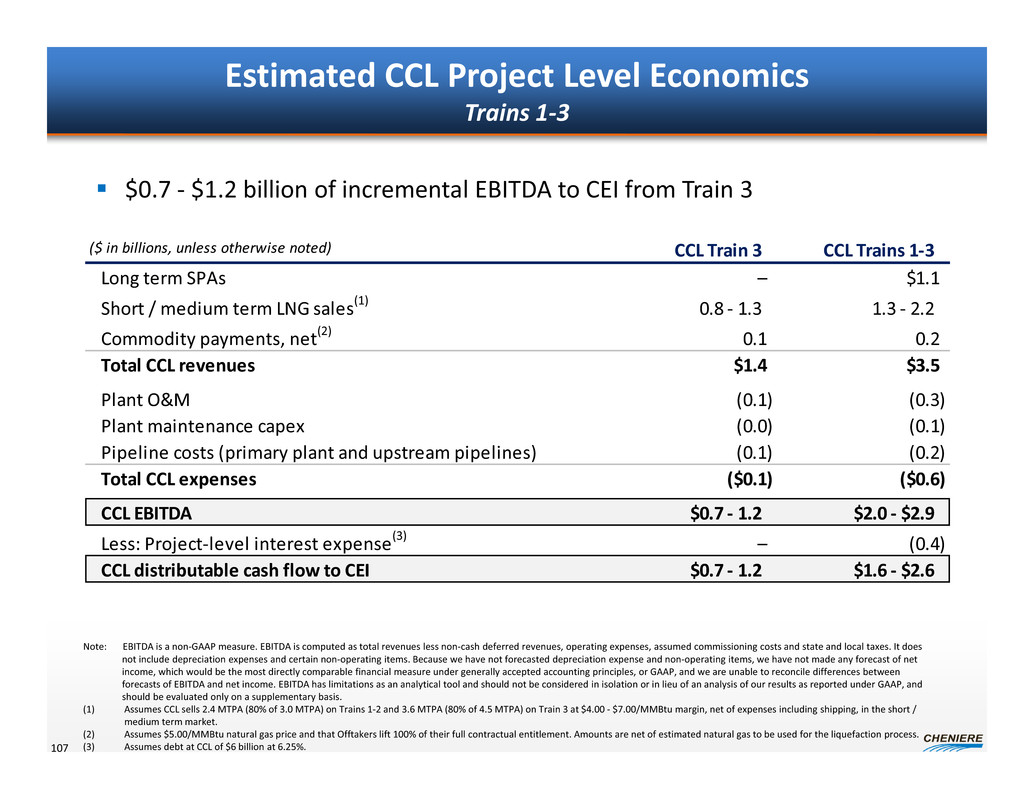

Corpus Christi Liquefaction Train 3 Expansion   106   CCL Train 3 Expansion   Design production capacity is expected to be ~4.5 MTPA per train, using    ConocoPhillips’ Optimized Cascade® Process.   CCL Train 3 Expansion   FID Date H1 2016   Capex Estimate ~$3 billion   Project Equity ~$3 billion   Project Debt ~$0 billion   COD 2020   Commercial Assumptions   Short / medium term contracts   3.6 MTPA(1)   $4.00 ‐ $7.00/MMBtu   CEI   CCL    (Train 3)   LNG    customers   ~$3bn   • CEI debt and cash flow (50/50 split)   Short / medium term LNG sales   • ~$0.8 – ~$1.3bn in annual revenues   (1)             Assumes sale of 3.6 MTPA (80% of 4.5 MTPA) of CCL Train 3 capacity.    Artist’s rendition   Houston New Orleans   Gulf of Mexico   Corpus Christi

($ in billions, unless otherwise noted) CCL Train 3 CCL Trains 1‐3   Long term SPAs – $1.1   Short / medium term LNG sales(1) 0.8 ‐ 1.3 1.3 ‐ 2.2   Commodity payments, net(2) 0.1 0.2   Total CCL revenues $1.4 $3.5   Plant O&M (0.1) (0.3)   Plant maintenance capex (0.0) (0.1)   Pipeline costs (primary plant and upstream pipelines) (0.1) (0.2)   Total CCL expenses ($0.1) ($0.6)   CCL EBITDA $0.7 ‐ 1.2 $2.0 ‐ $2.9   Less: Project‐level interest expense(3) – (0.4)   CCL distributable cash flow to CEI $0.7 ‐ 1.2 $1.6 ‐ $2.6   Estimated CCL Project Level Economics   Trains 1‐3   107   Note:       EBITDA is a non‐GAAP measure. EBITDA is computed as total revenues less non‐cash deferred revenues, operating expenses, assumed commissioning costs and state and local taxes. It does    not include depreciation expenses and certain non‐operating items. Because we have not forecasted depreciation expense and non‐operating items, we have not made any forecast of net                    income, which would be the most directly comparable financial measure under generally accepted accounting principles, or GAAP, and we are unable to reconcile differences between    forecasts of EBITDA and net income. EBITDA has limitations as an analytical tool and should not be considered in isolation or in lieu of an analysis of our results as reported under GAAP, and    should be evaluated only on a supplementary basis.   (1)             Assumes CCL sells 2.4 MTPA (80% of 3.0 MTPA) on Trains 1‐2 and 3.6 MTPA (80% of 4.5 MTPA) on Train 3 at $4.00 ‐ $7.00/MMBtu margin, net of expenses including shipping, in the short /    medium term market.   (2)             Assumes $5.00/MMBtu natural gas price and that Offtakers lift 100% of their full contractual entitlement. Amounts are net of estimated natural gas to be used for the liquefaction process.   (3)  Assumes debt at CCL of $6 billion at 6.25%.    $0.7 ‐ $1.2 billion of incremental EBITDA to CEI from Train 3

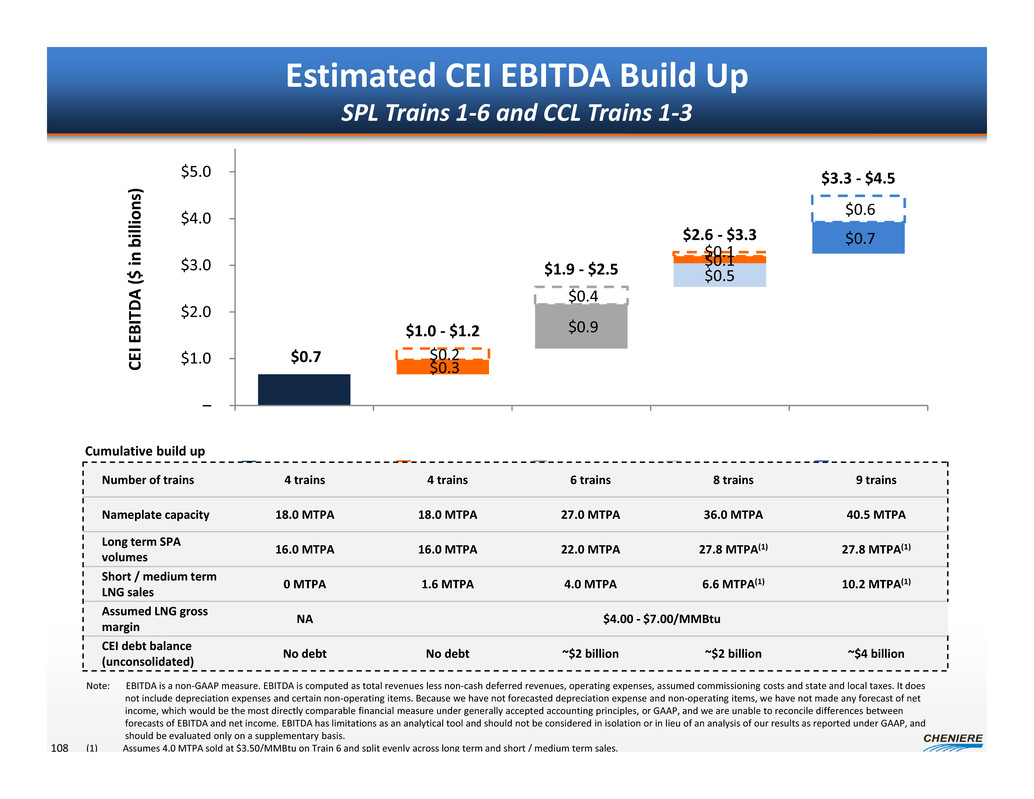

$0.3     $0.2     $0.9     $0.4     $0.5    $0.1 $0.1    $0.7     $0.6     $0.7     $1.0 ‐ $1.2   $1.9 ‐ $2.5   $2.6 ‐ $3.3   $3.3 ‐ $4.5   –    $1.0    $2.0    $3.0    $4.0    $5.0   C   E   I       E   B   I   T   D   A       (   $       i   n       b   i   l   l   i   o   n   s   )   Estimated CEI EBITDA Build Up   SPL Trains 1‐6 and CCL Trains 1‐3   108   SPL Sales (T1‐4) SPL CMI Sales CCL Sales (T1‐2) SPL Sales (T5‐6) CCL Sales (T3)   Number of trains 4 trains 4 trains 6 trains 8 trains 9 trains   Nameplate capacity 18.0 MTPA 18.0 MTPA 27.0 MTPA 36.0 MTPA 40.5 MTPA   Long term SPA   volumes   16.0 MTPA 16.0 MTPA 22.0 MTPA 27.8 MTPA(1) 27.8 MTPA(1)   Short / medium term    LNG sales   0 MTPA 1.6 MTPA 4.0 MTPA 6.6 MTPA(1) 10.2 MTPA(1)   Assumed LNG gross   margin   NA $4.00 ‐ $7.00/MMBtu   CEI debt balance    (unconsolidated)   No debt No debt ~$2 billion ~$2 billion ~$4 billion   Note:     EBITDA is a non‐GAAP measure. EBITDA is computed as total revenues less non‐cash deferred revenues, operating expenses, assumed commissioning costs and state and local taxes. It does    not include depreciation expenses and certain non‐operating items. Because we have not forecasted depreciation expense and non‐operating items, we have not made any forecast of net    income, which would be the most directly comparable financial measure under generally accepted accounting principles, or GAAP, and we are unable to reconcile differences between    forecasts of EBITDA and net income. EBITDA has limitations as an analytical tool and should not be considered in isolation or in lieu of an analysis of our results as reported under GAAP, and    should be evaluated only on a supplementary basis.   (1)           Assumes 4.0 MTPA sold at $3.50/MMBtu on Train 6 and split evenly across long term and short / medium term sales.   Cumulative build up

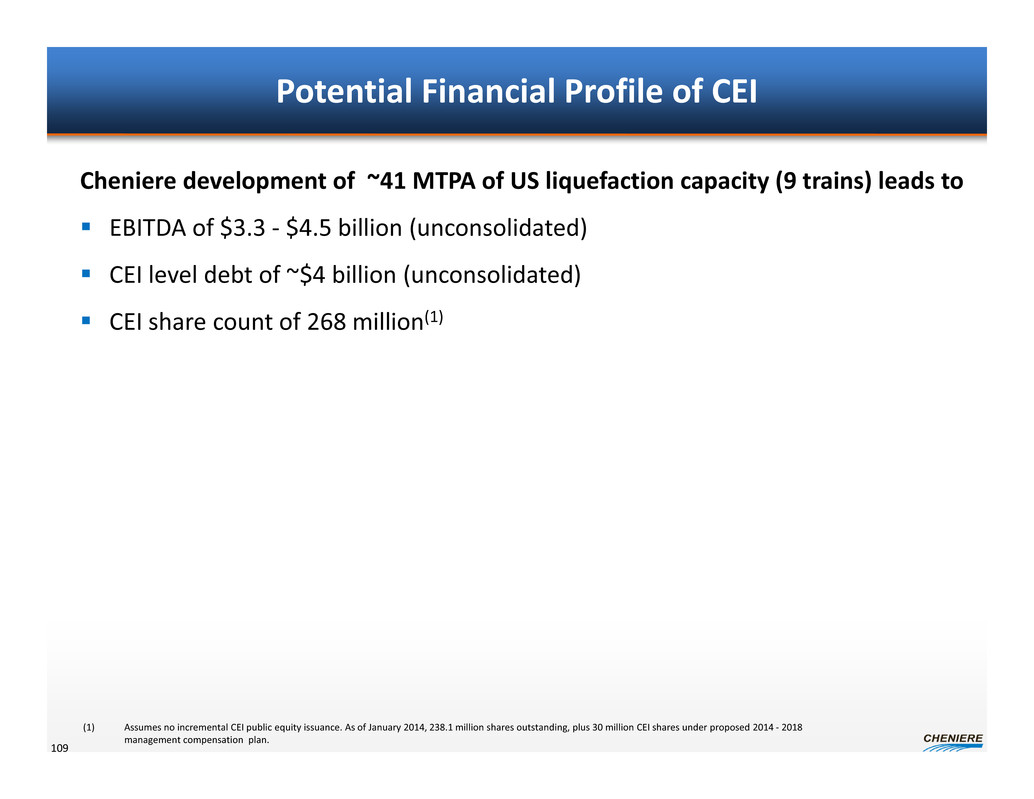

Potential Financial Profile of CEI   109   (1)             Assumes no incremental CEI public equity issuance. As of January 2014, 238.1 million shares outstanding, plus 30 million CEI shares under proposed 2014 ‐ 2018    management compensation  plan.    Cheniere development of  ~41 MTPA of US liquefaction capacity (9 trains) leads to    EBITDA of $3.3 ‐ $4.5 billion (unconsolidated)    CEI level debt of ~$4 billion (unconsolidated)    CEI share count of 268 million(1)

Strategic Update and LTIP   Analyst/ Investor Day   Charif Souki, President, Chairman and CEO   April 2014

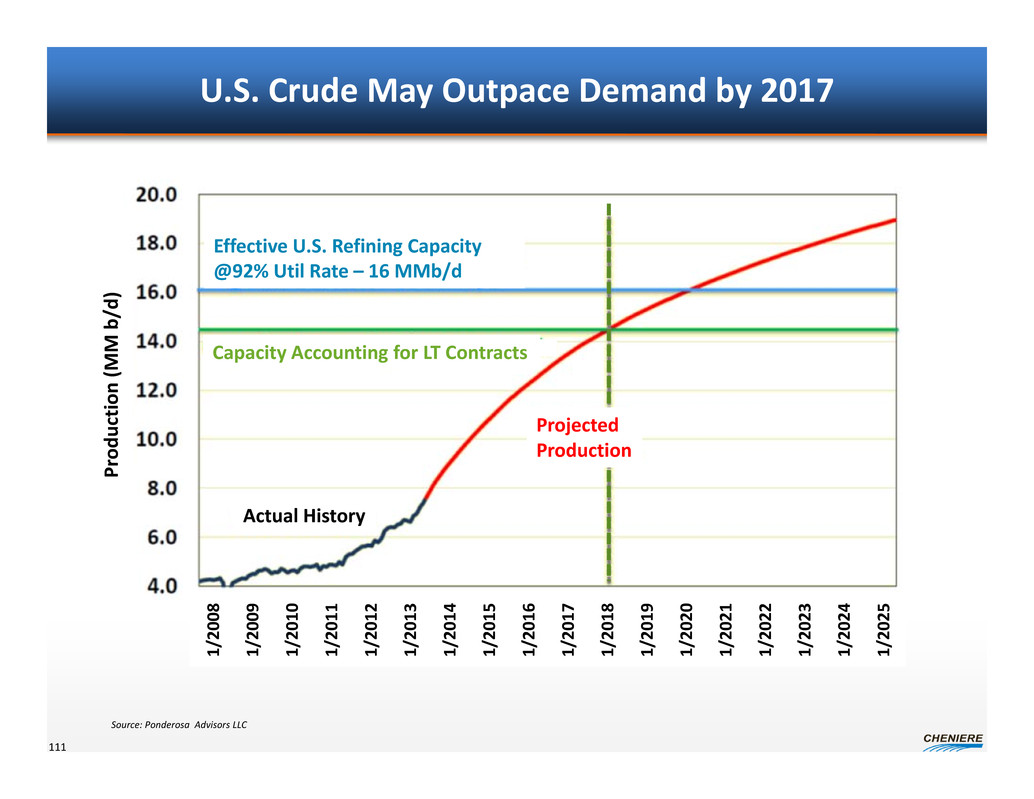

U.S. Crude May Outpace Demand by 2017   Source: Ponderosa  Advisors LLC   1   /   2   0   0   8   1   /   2   0   0   9   1   /   2   0   1   0   1   /   2   0   1   1   1   /   2   0   1   2   1   /   2   0   1   3   1   /   2   0   1   4   1   /   2   0   1   5   1   /   2   0   1   6   1   /   2   0   1   7   1   /   2   0   1   8   1   /   2   0   1   9   1   /   2   0   2   0   1   /   2   0   2   1   1   /   2   0   2   2   1   /   2   0   2   3   1   /   2   0   2   4   1   /   2   0   2   5   Effective U.S. Refining Capacity   @92% Util Rate – 16 MMb/d   Capacity Accounting for LT Contracts   Actual History   P   r   o   d   u   c   t   i   o   n       (   M   M       b   /   d   )   Projected   Production   111

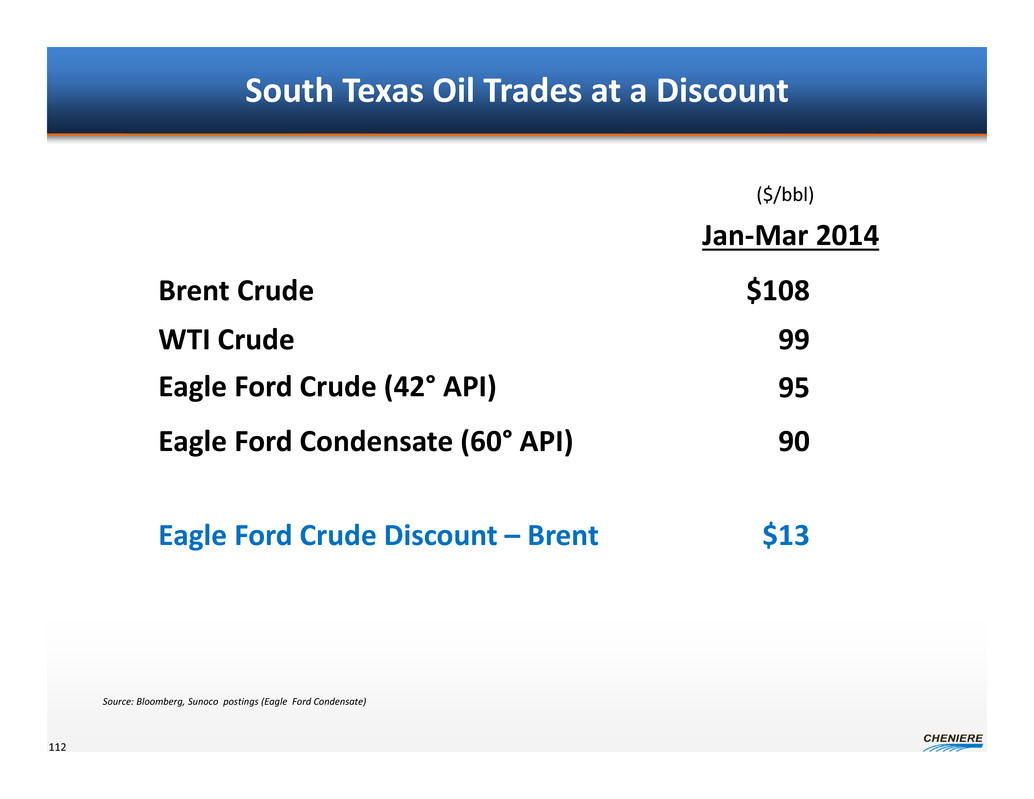

South Texas Oil Trades at a Discount   Jan‐Mar 2014   Eagle Ford Condensate (60° API)   ($/bbl)   90   Source: Bloomberg, Sunoco  postings (Eagle  Ford Condensate)    Eagle Ford Crude Discount – Brent   WTI Crude 99   Eagle Ford Crude (42° API) 95   $13   Brent Crude $108   112

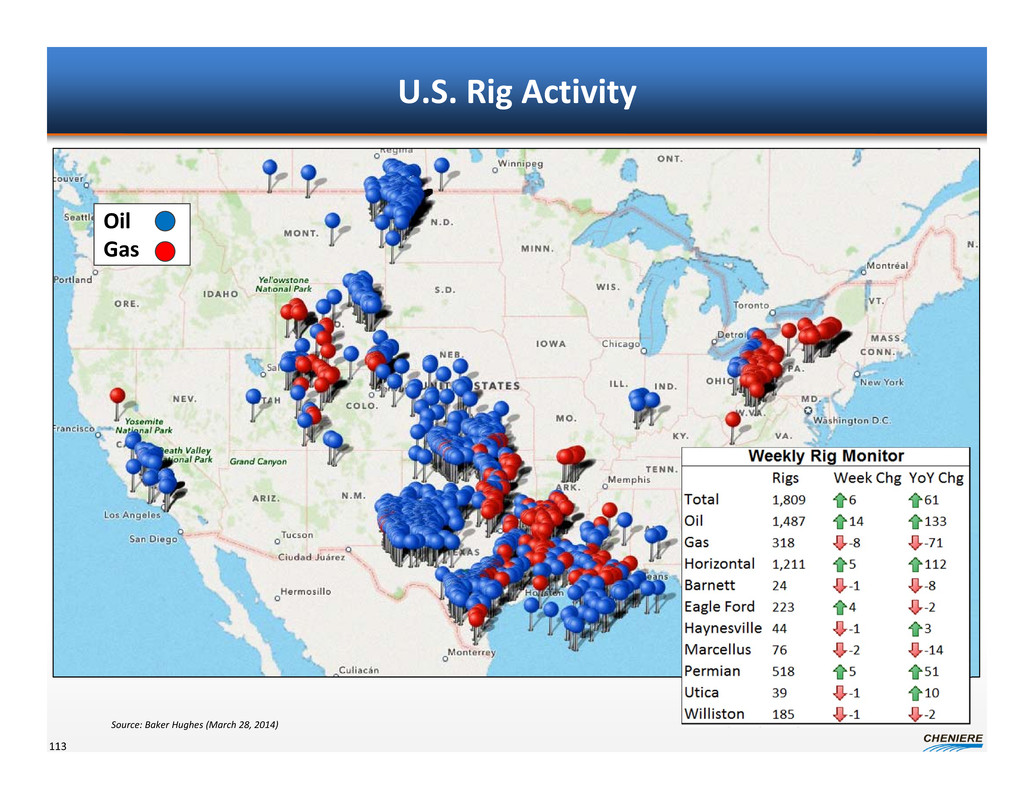

U.S. Rig Activity   113   Oil   Gas   Source: Baker Hughes (March 28, 2014)

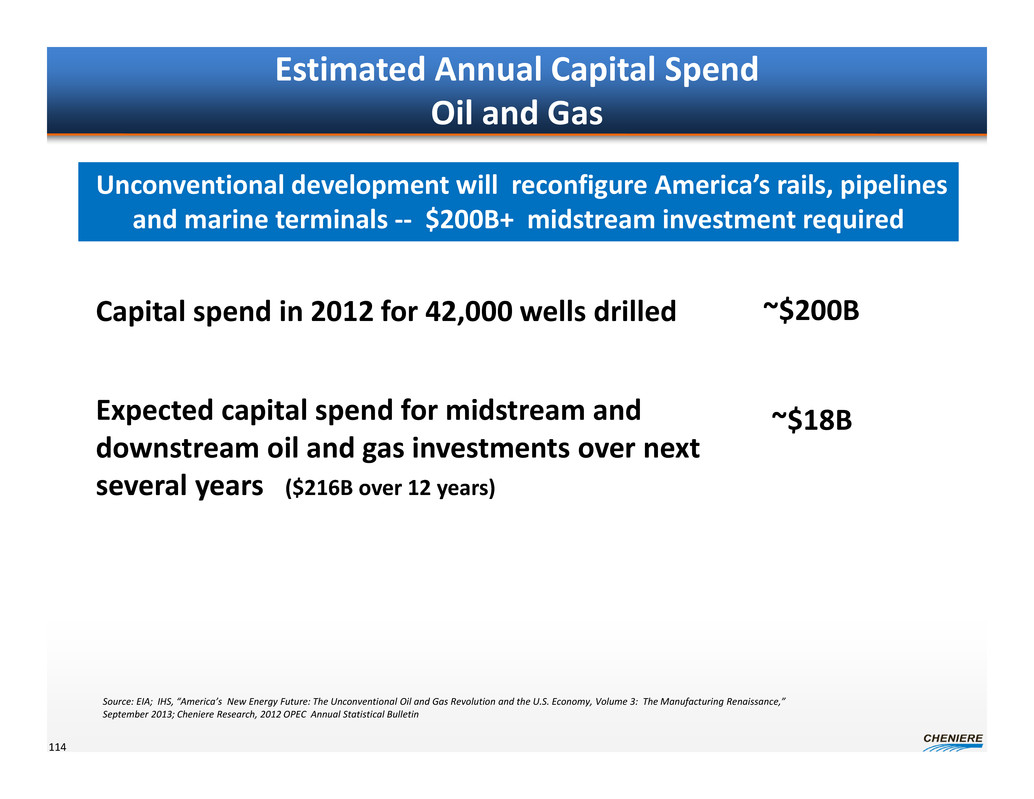

Capital spend in 2012 for 42,000 wells drilled  ~$200B   Expected capital spend for midstream and    downstream oil and gas investments over next    several years   ($216B over 12 years)     ~$18B   Source: EIA;  IHS, “America’s  New Energy Future: The Unconventional Oil and Gas Revolution and the U.S. Economy, Volume 3:  The Manufacturing Renaissance,”    September 2013; Cheniere Research, 2012 OPEC  Annual Statistical Bulletin   Estimated Annual Capital Spend   Oil and Gas   Unconventional development will  reconfigure America’s rails, pipelines    and marine terminals ‐‐ $200B+  midstream investment required   114

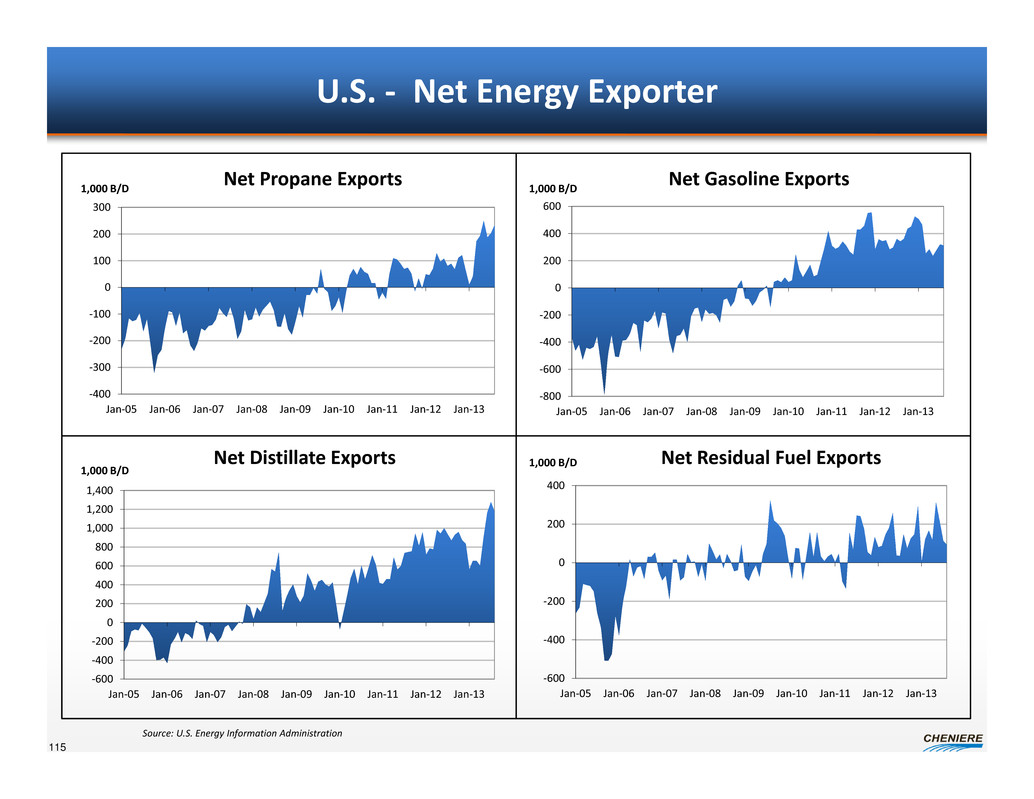

U.S. ‐ Net Energy Exporter   ‐400   ‐300   ‐200   ‐100   0   100   200   300   Jan‐05 Jan‐06 Jan‐07 Jan‐08 Jan‐09 Jan‐10 Jan‐11 Jan‐12 Jan‐13   ‐800   ‐600   ‐400   ‐200   0   200   400   600   Jan‐05 Jan‐06 Jan‐07 Jan‐08 Jan‐09 Jan‐10 Jan‐11 Jan‐12 Jan‐13   ‐600   ‐400   ‐200   0   200   400   600   800   1,000   1,200   1,400   Jan‐05 Jan‐06 Jan‐07 Jan‐08 Jan‐09 Jan‐10 Jan‐11 Jan‐12 Jan‐13   115   Net Propane Exports   1,000 B/D 1,000 B/D   Net Gasoline Exports   Net Distillate Exports   1,000 B/D   Net Residual Fuel Exports   Source: U.S. Energy Information Administration   ‐600   ‐400   ‐200   0   200   400   Jan‐05 Jan‐06 Jan‐07 Jan‐08 Jan‐09 Jan‐10 Jan‐11 Jan‐12 Jan‐13   1,000 B/D

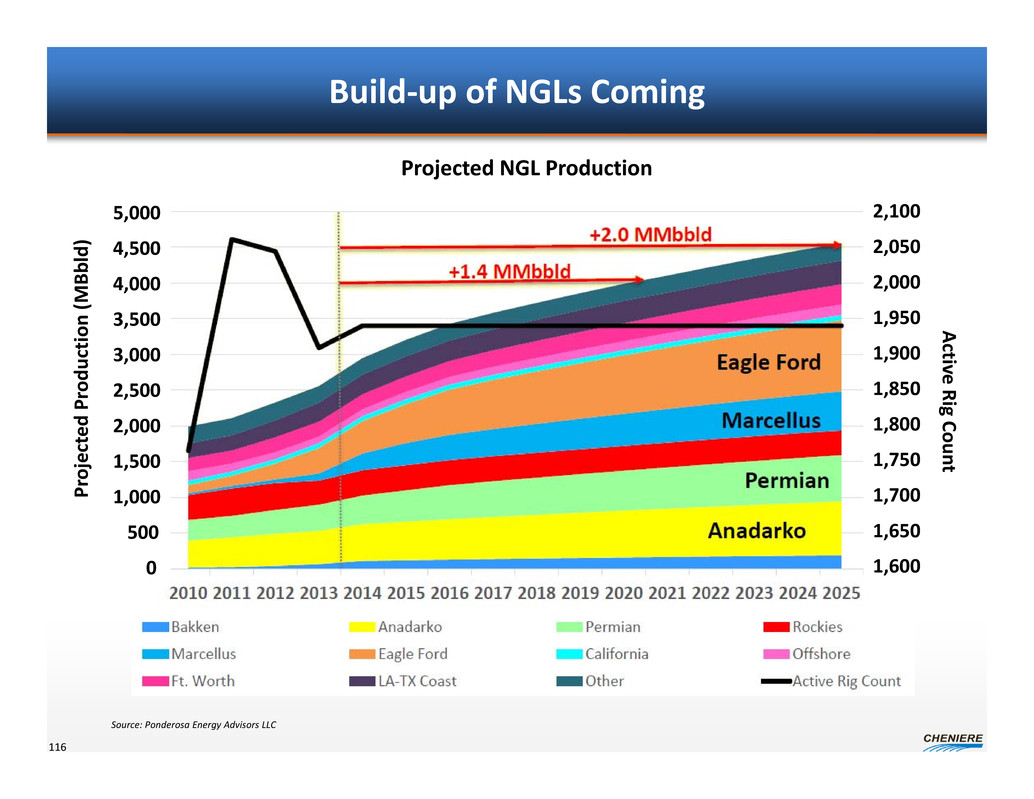

Build‐up of NGLs Coming   Source: Ponderosa Energy Advisors LLC   Projected NGL Production   5,000   4,500   4,000   3,500   3,000   2,500   2,000   1,500   1,000   500   0   P   r   o   j   e   c   t   e   d       P   r   o   d   u   c   t   i   o   n       (   M   B   b   l   d   )   A   ctive R   ig Count   2,100   2,050   2,000   1,950   1,900   1,850   1,800   1,750   1,700   1,650   1,600   116

In Summary    Expect 2‐3 MMBoe to be available for export based on current    drilling    Investment of $100‐$150B needed to support these exports     Domestically, no one is paying attention   117   U.S. will need new export infrastructure   Source: Cheniere estimates

Cheniere Strategy   118   2014:     De‐risk Corpus Christi   2015: De‐risk Sabine Pass T5 & 6   Focus on next high return opportunities

2014 ‐ 2018 LTI Plan

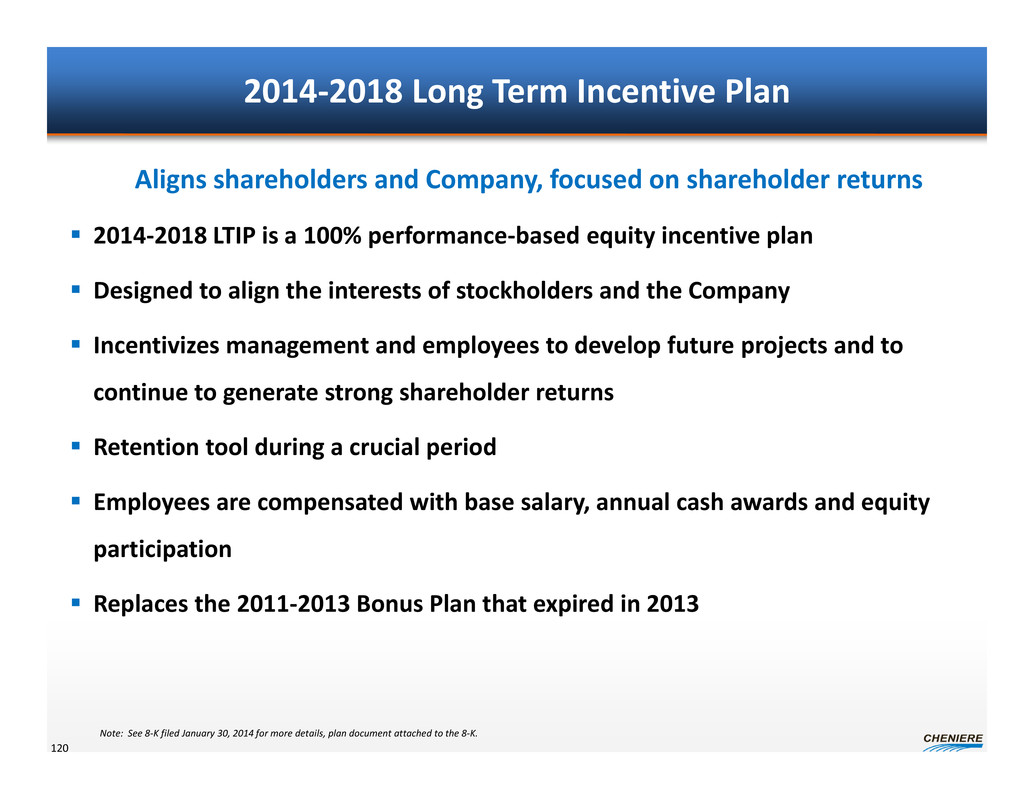

2014‐2018 Long Term Incentive Plan    2014‐2018 LTIP is a 100% performance‐based equity incentive plan     Designed to align the interests of stockholders and the Company      Incentivizes management and employees to develop future projects and to    continue to generate strong shareholder returns    Retention tool during a crucial period    Employees are compensated with base salary, annual cash awards and equity    participation    Replaces the 2011‐2013 Bonus Plan that expired in 2013    120   Aligns shareholders and Company, focused on shareholder returns   Note:  See 8‐K filed January 30, 2014 for more details, plan document attached to the 8‐K.

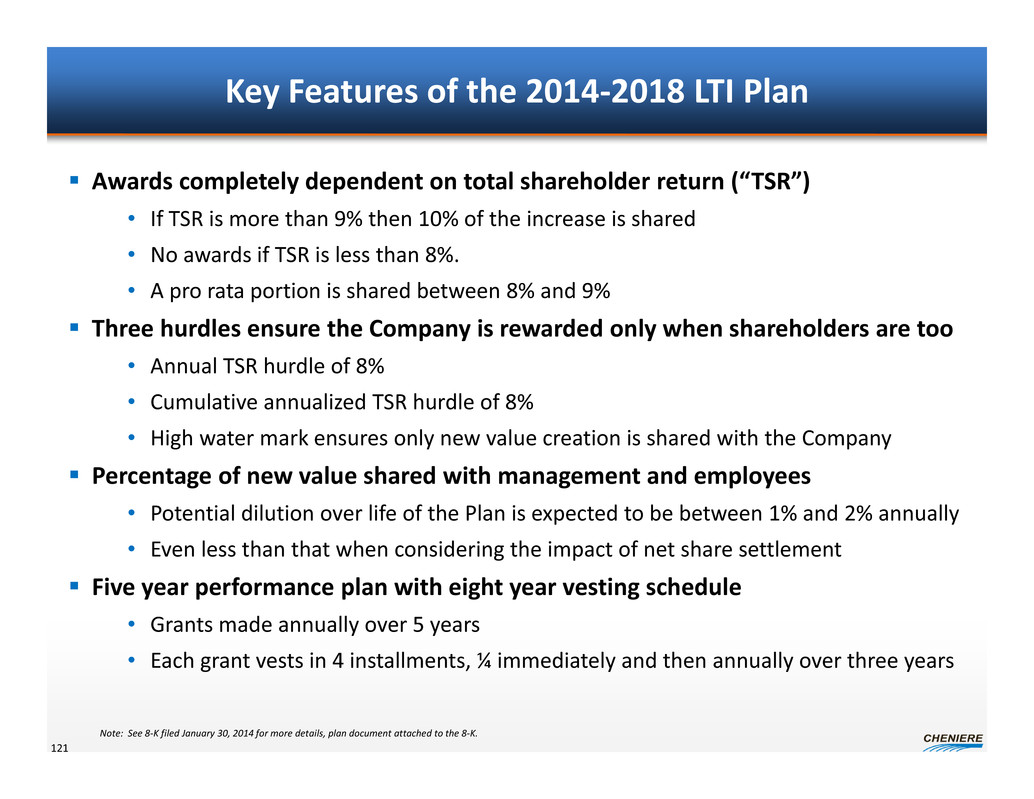

Key Features of the 2014‐2018 LTI Plan    Awards completely dependent on total shareholder return (“TSR”)   • If TSR is more than 9% then 10% of the increase is shared   • No awards if TSR is less than 8%.     • A pro rata portion is shared between 8% and 9%    Three hurdles ensure the Company is rewarded only when shareholders are too   • Annual TSR hurdle of 8%   • Cumulative annualized TSR hurdle of 8%    • High water mark ensures only new value creation is shared with the Company    Percentage of new value shared with management and employees    • Potential dilution over life of the Plan is expected to be between 1% and 2% annually    • Even less than that when considering the impact of net share settlement    Five year performance plan with eight year vesting schedule   • Grants made annually over 5 years   • Each grant vests in 4 installments, ¼ immediately and then annually over three years     121   Note:  See 8‐K filed January 30, 2014 for more details, plan document attached to the 8‐K.

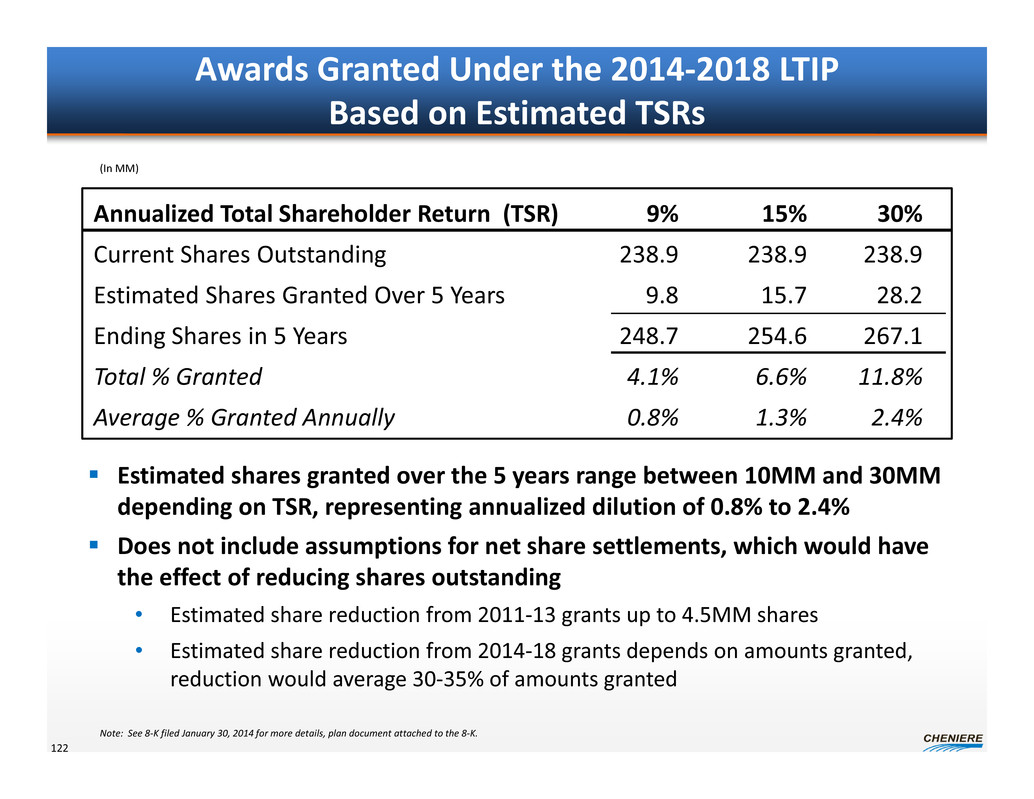

Awards Granted Under the 2014‐2018 LTIP   Based on Estimated TSRs   122    Estimated shares granted over the 5 years range between 10MM and 30MM    depending on TSR, representing annualized dilution of 0.8% to 2.4%    Does not include assumptions for net share settlements, which would have    the effect of reducing shares outstanding   • Estimated share reduction from 2011‐13 grants up to 4.5MM shares   • Estimated share reduction from 2014‐18 grants depends on amounts granted,    reduction would average 30‐35% of amounts granted   Annualized Total Shareholder Return (TSR) 9% 15% 30%   Current Shares Outstanding 238.9 238.9 238.9   Estimated Shares Granted Over 5 Years 9.8 15.7 28.2   Ending Shares in 5 Years 248.7 254.6 267.1   Total % Granted 4.1% 6.6% 11.8%   Average % Granted Annually 0.8% 1.3% 2.4%   (In MM)   Note:  See 8‐K filed January 30, 2014 for more details, plan document attached to the 8‐K.
